In the bustle of Whitefield, Vaswani Menlo Park is an oasis of calm that combines the best of city amenities and country living. Located in the heart of the IT belt, with top-notch schools in the neighbourhood, and the best stores a stone’s throw away, Vaswani Menlo Park is the perfect base for every person in the family.
Our one, two- and three-bedroom apartments stretch to meet every need of yours, whether essential or entertainment. Take a leisurely swim in the resort-style pool. Lift, stretch or train for a marathon at the gym. Play a game of badminton or cricket with the kids. Watch your parents make friends and thrive in spaces customized for senior citizens.
As working from home becomes a new reality, Vaswani Menlo Park anticipates some of your needs. Vaswani HomeworX – our concept of quiet spaces in your apartment clubhouse that are conducive to working from the comfort of your home. Learning pods for kids to get their homework done. Private corner home offices built into our two & three-bedroom homes. Vaswani Menlo Park is equipped to help you handle the most unexpected circumstances.
If happiness were defined as the freedom to live your life the way you want to, Vaswani Menlo Park is your address of happiness.

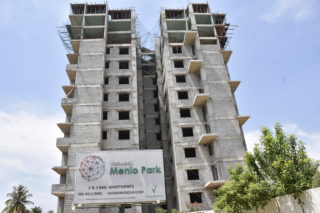

Project Highlights:
RERA Registration No. PRM/KA/RERA/1251/446/PR/171015/000854

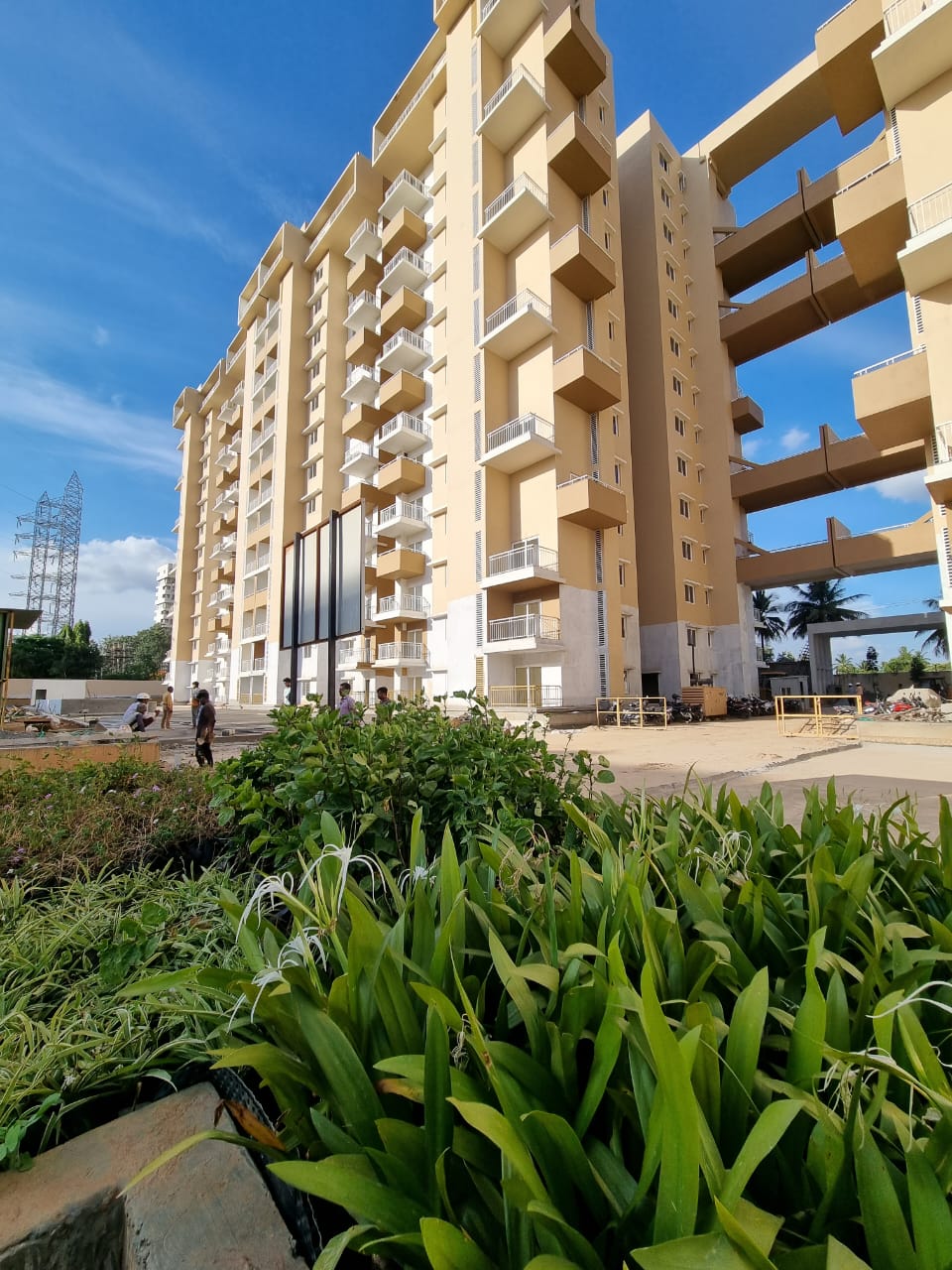

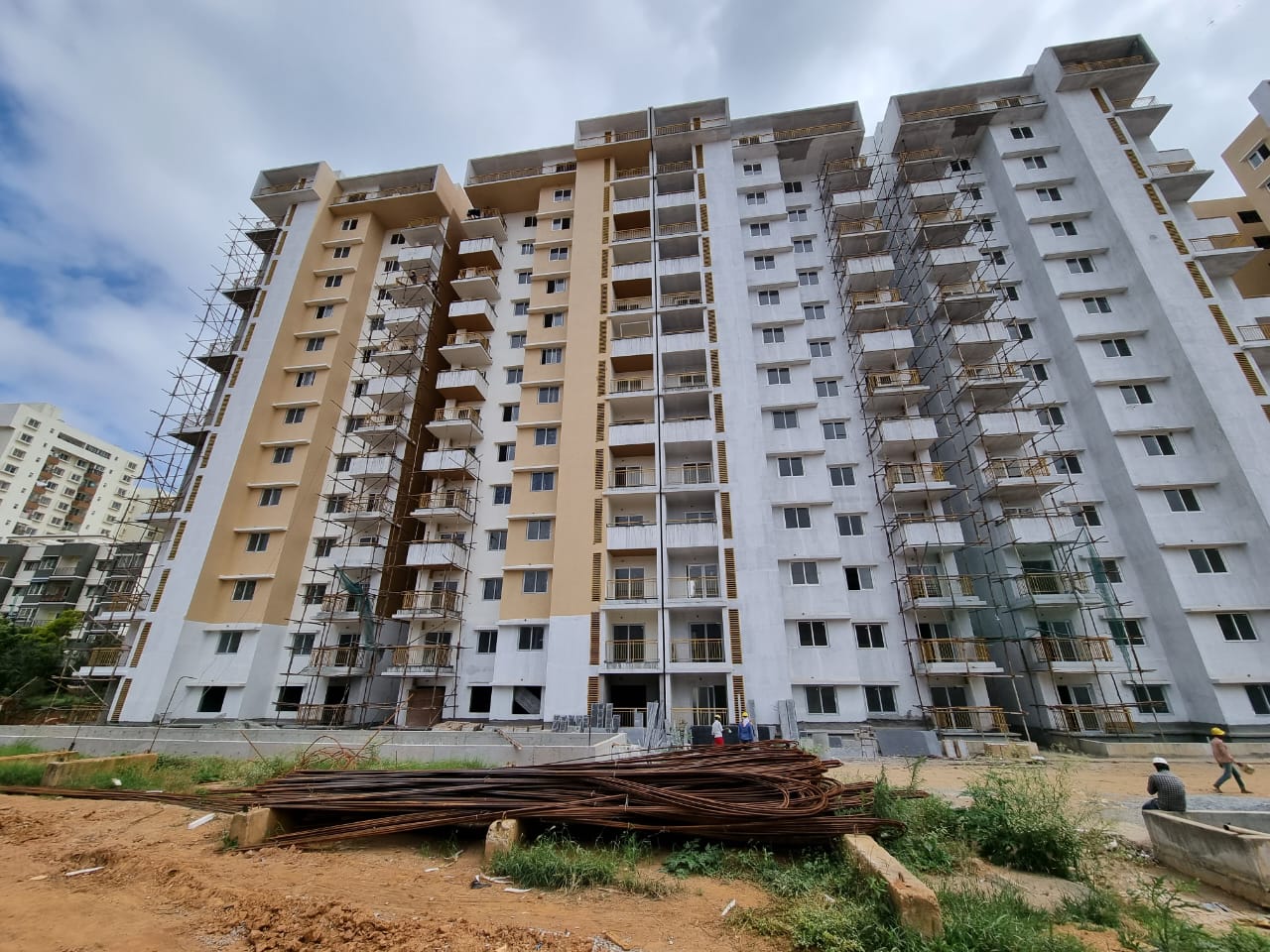

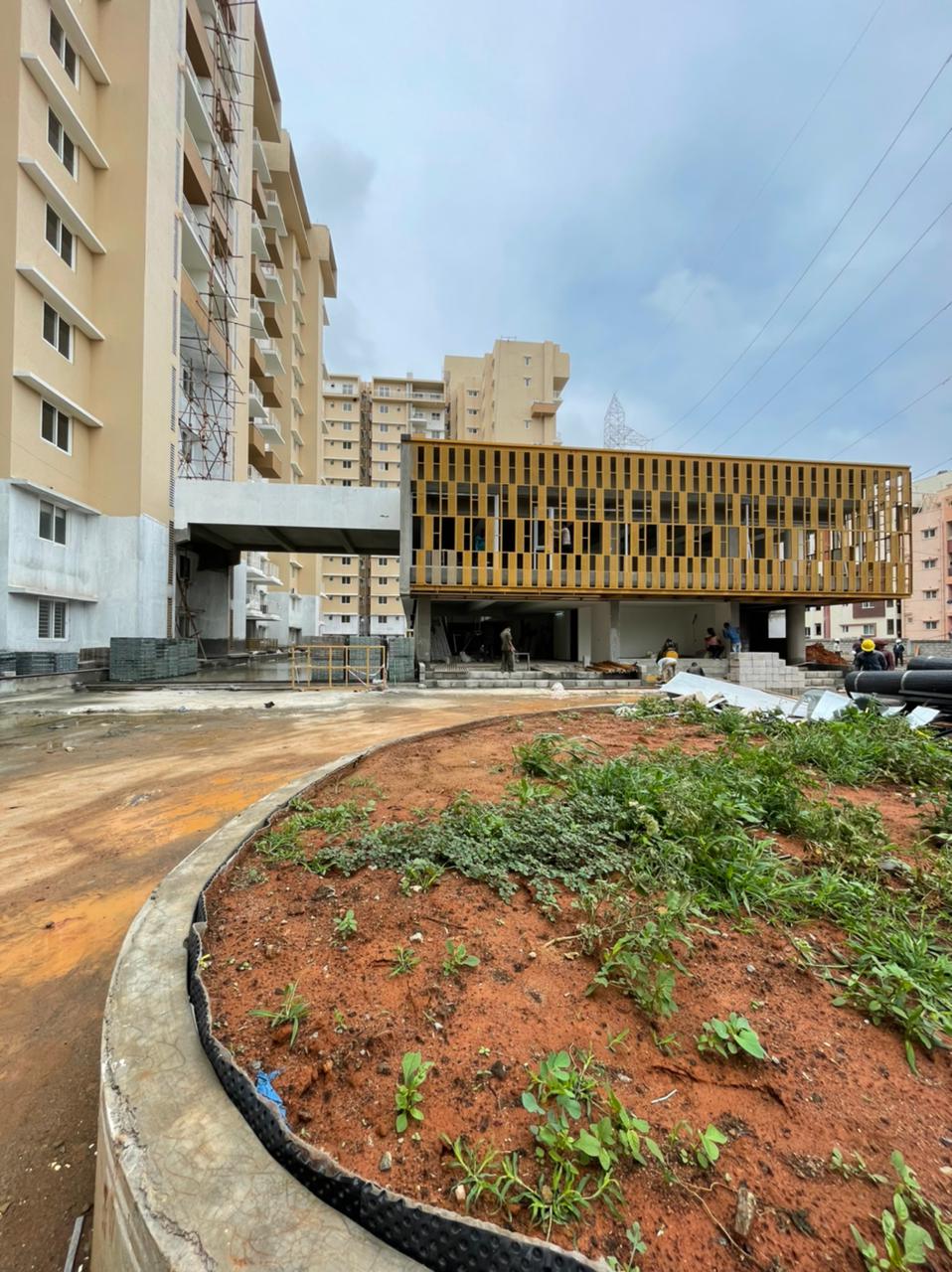

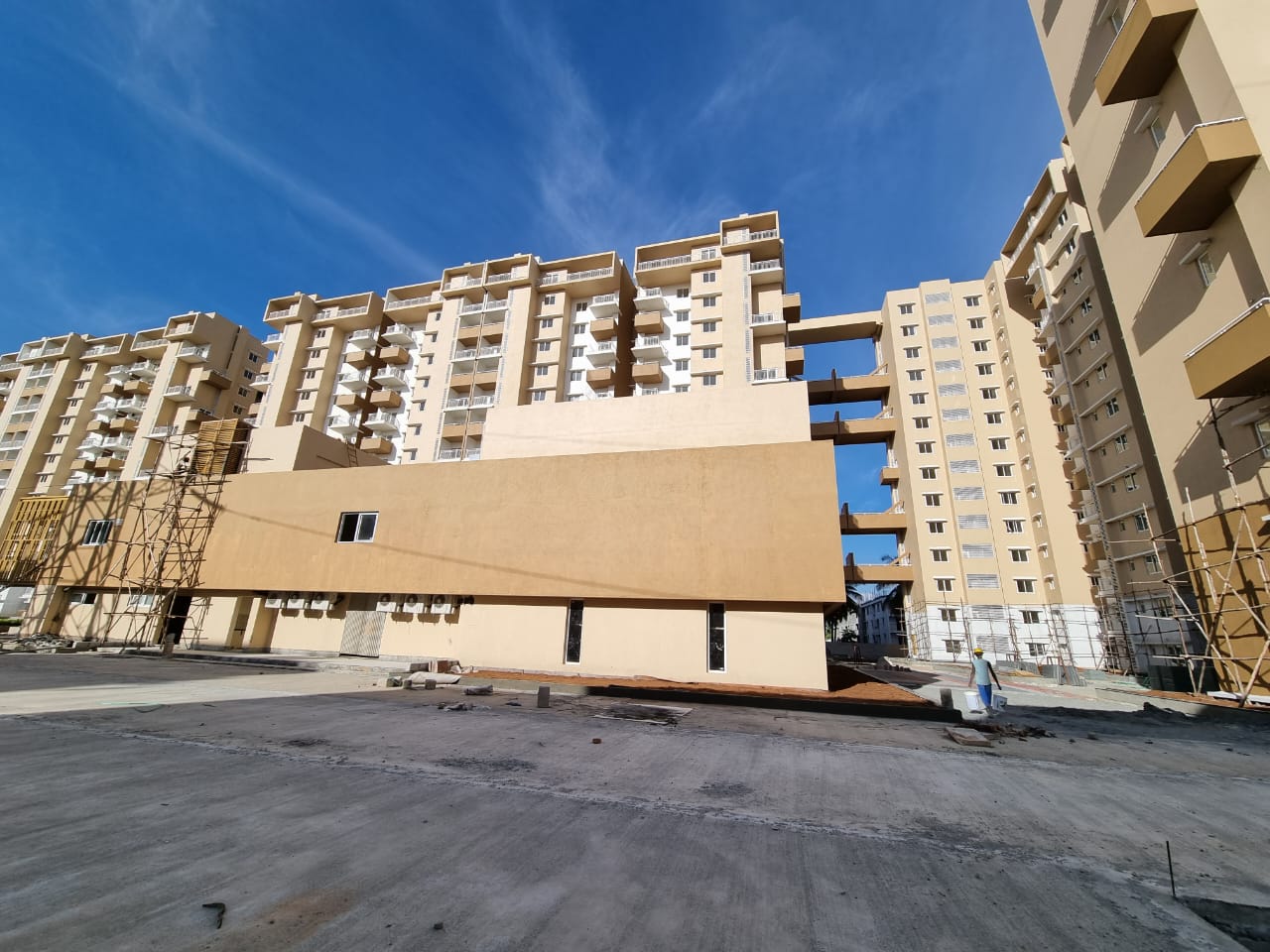

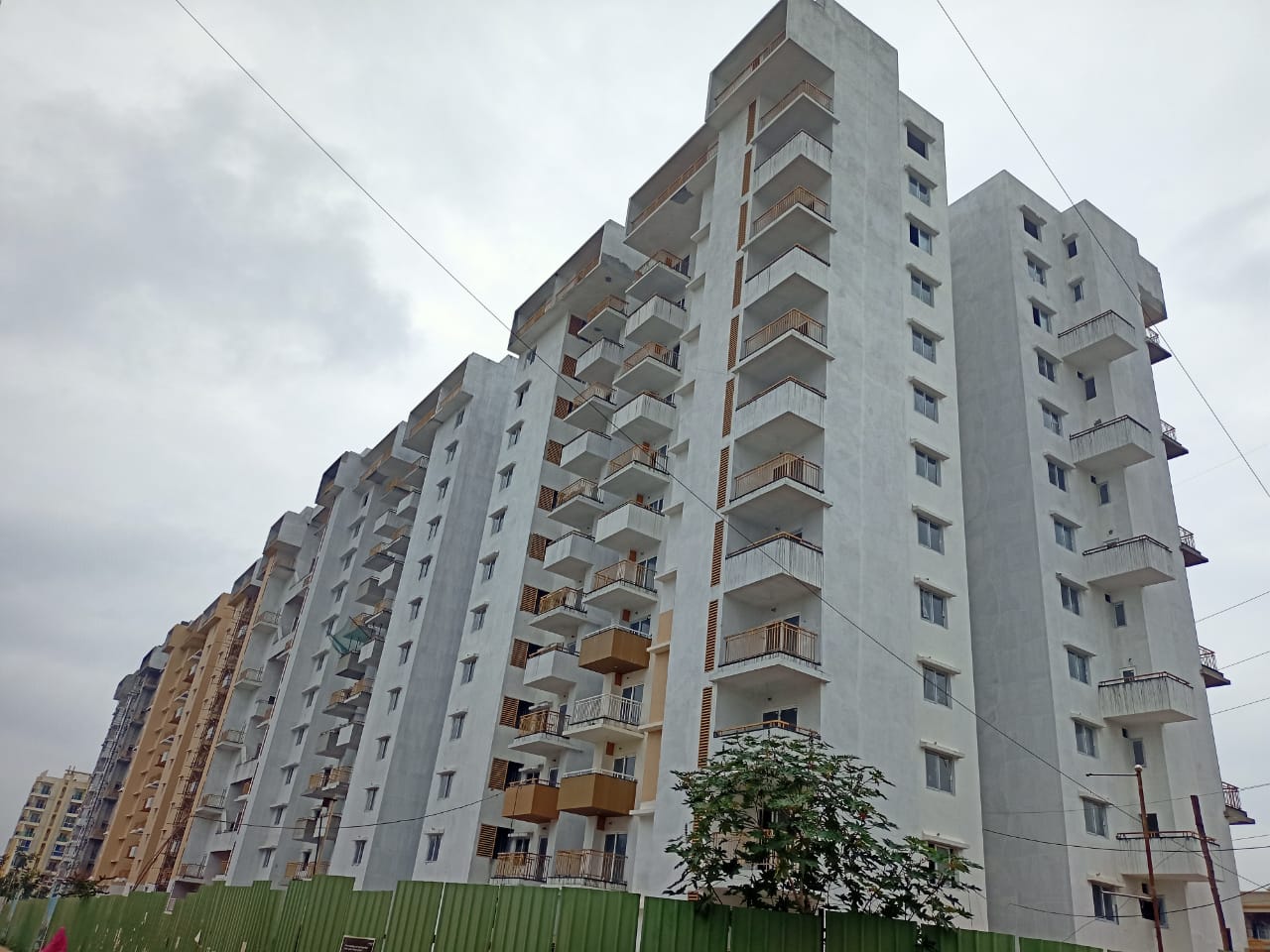

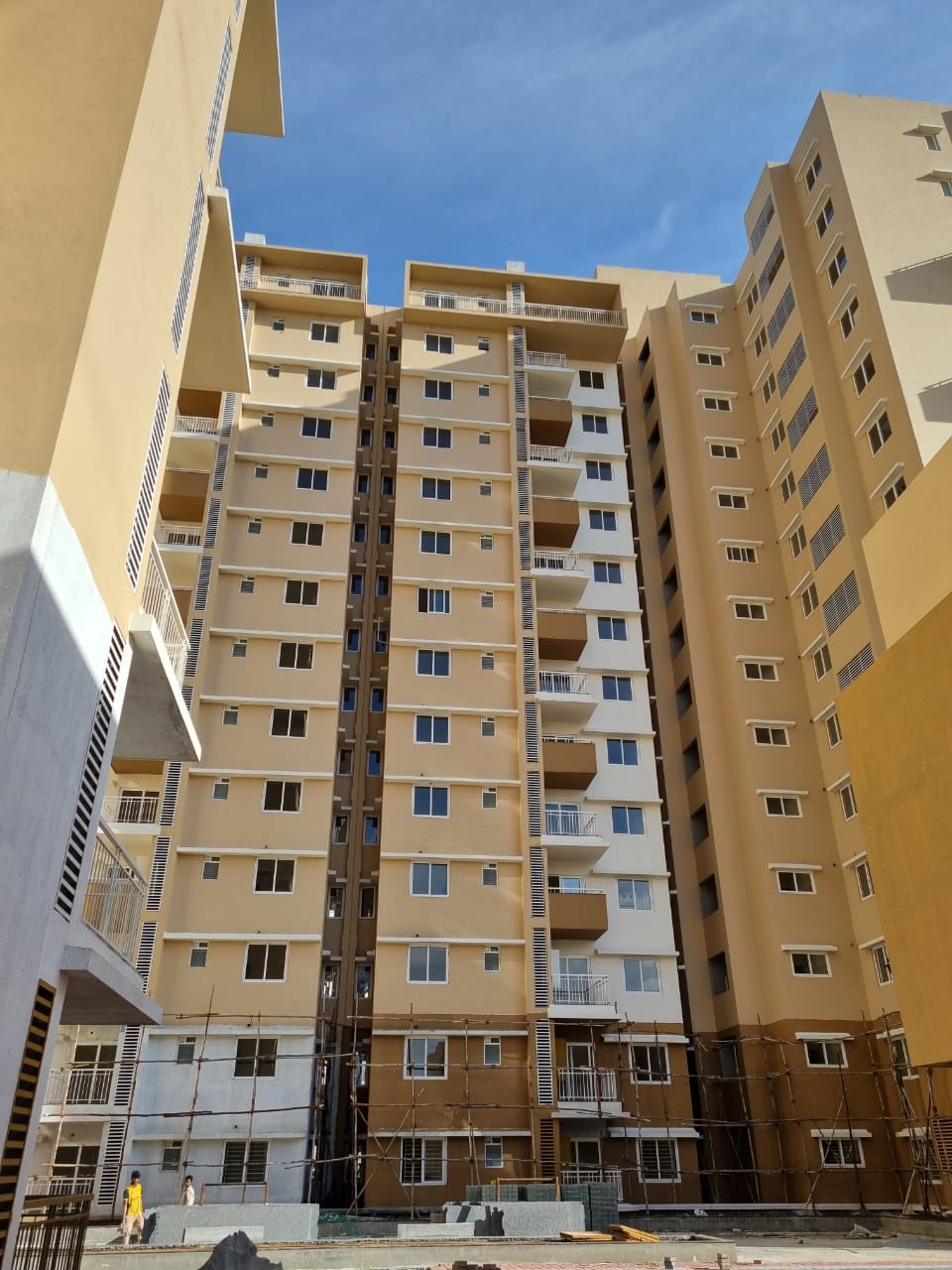

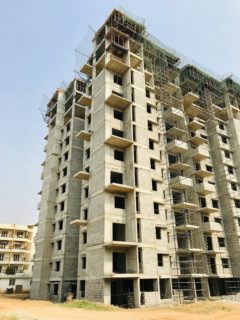

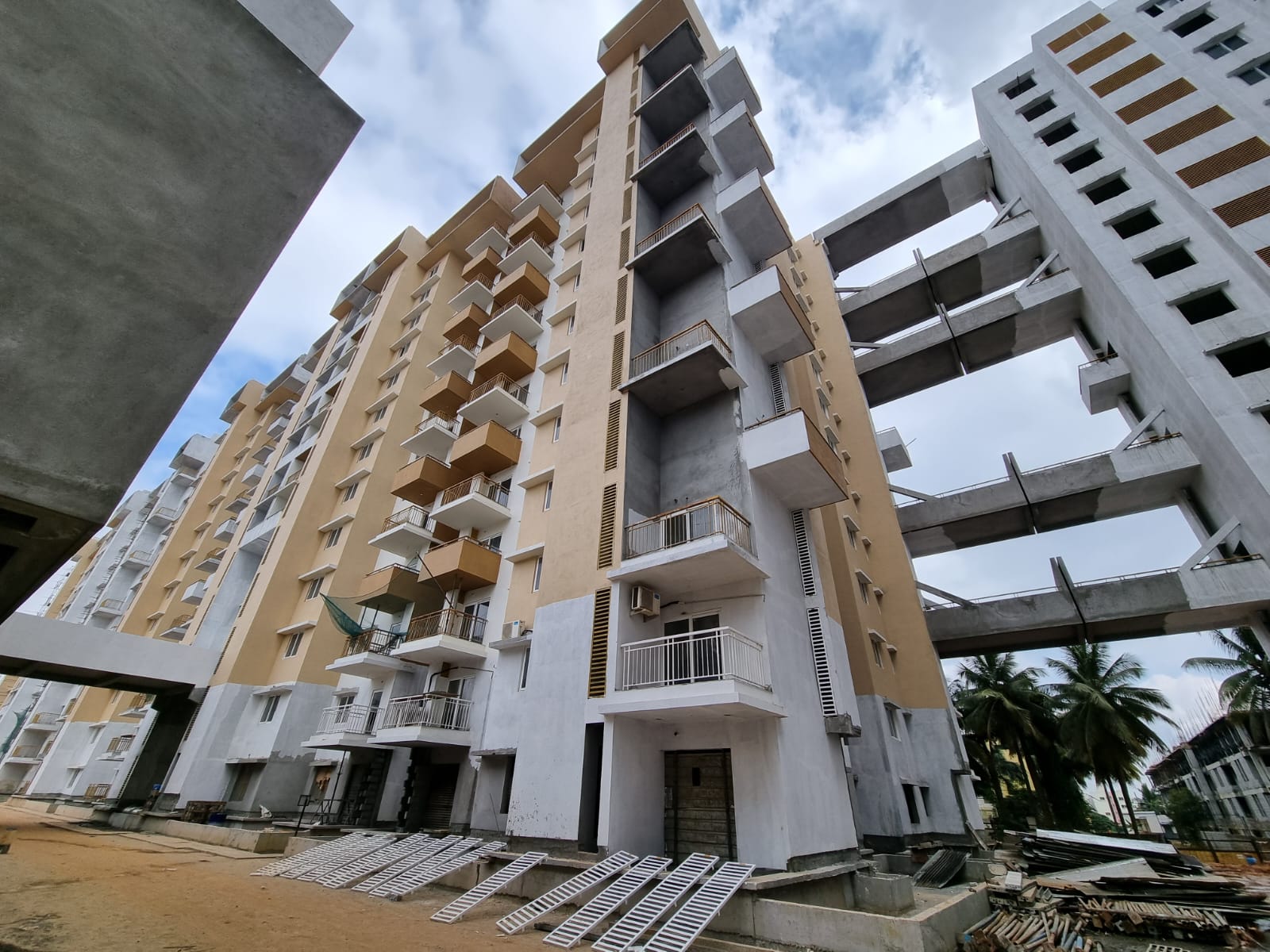

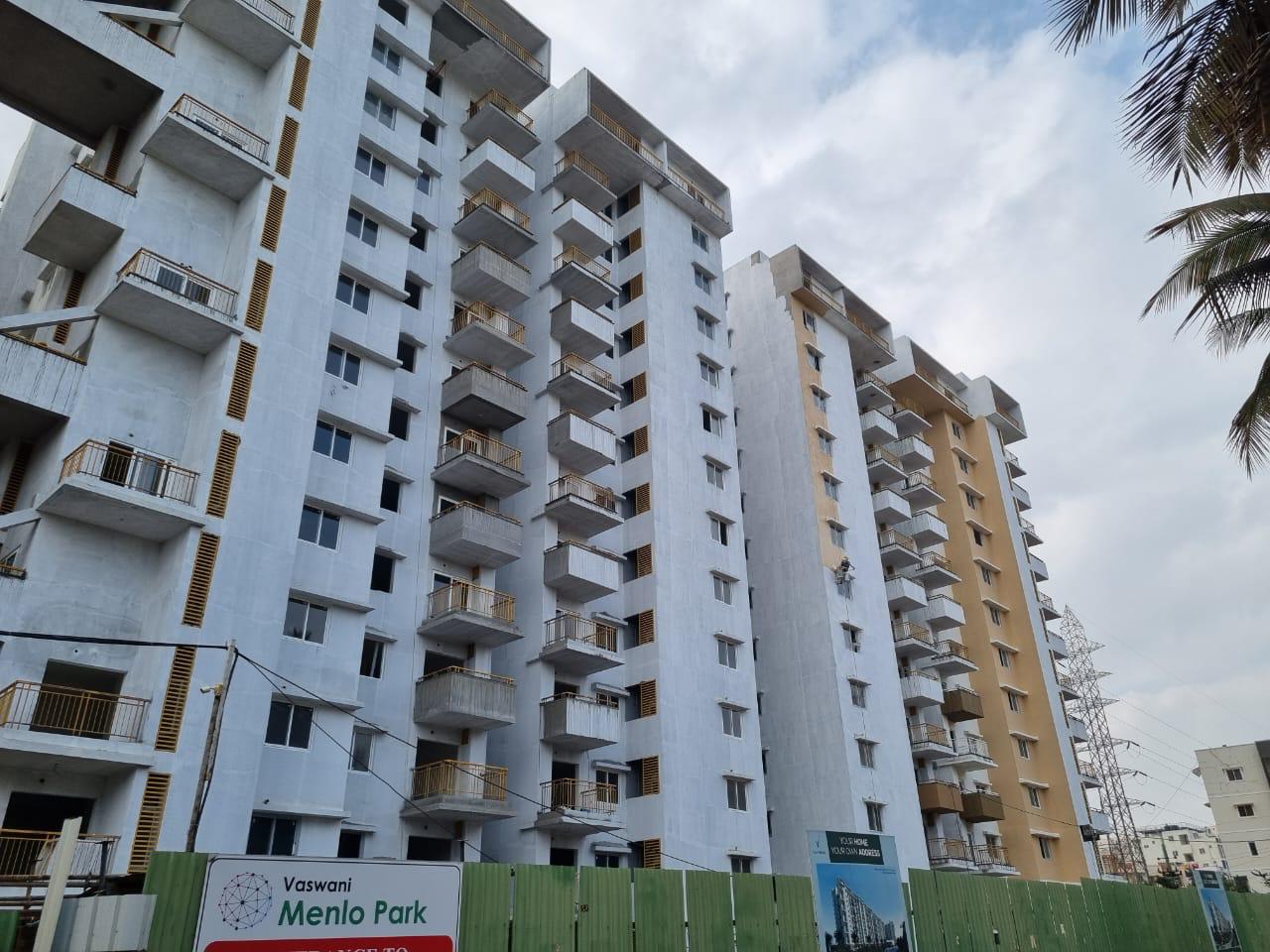

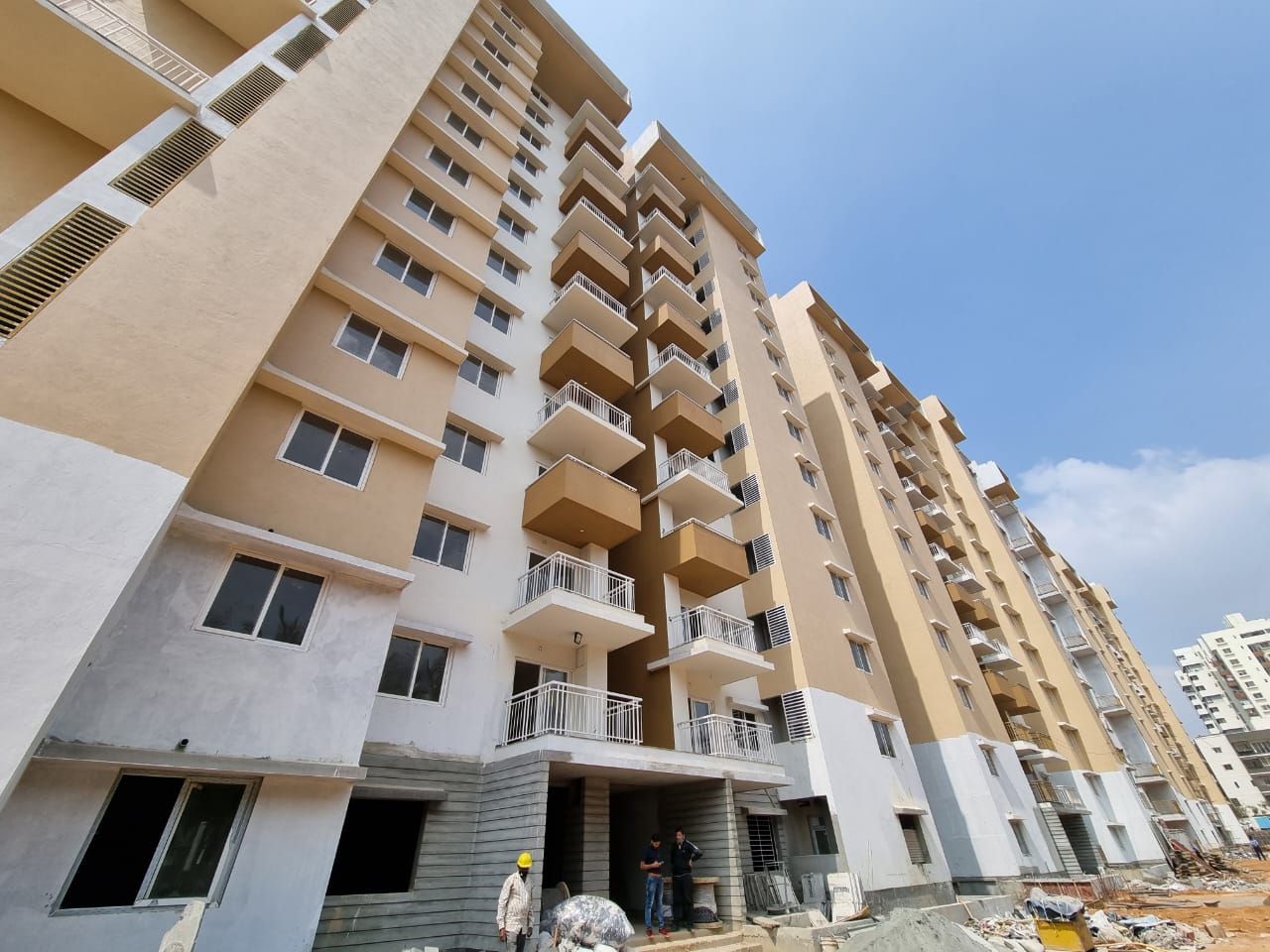

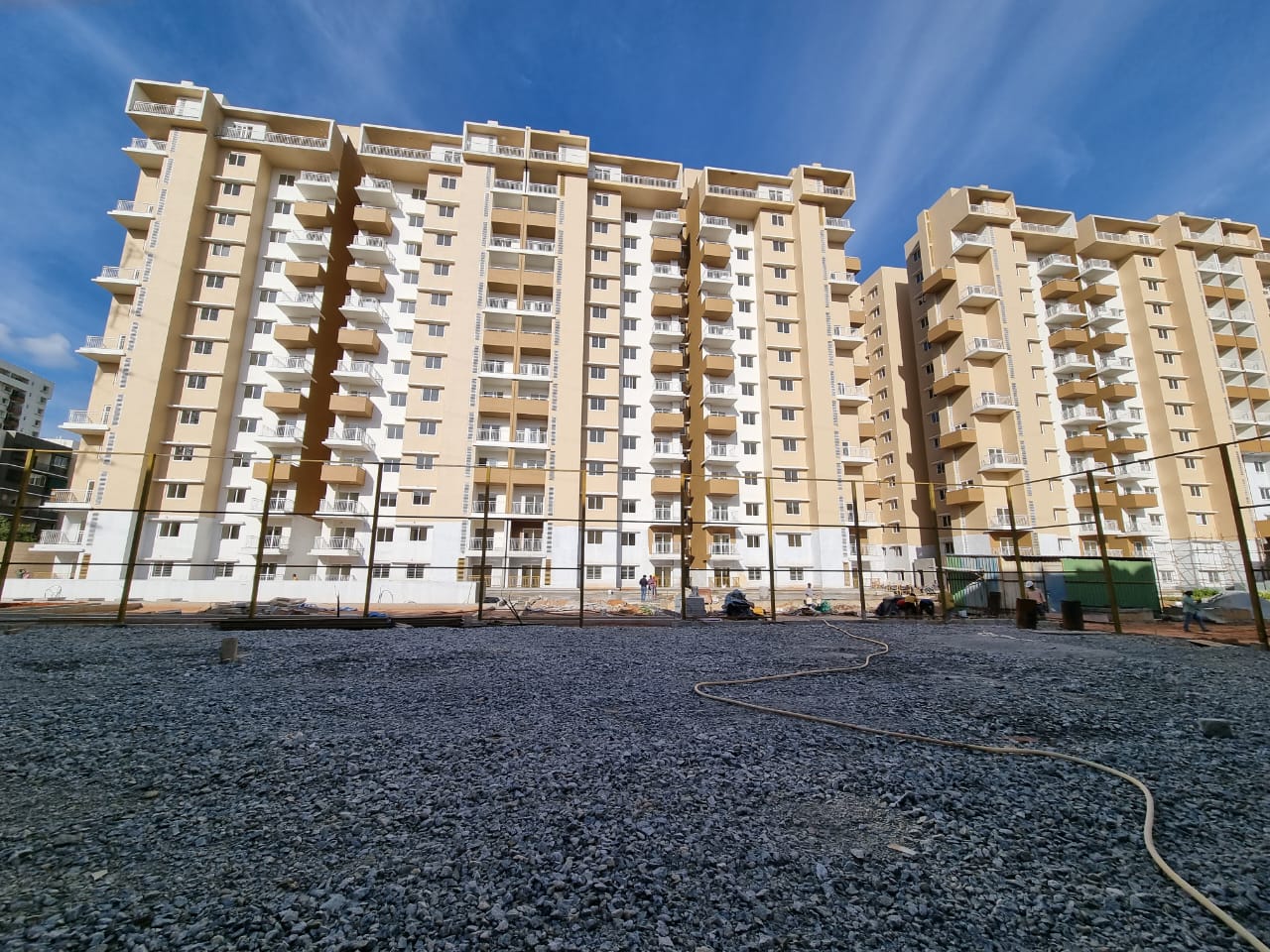

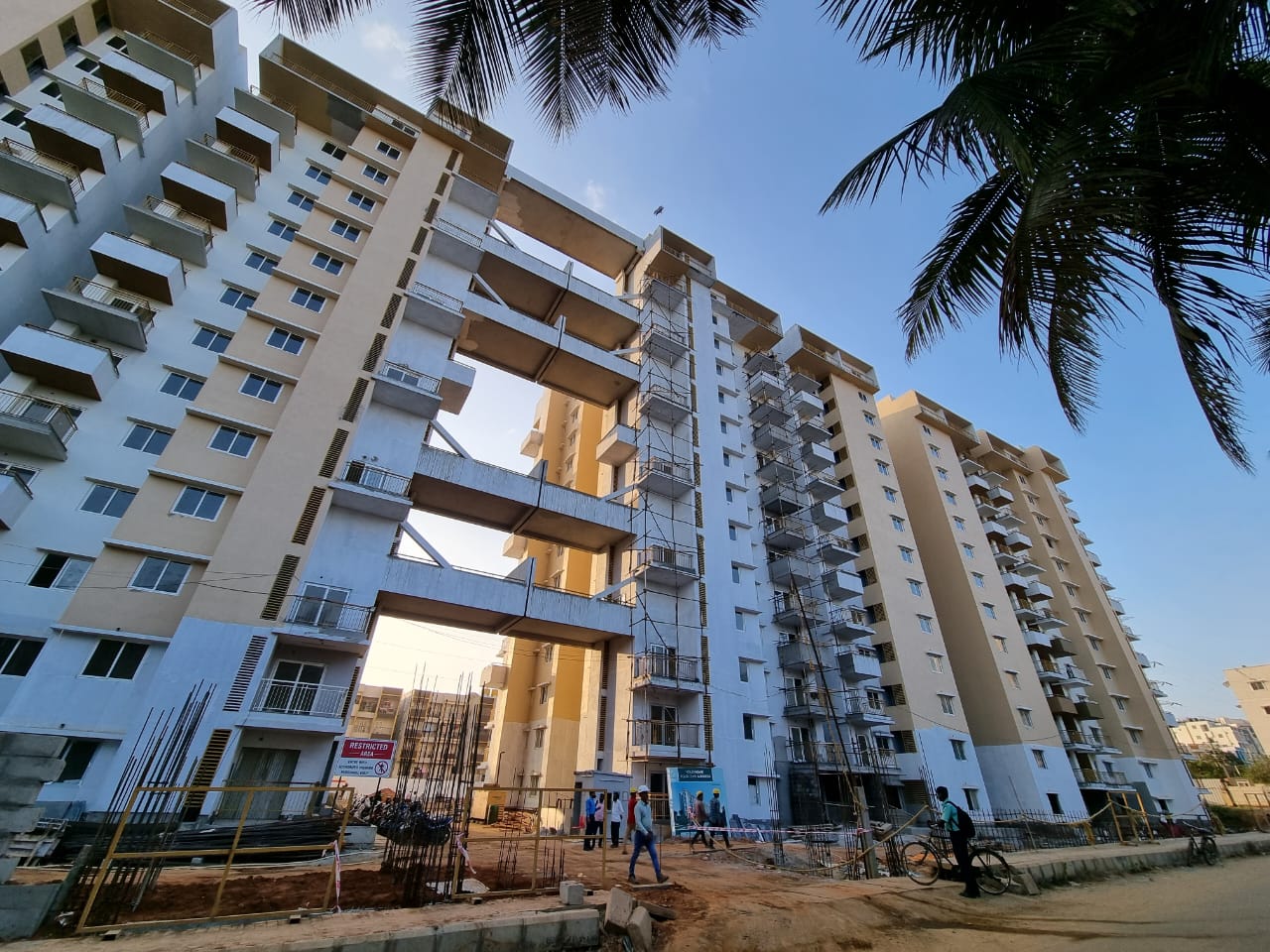

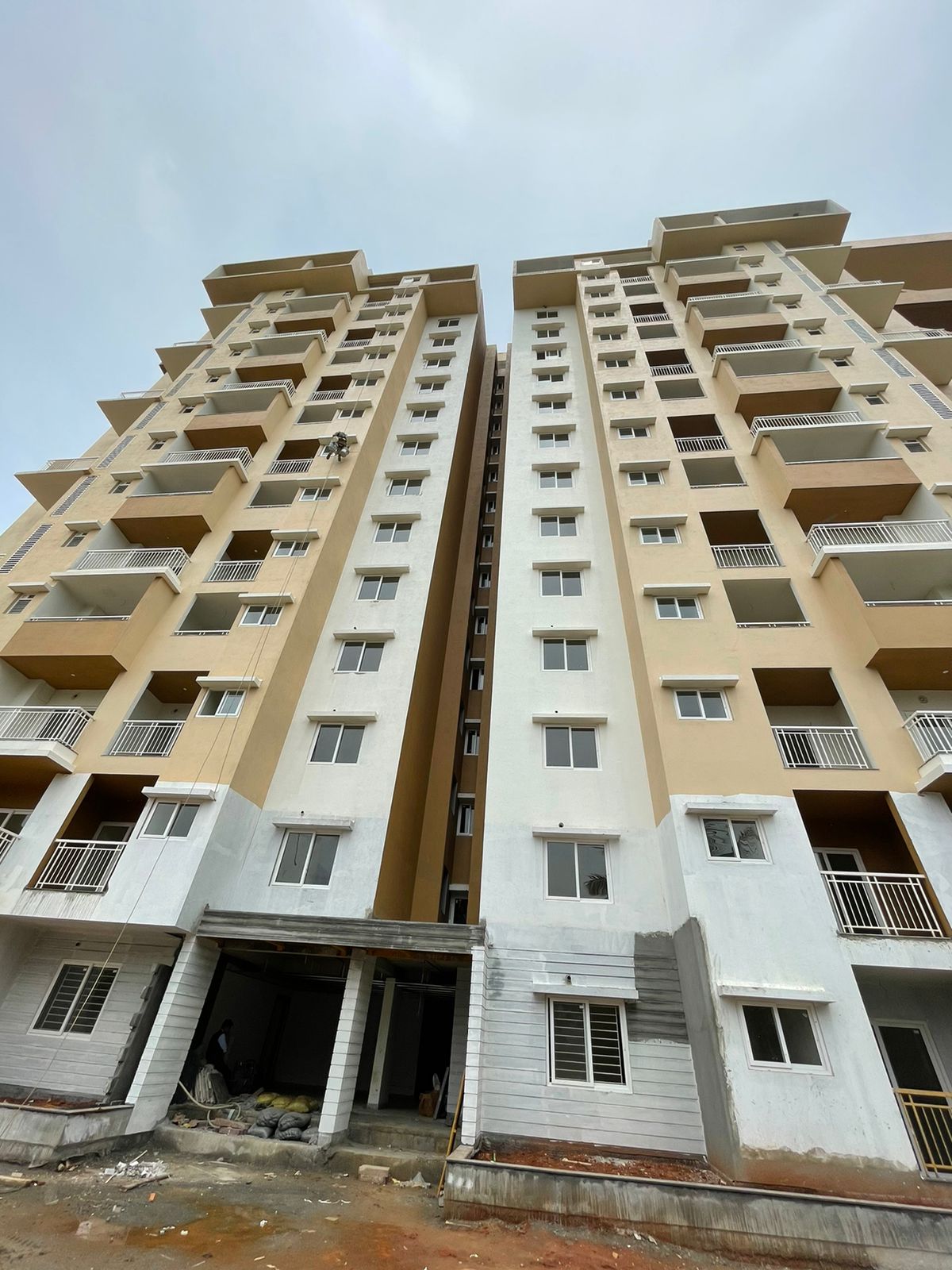

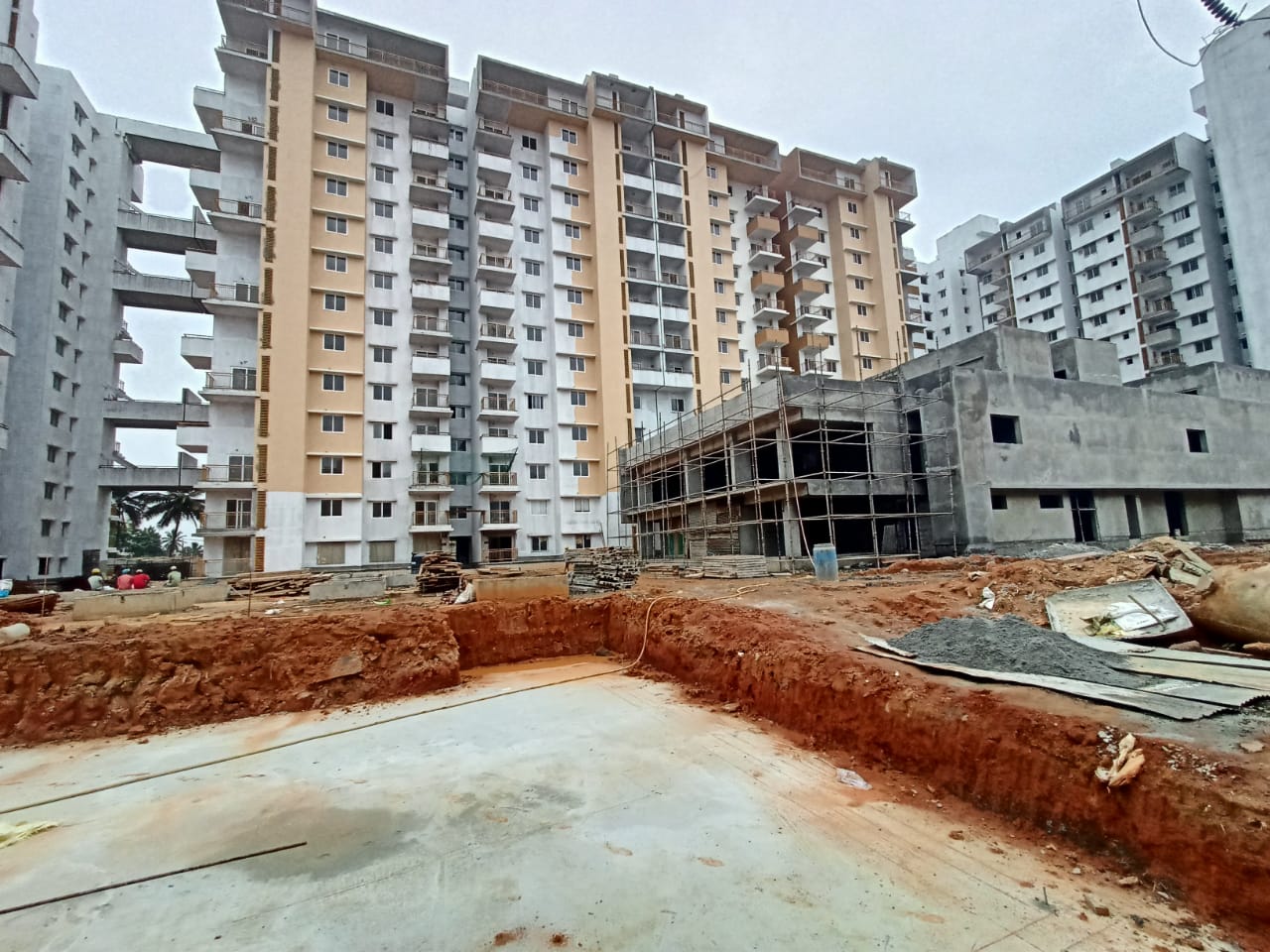

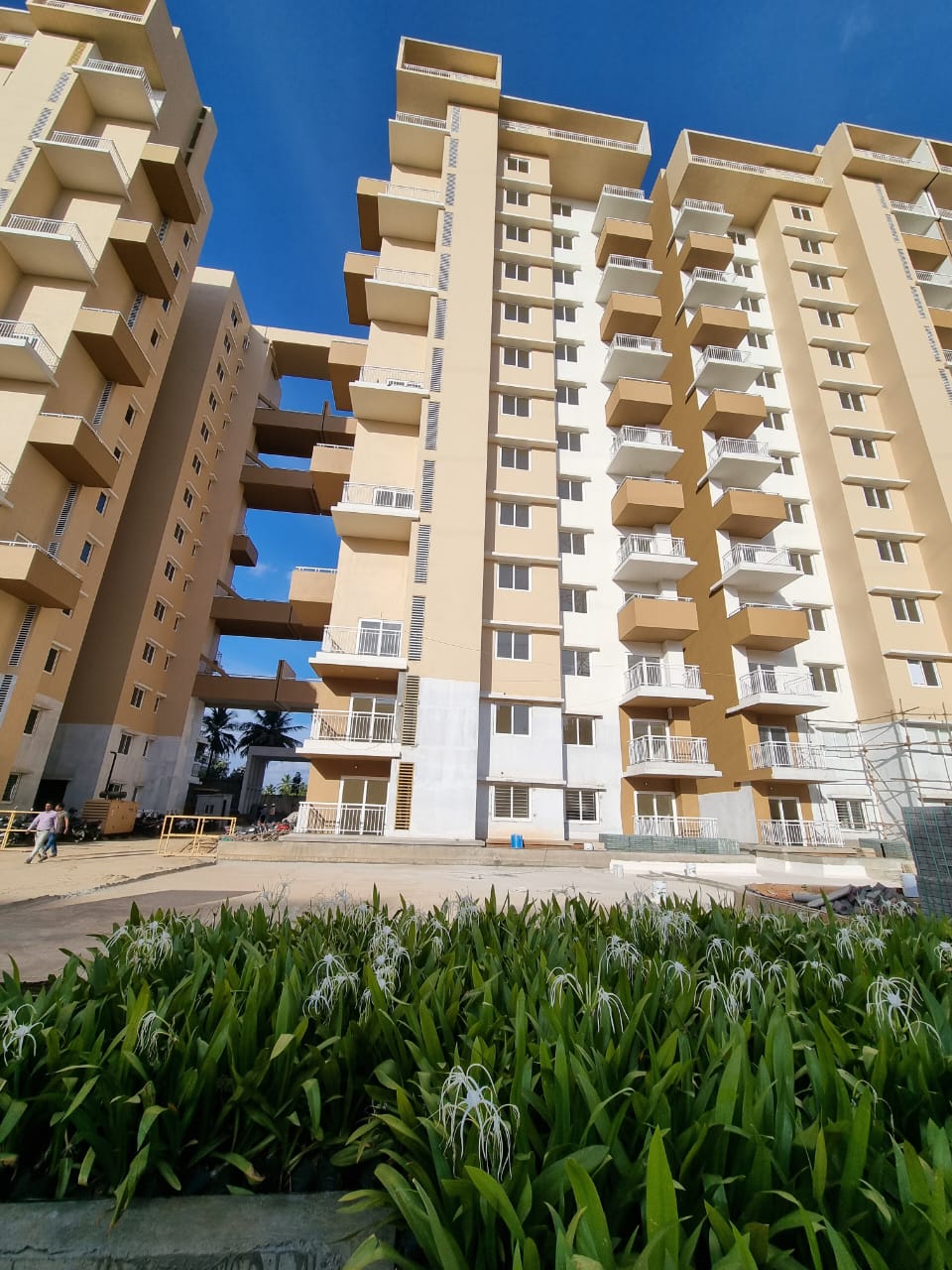

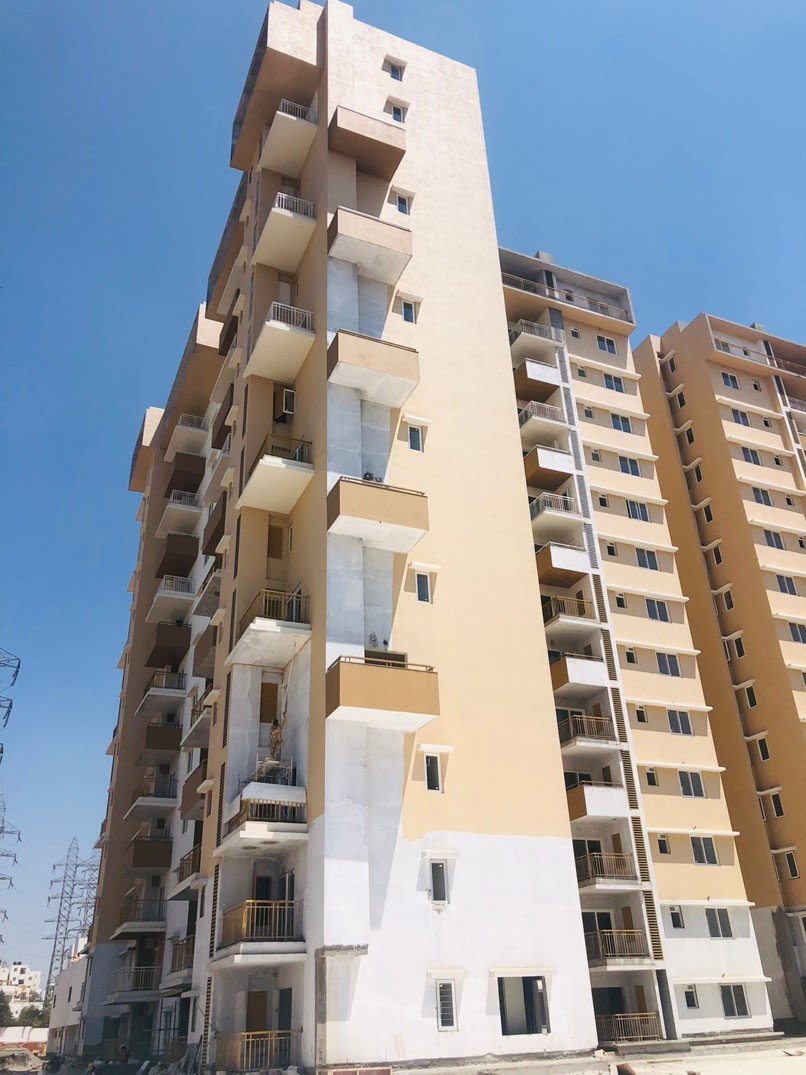

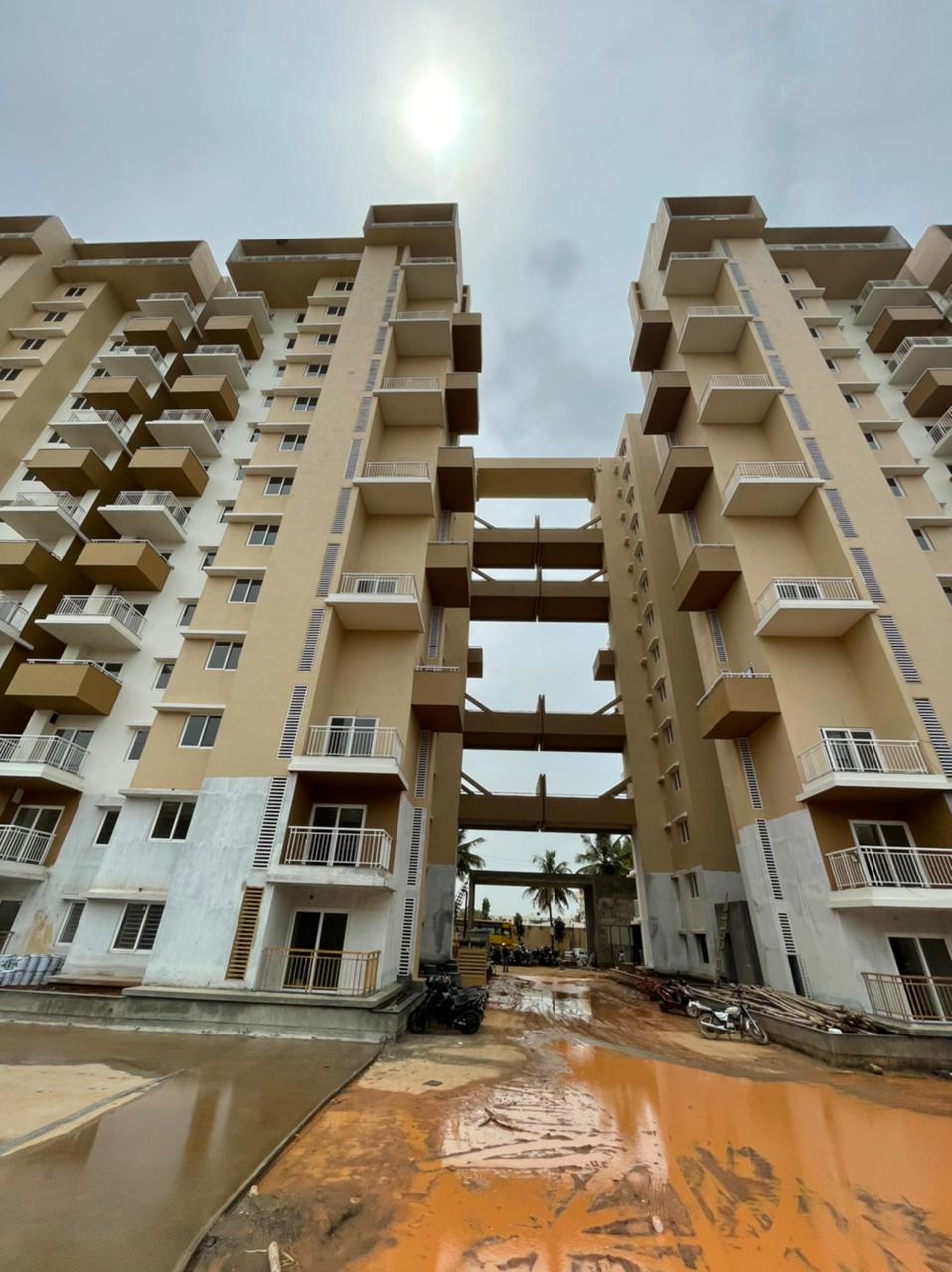

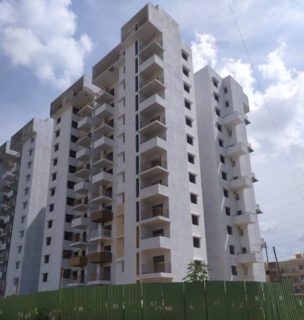

PROJECT PROGRESS REPORT AS ON 10th JULY 2022
Structural, Block, Internal Plastering, Electrical Works -Slab Conducting, Electrical Works -Wall Conducting for all towers completed.
1. External Frist Coat Painting:
2. External Frist Coat Painting:

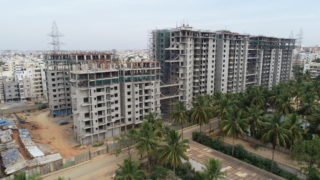

Common Area Works:
Podium Structural Works – Completed

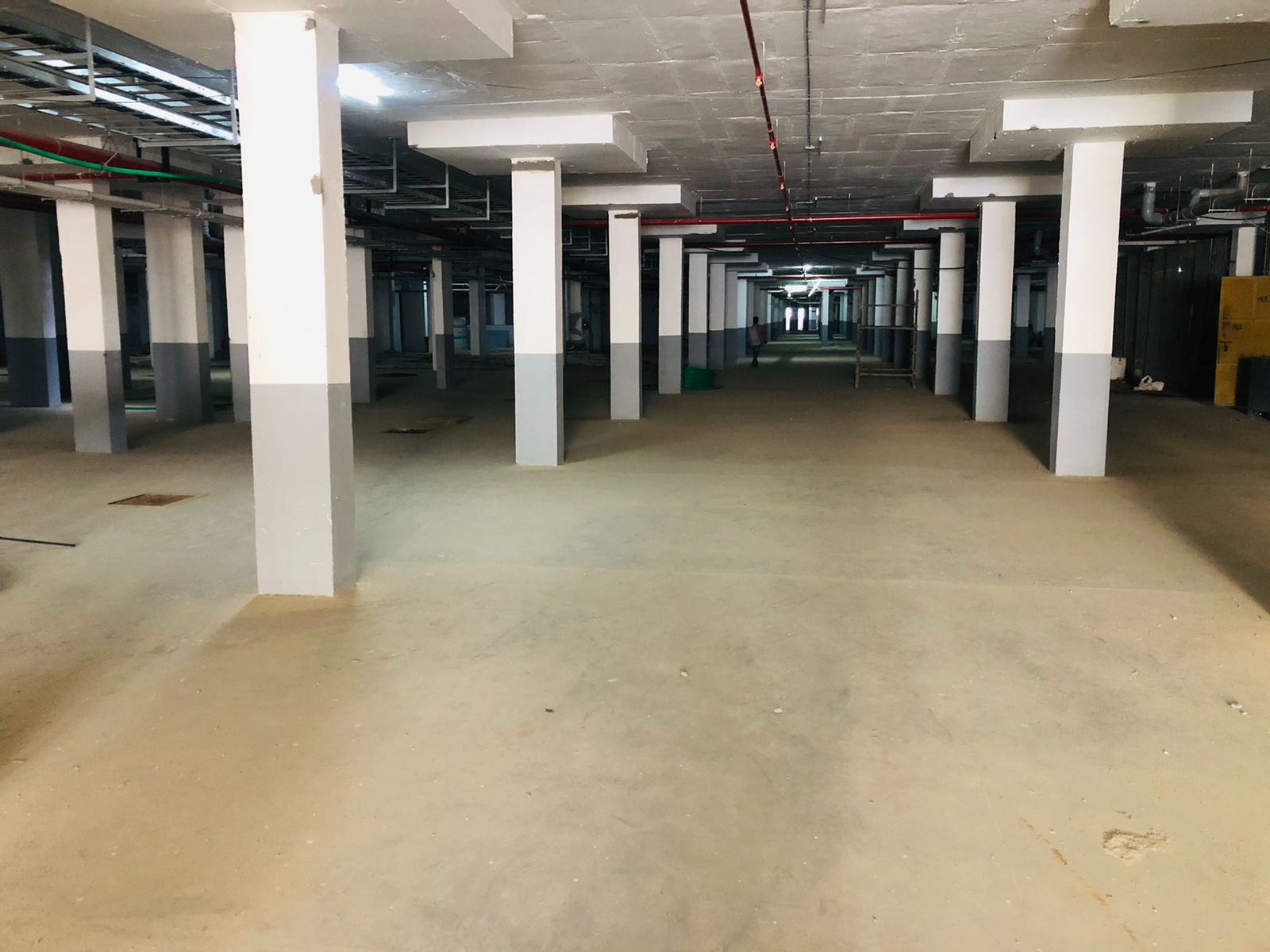

Basement IPS Flooring – Completed

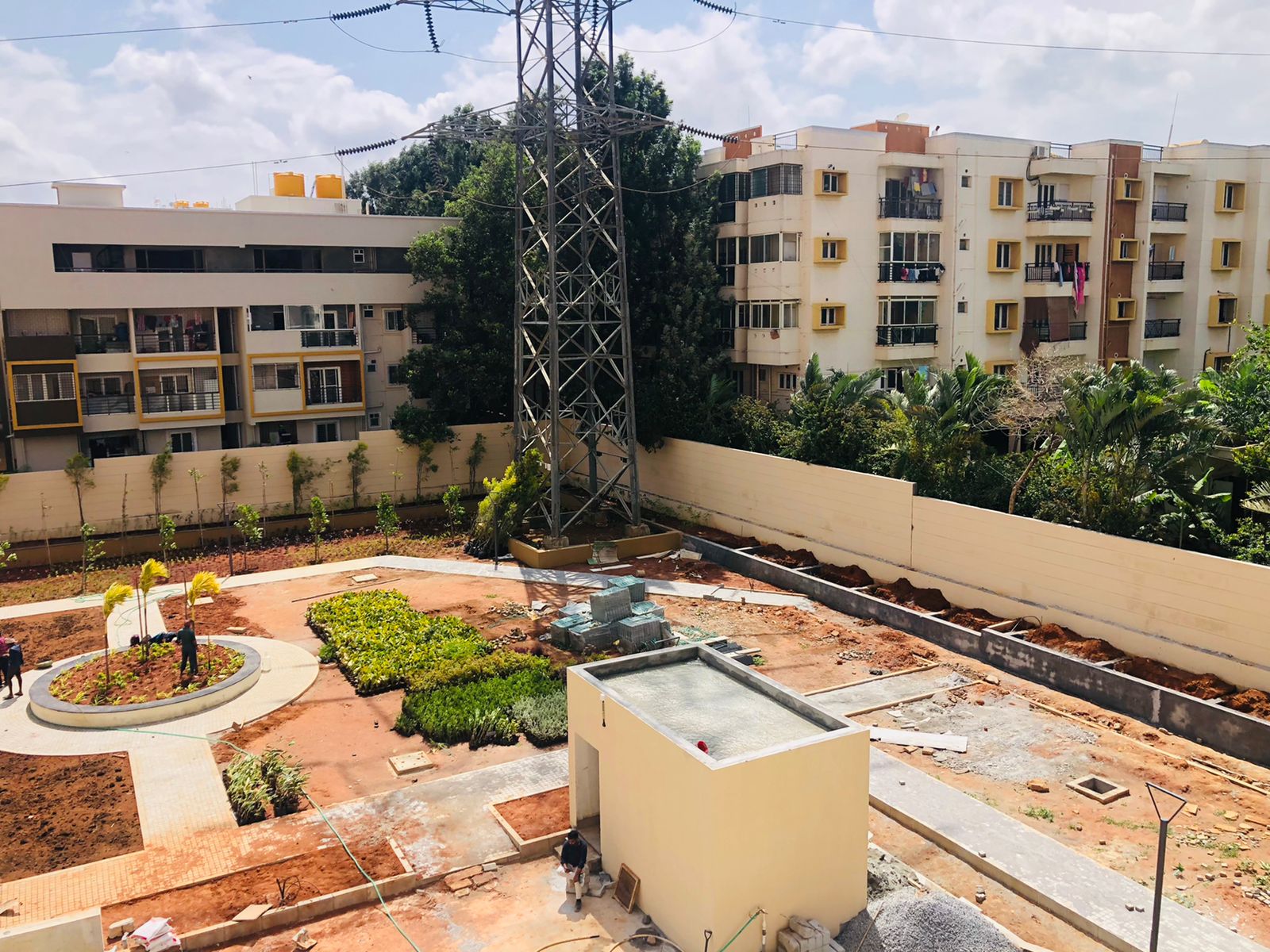

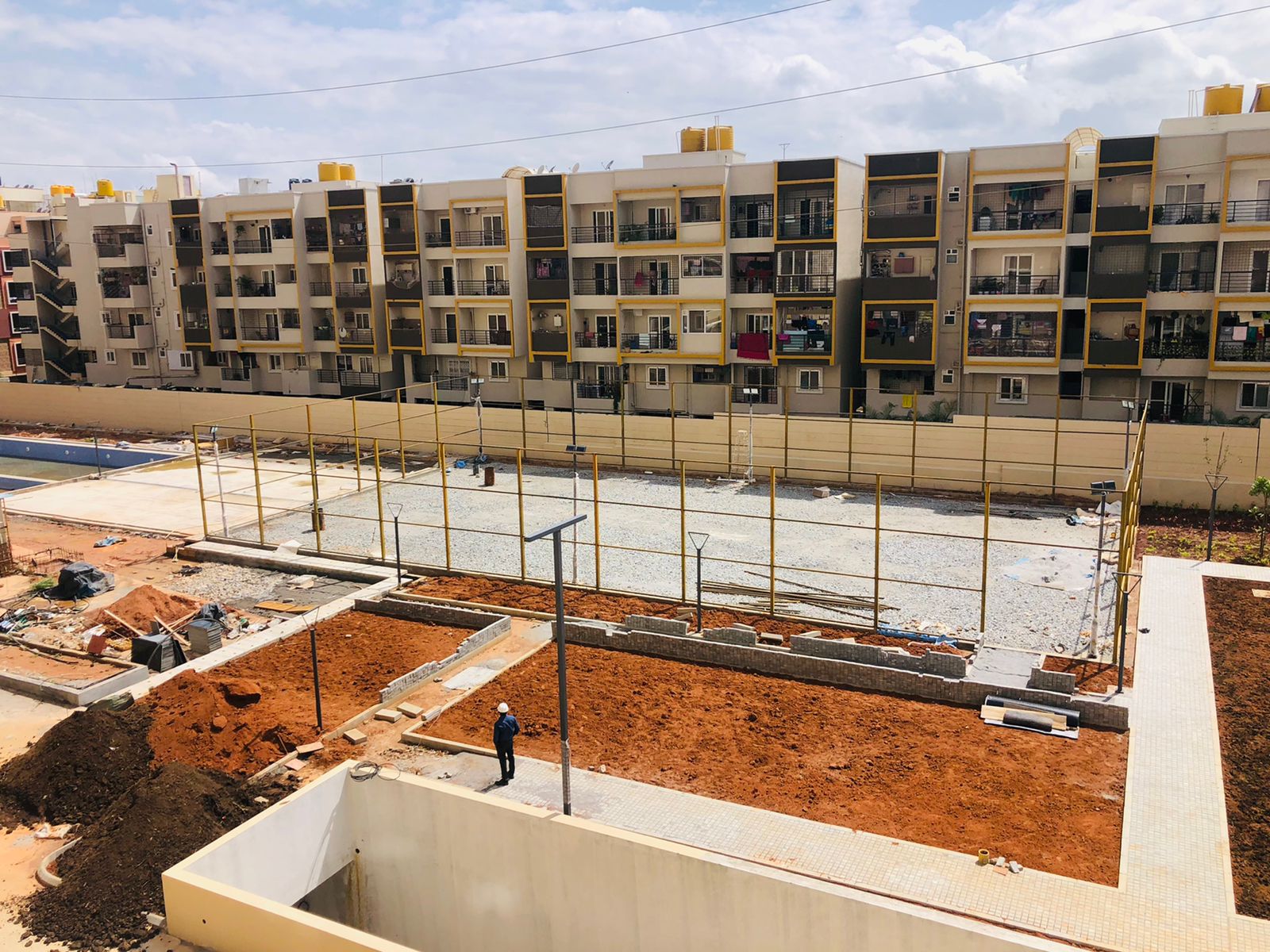

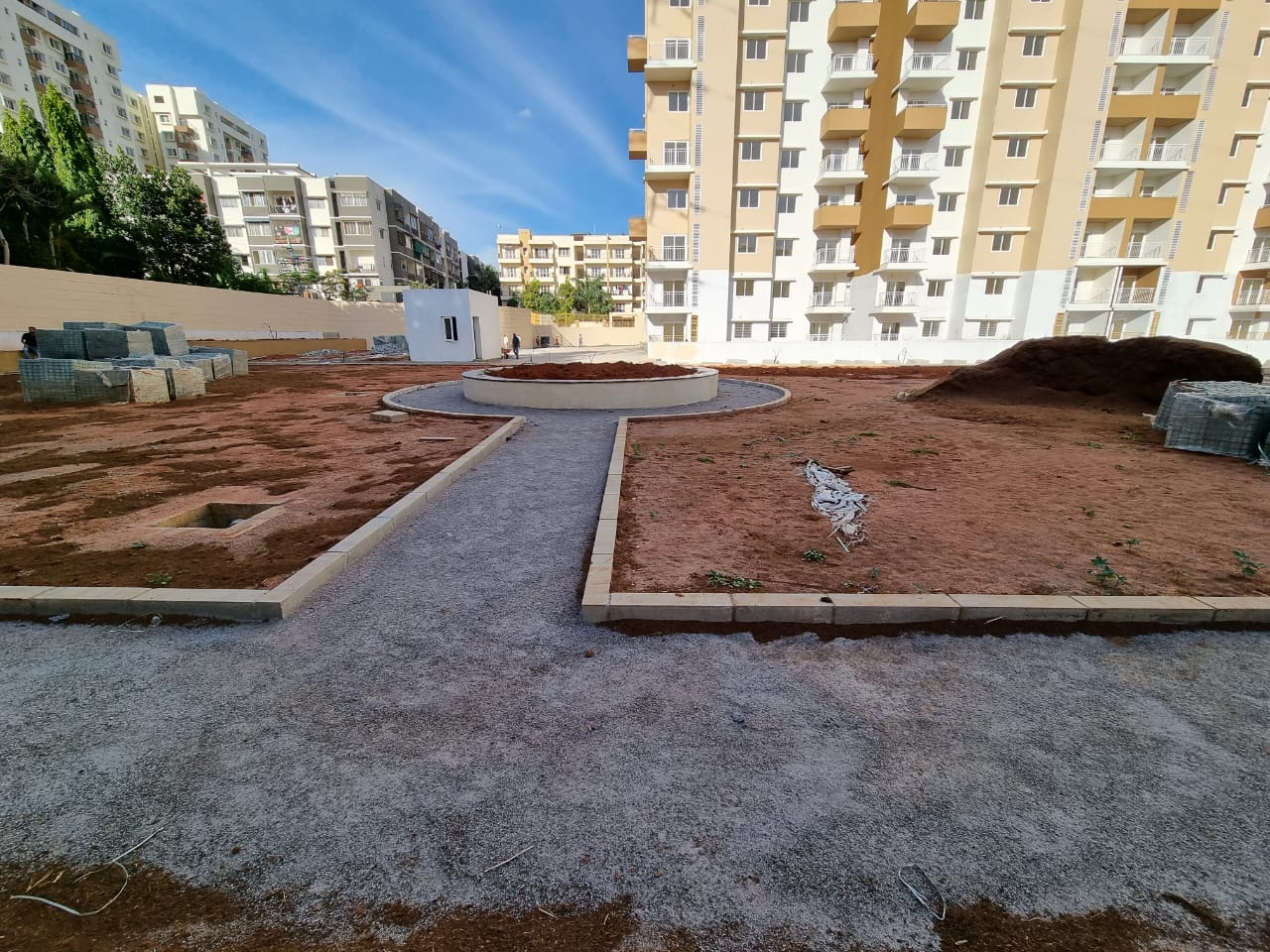

Landscape – 75% Completed

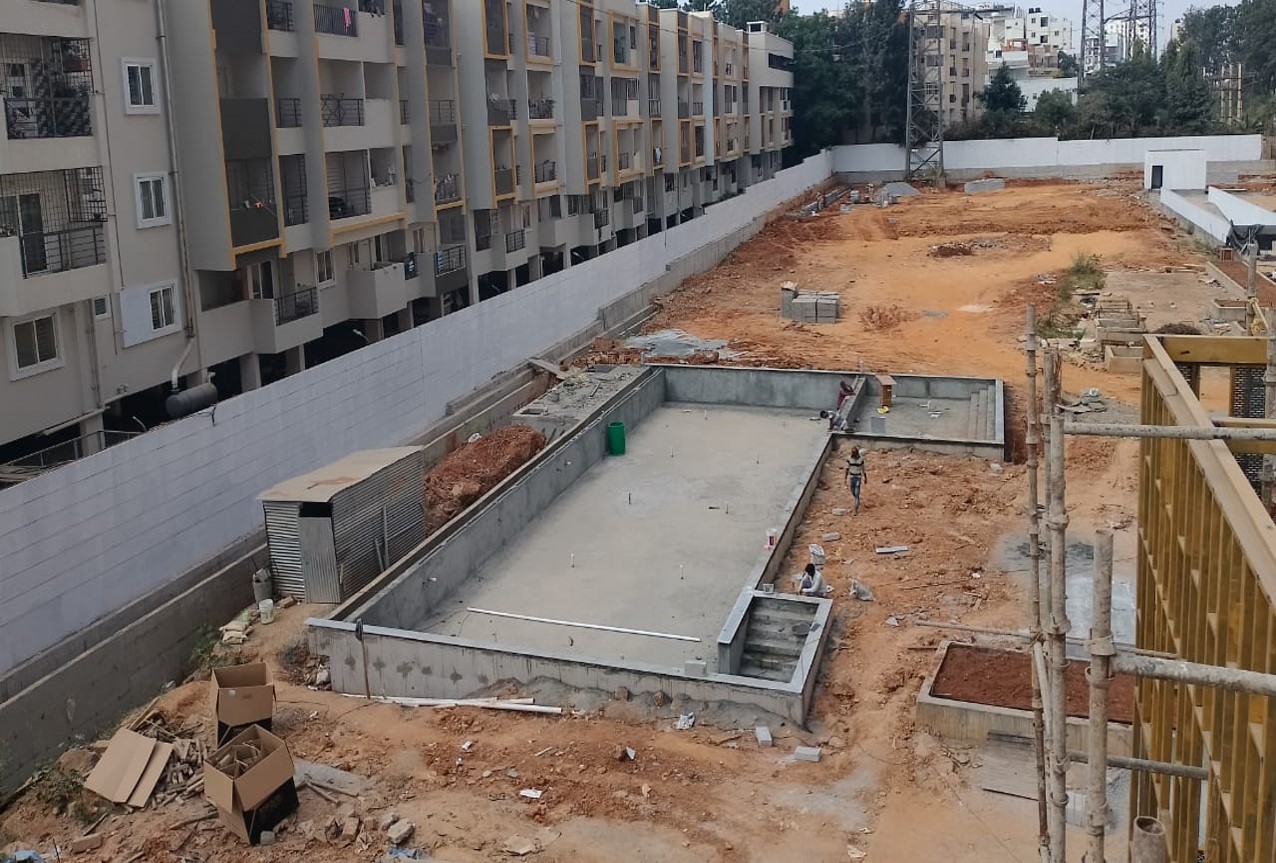

Swimming Pool – Completed

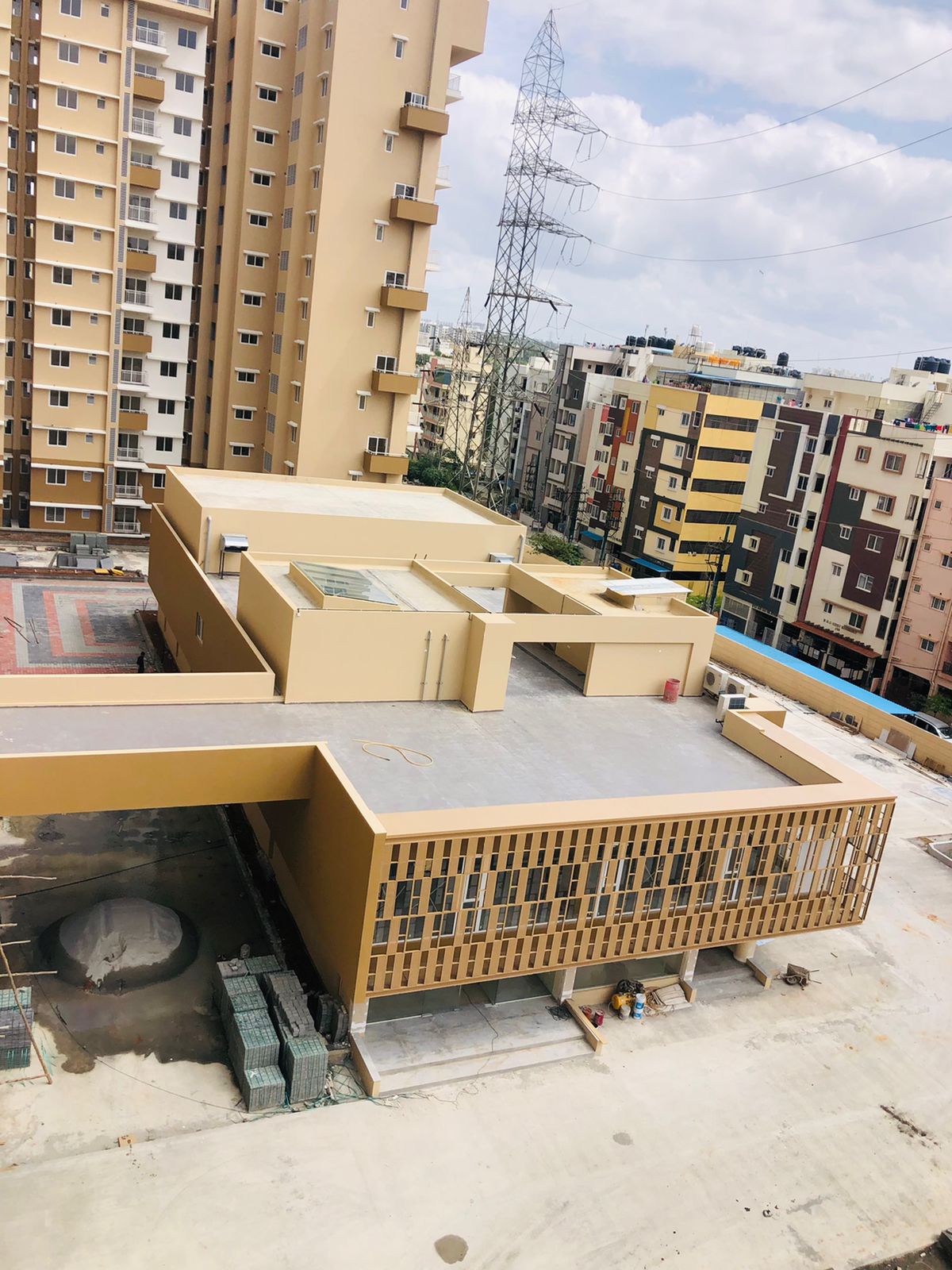

Club House – Completed

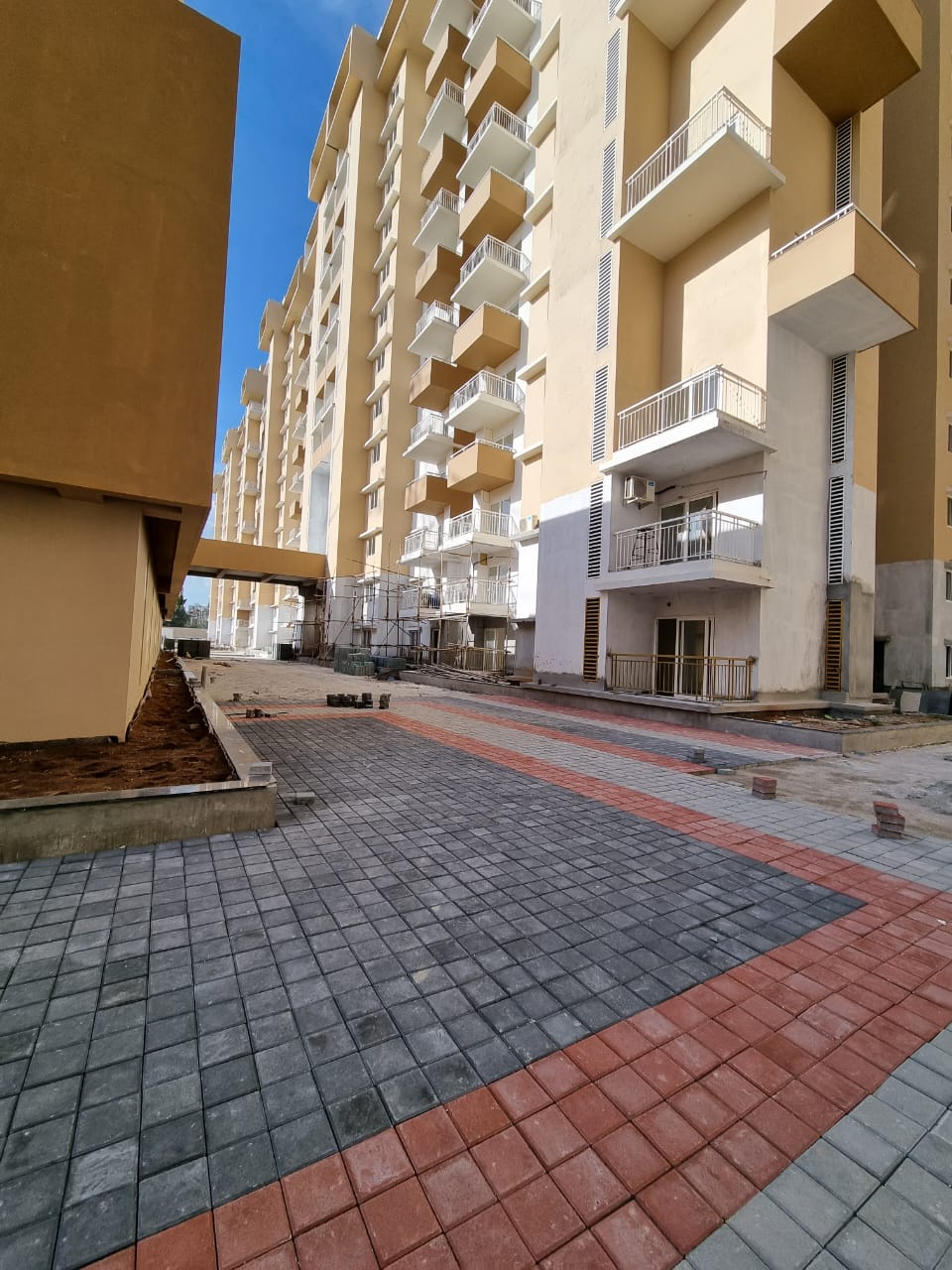

PROJECT PROGRESS REPORT AS ON 10th JUNE 2022
Structural, Block, Internal Plastering, Electrical Works -Slab Conducting, Electrical Works -Wall Conducting for all towers completed.
2. Electrical Works -Switch Plate
3. Plumbing Works -PVC- Completed
4. External Plastering: Completed
5. External Primer :
Common Area Works:
Podium Structural Works – Completed
Basement IPS Flooring – 98 % Completed
Landscape: 65 % Completed
Swimming Pool: Completed
PROJECT PROGRESS REPORT AS ON 10th MAY 2022
Structural, Block, Internal Plastering, Electrical Works -Slab Conducting, Electrical Works -Wall Conducting for all towers completed.
2. Electrical Works -Switch Plate
3. Plumbing Works -PVC- Completed
4. External Plastering: Completed
5. External Primer :
Common Area Works:
Podium Structural Works – Completed
Basement IPS Flooring – 95 % Completed
Landscape: 45 % Completed
Swimming Pool: Completed
PROJECT PROGRESS REPORT AS ON 10th APRIL 2022
Structural, Block, Internal Plastering, Electrical Works -Slab Conducting, Electrical Works -Wall Conducting for all towers completed.
2. Electrical Works -Switch Plate
3. Plumbing Works -PVC- Completed
4. External Plastering: Completed
5. External Primer :
Common Area Works:
Podium Structural Works – Completed
Basement IPS Flooring – 85 % Completed
Landscape: 35 % Completed
Swimming Pool: Completed
PROJECT PROGRESS REPORT AS ON 10th MARCH 2022
Structural, Block, Internal Plastering, Electrical Works -Slab Conduiting, Electrical Works -Wall Conduiting for all towers completed.
2. Electrical Works -Switch Plate
3. Plumbing Works -PVC- Completed
4. External Plastering : Completed
5. External Primer :
Common Area Works:
Podium Structural Works – Completed
Basement IPS Flooring – 50 % Completed
Landscape: Work in Progress
Swimming Pool: Completed

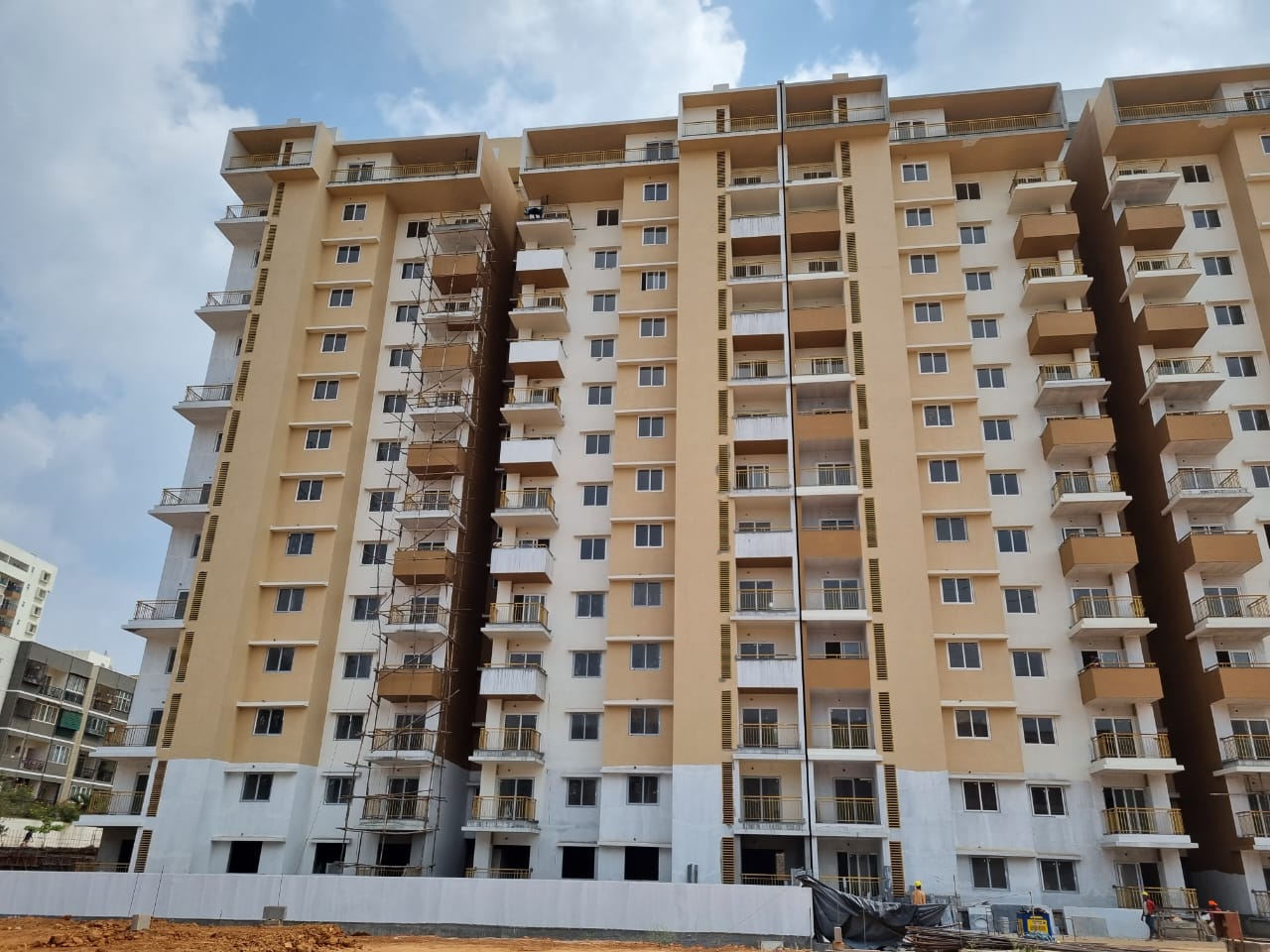

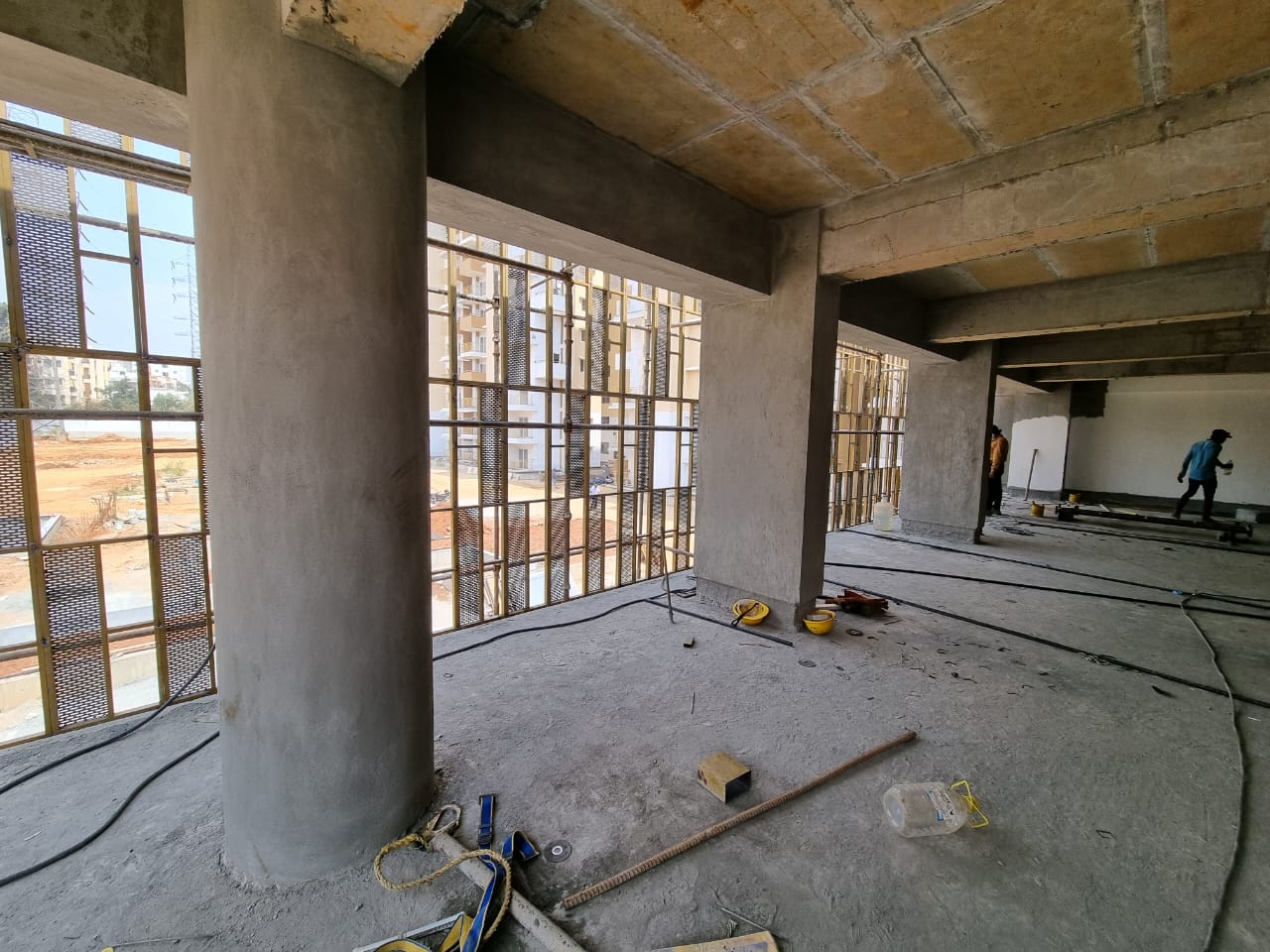

PROJECT PROGRESS REPORT AS ON 10th February 2022
Structural, Block, Internal Plastering, Electrical Works -Slab Conduiting, Electrical Works -Wall Conduiting for all towers completed.
2. Electrical Works -Switch Plate
3. Plumbing Works -PVC- Completed
4. External Plastering : Completed
5. External Primer :

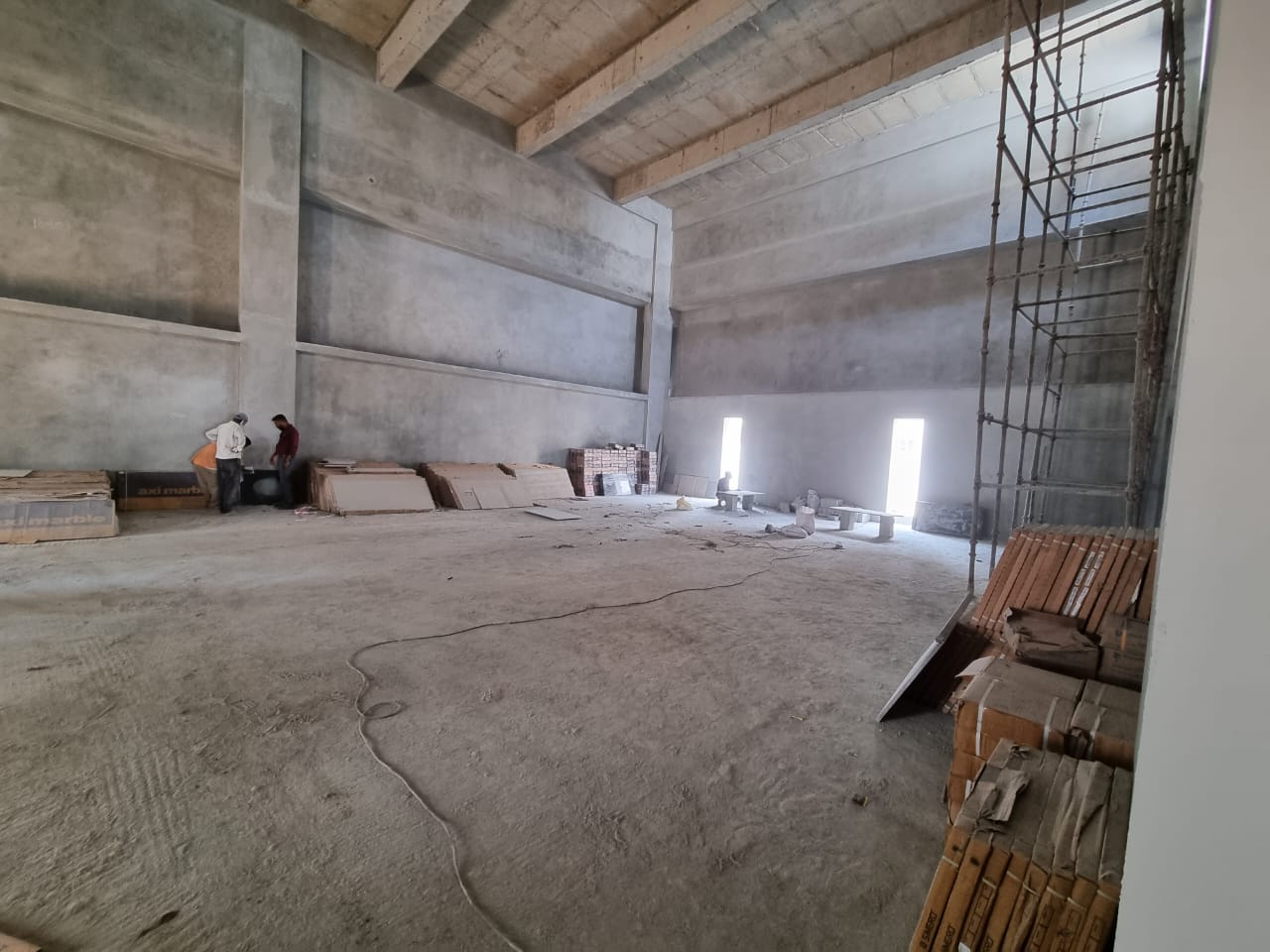

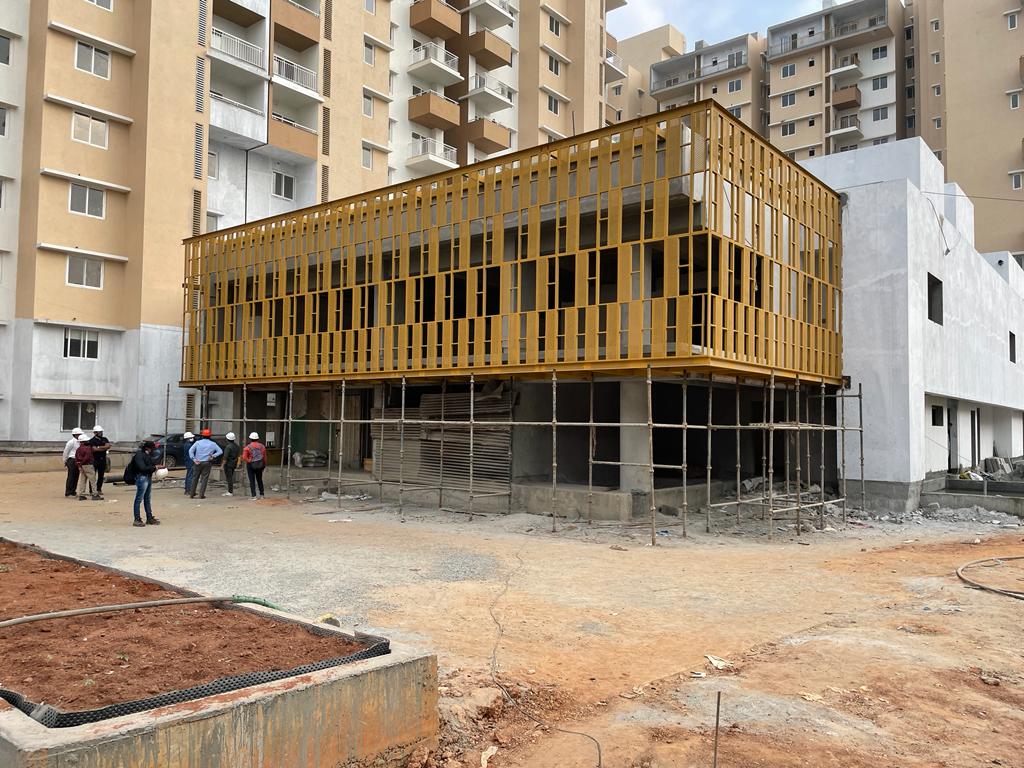

Clubhouse:
A. Structural Works : Completed
B. Block Works: Completed
C. Internal Plastering : Ground to the First floor: Completed
D. External Plastering : Completed
E. Water Proofing : Ground & First Floors Completed. Second floor in progress
Common Area Works:
Podium Structural Works – Completed
Podium driveway water proofing & screed – Work in Progress
Basement IPS Flooring – 20% completed
Landscape : Work in Progress
Swimming Pool :
70% completed – Work in Progress

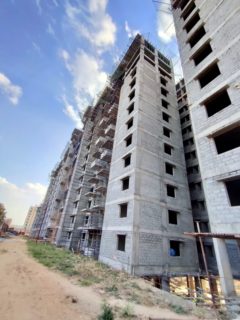

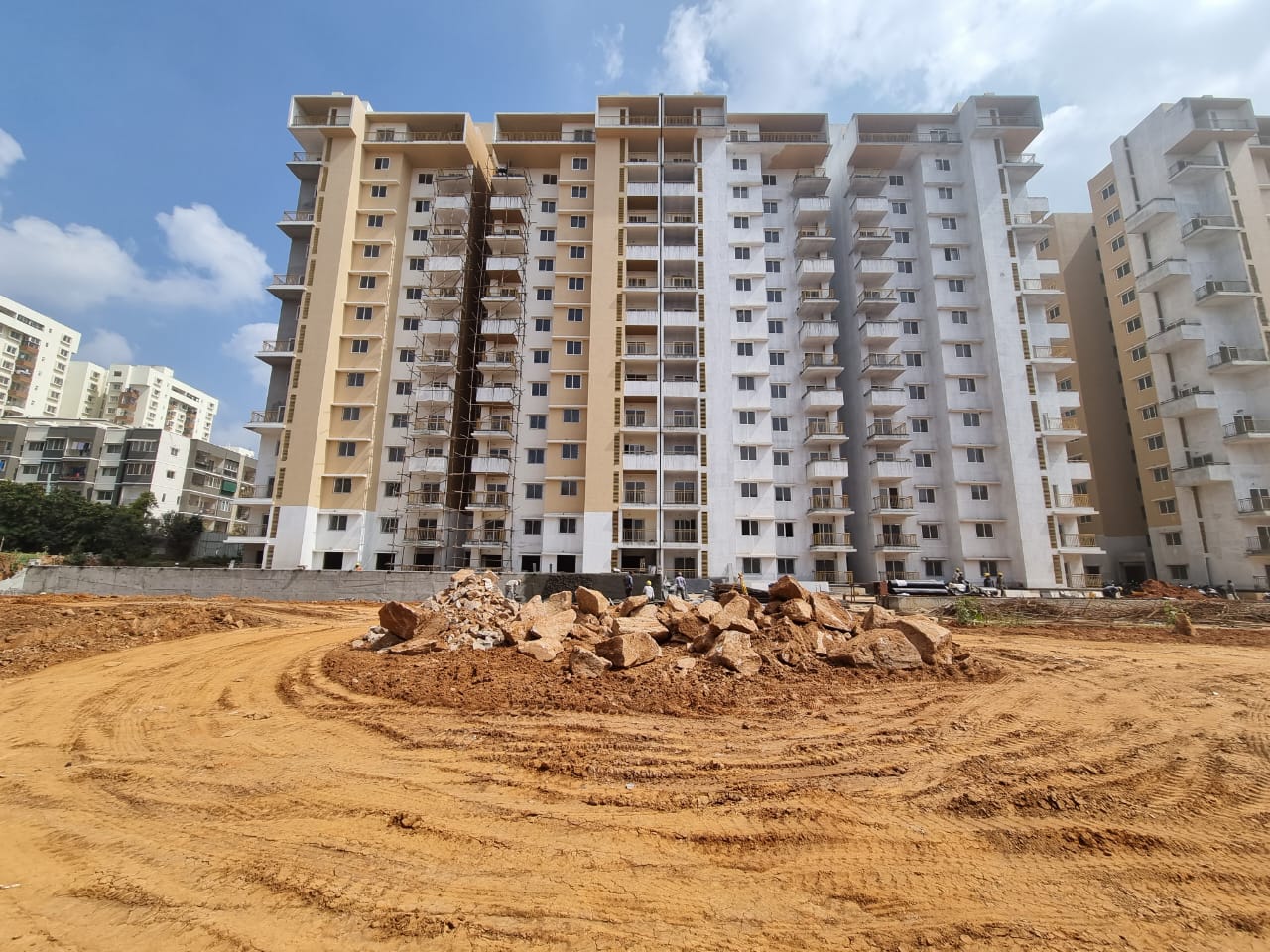

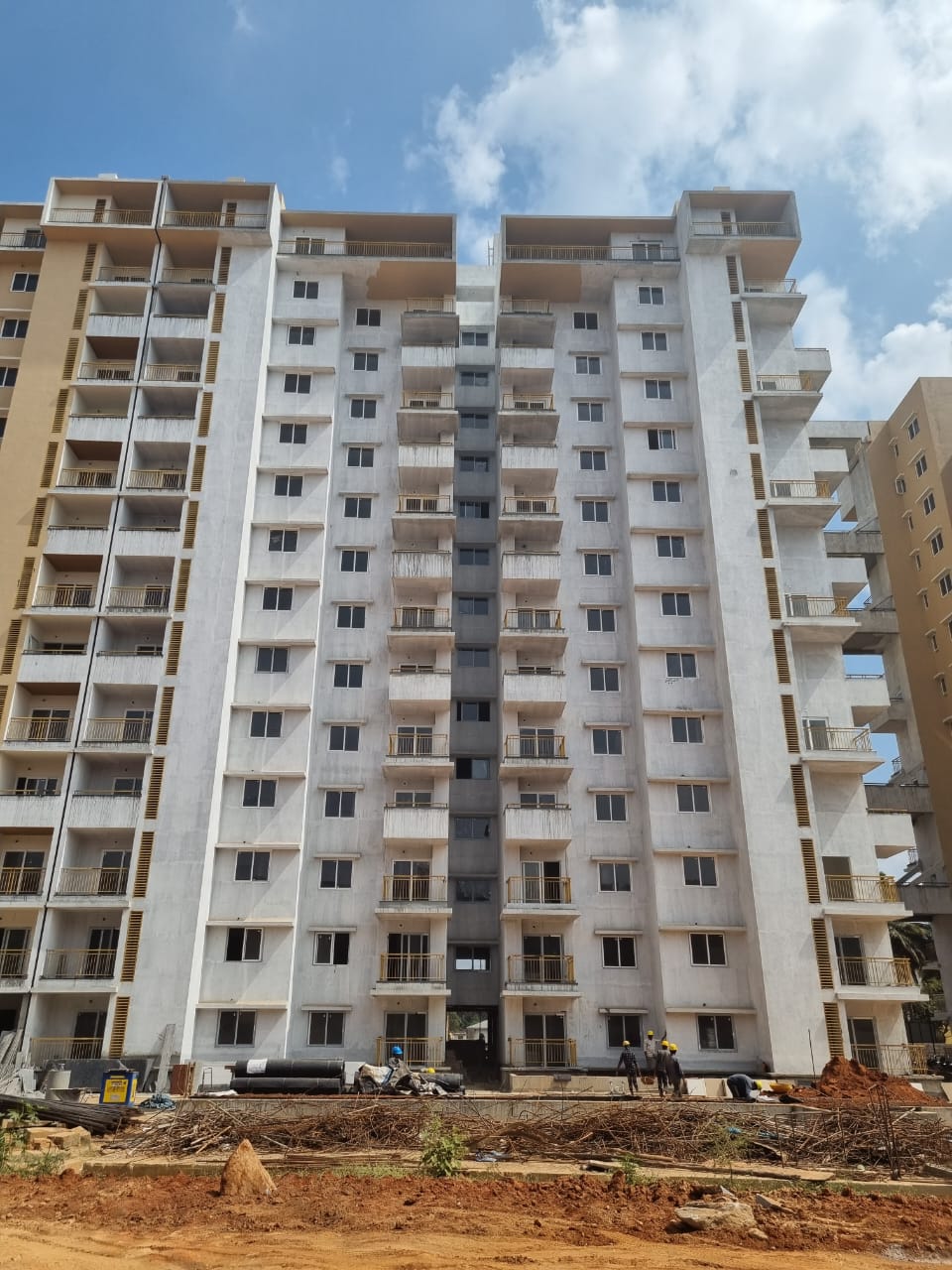

PROJECT PROGRESS REPORT AS ON 10th JANUARY 2022
Structural, Block, Internal Plastering, Electrical Works -Slab Conduiting, Electrical Works -Wall Conduiting for all towers completed.
2. Electrical Works -Switch Plate
3. Plumbing Works -PVC
4. External Plastering : Completed
5. External Primer :

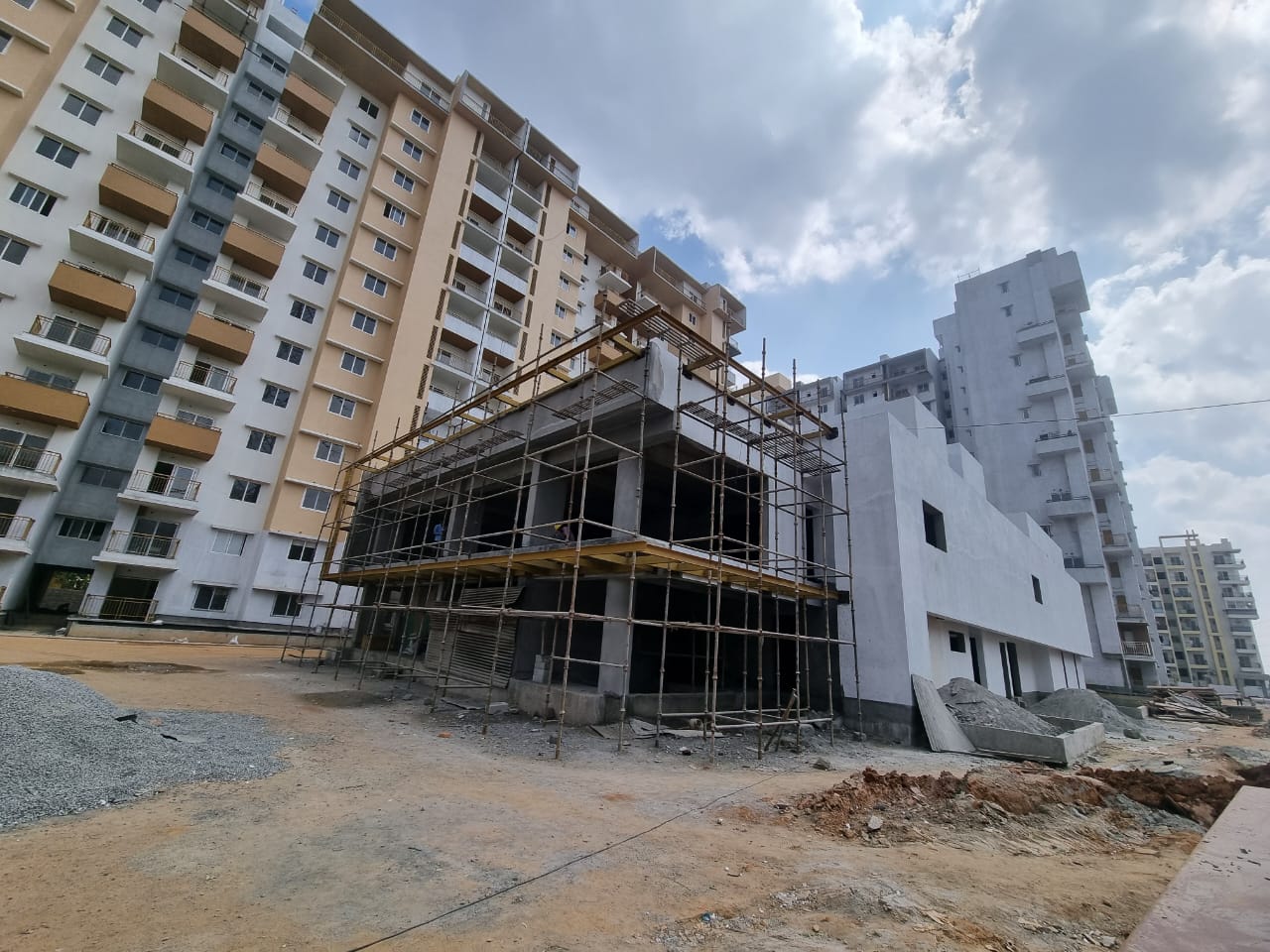

Clubhouse:
A. Structural Works : Completed
B. Block Works: Completed
C. Internal Plastering : Ground to the First floor: Completed
D. External Plastering : Completed
E. Water Proofing : Ground & First Floors Completed. Second floor in progress

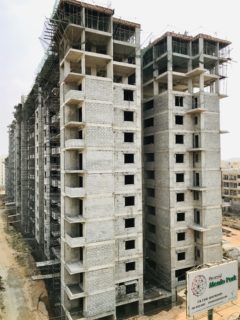

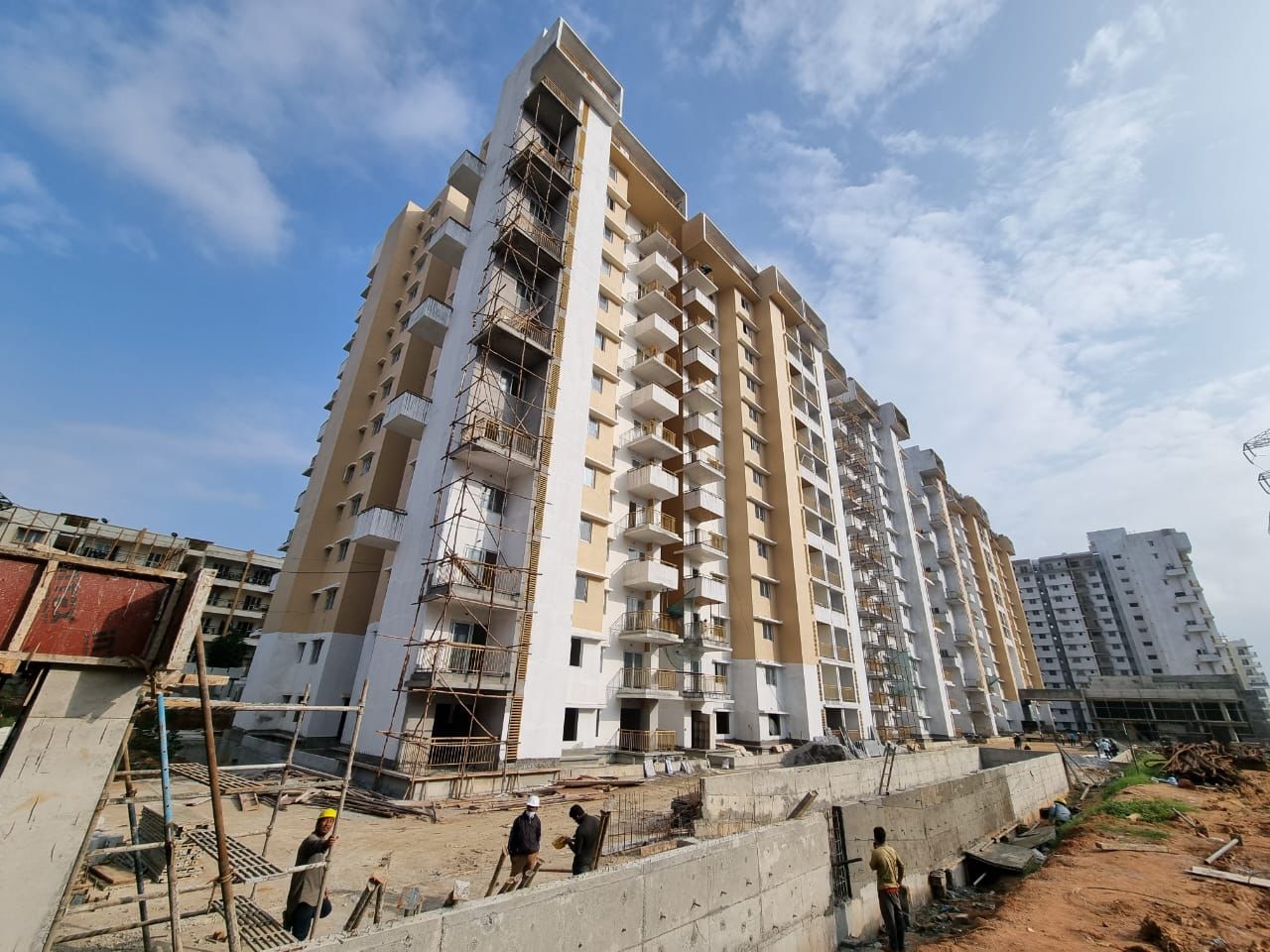

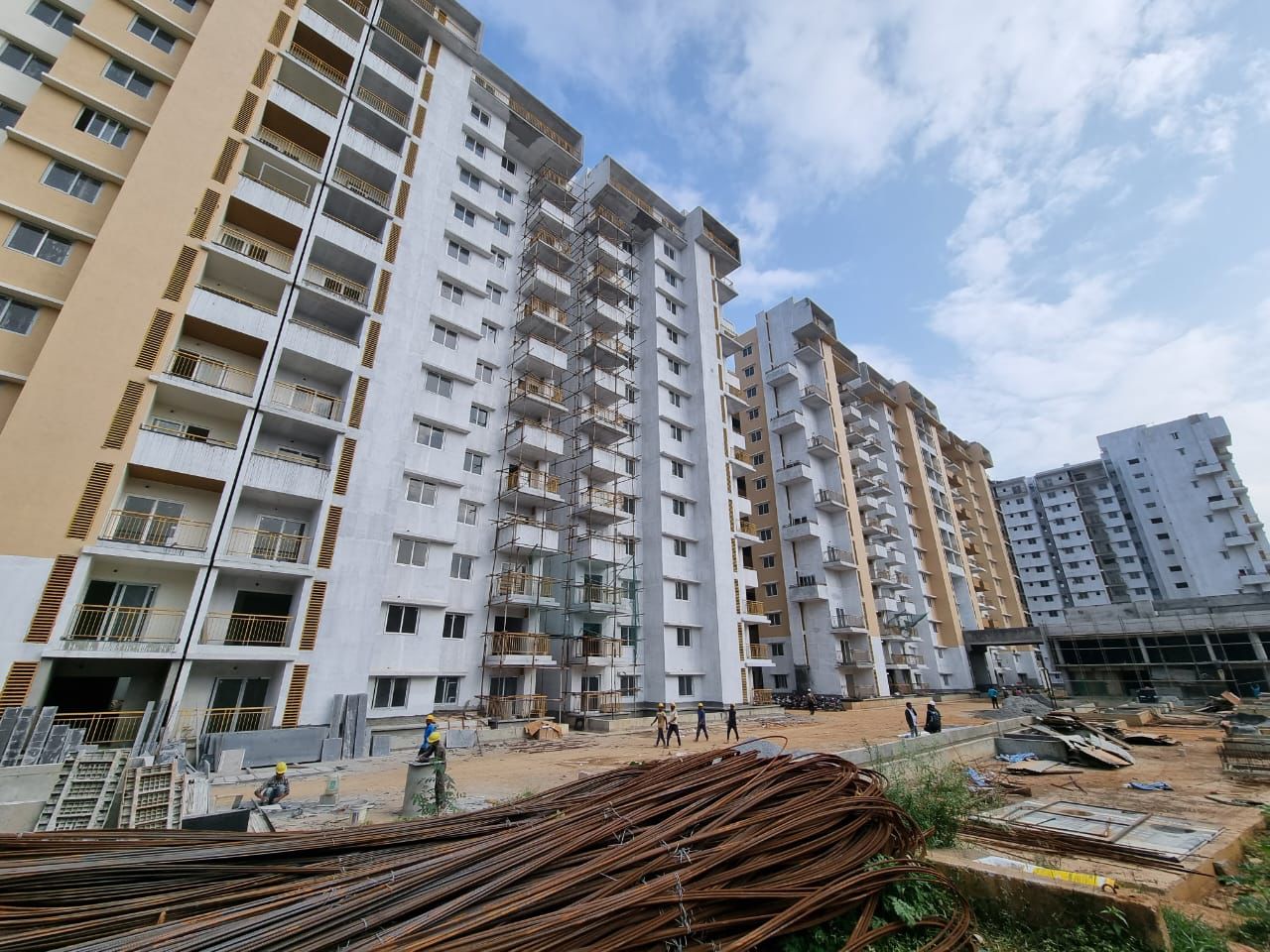

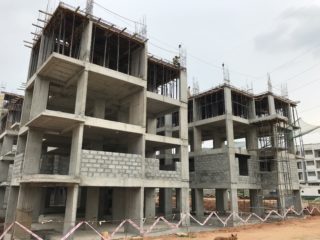

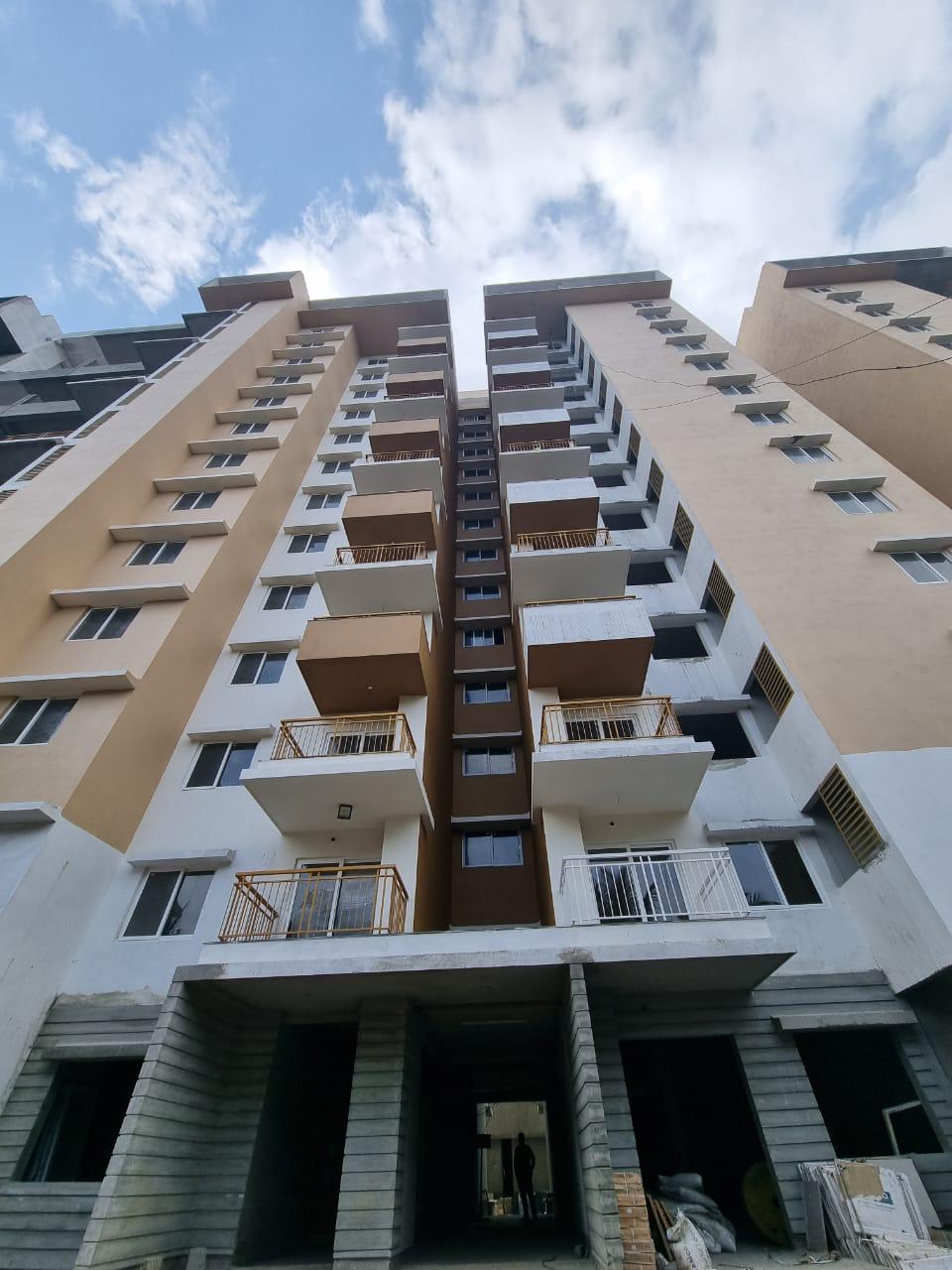

PROJECT PROGRESS REPORT AS ON 7th DECEMBER 2021
Structural, Block, Internal Plastering, Electrical Works -Slab Conduiting, Electrical Works -Wall Conduiting for all towers completed.
2. Electrical Works -Switch Plate
3. Plumbing Works -PVC
4. External Plastering : Completed
5. External Primer :

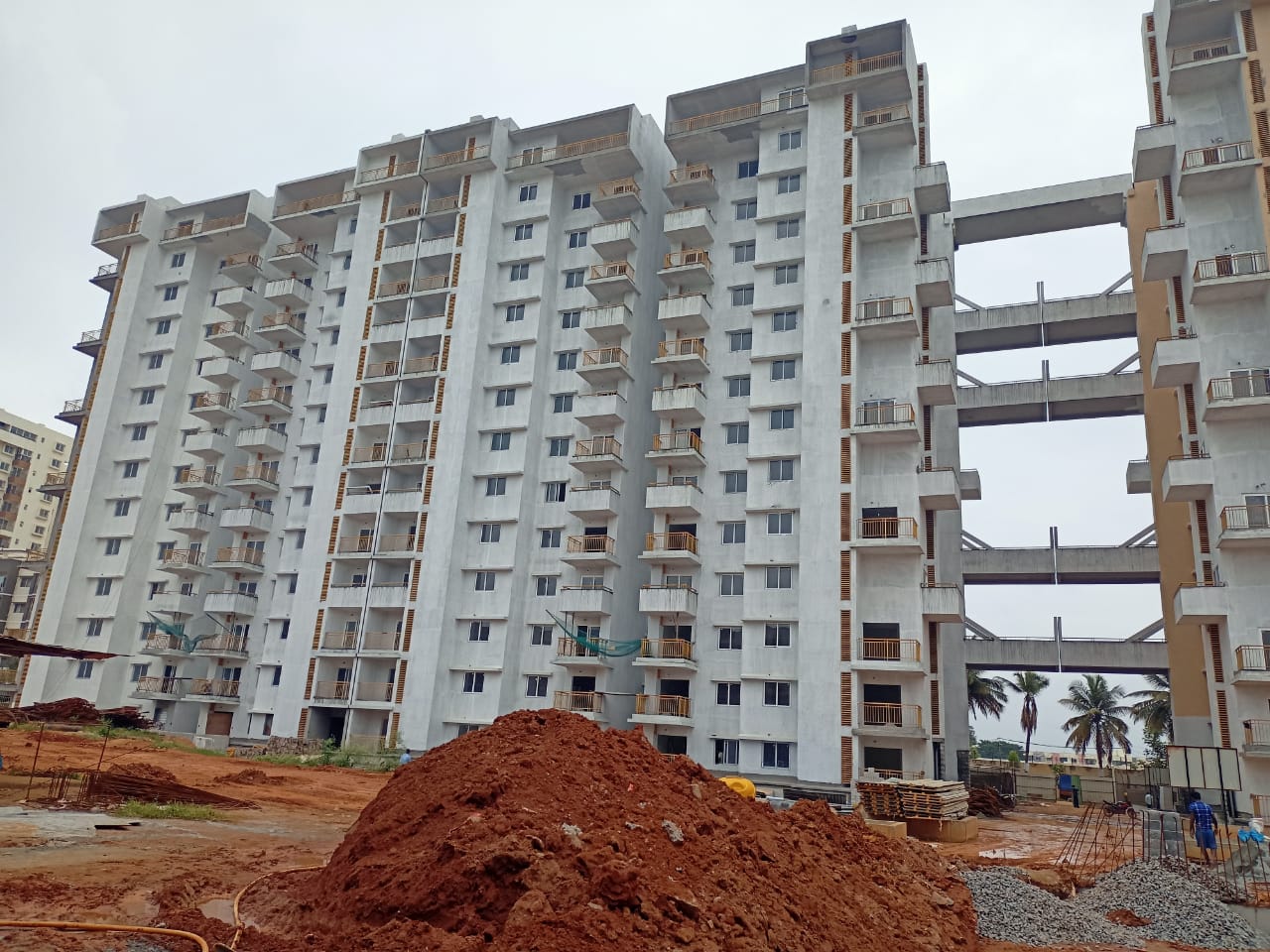

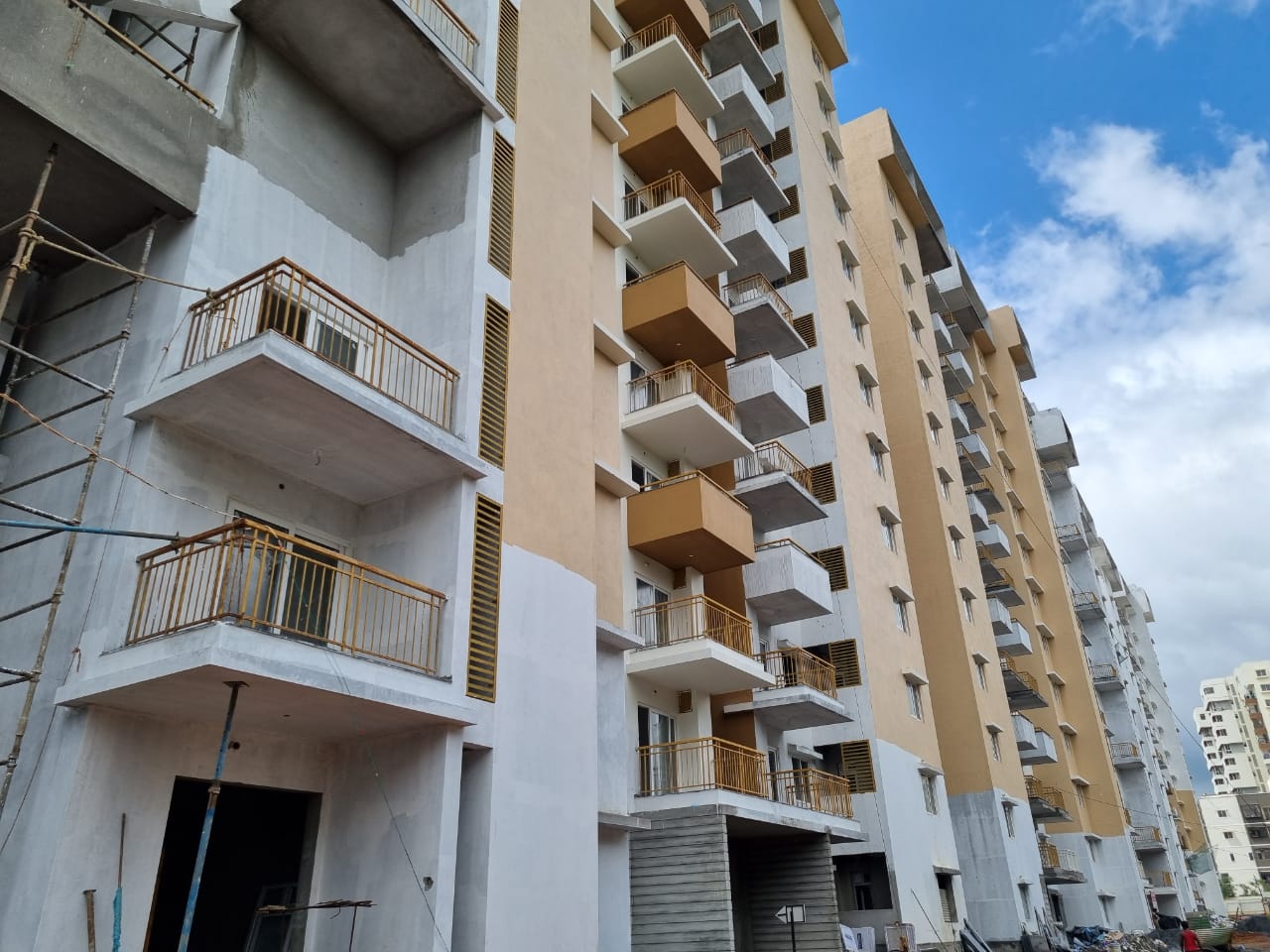

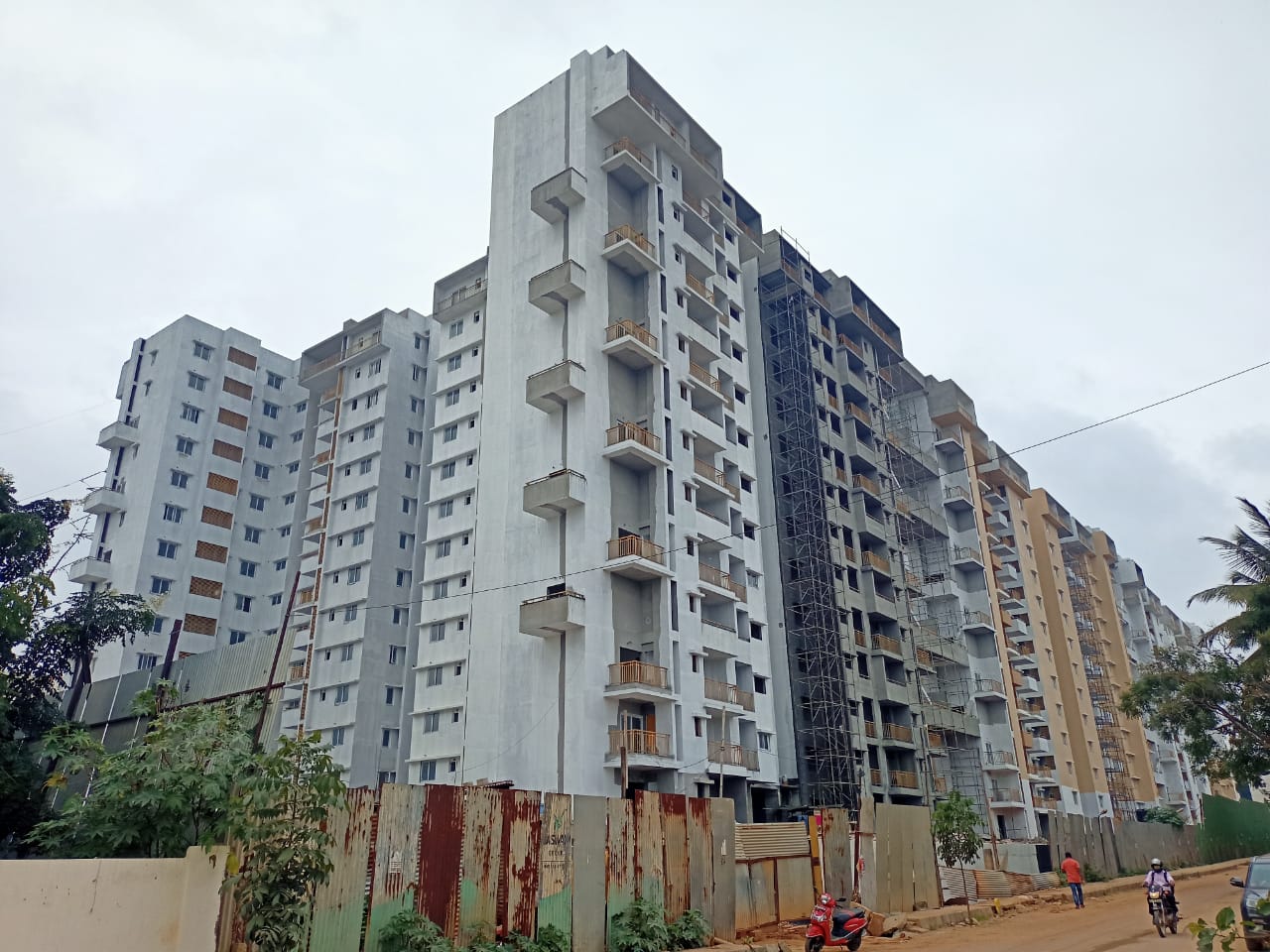

PROJECT PROGRESS REPORT AS ON 10th NOVEMBER 2021
Structural, Block, Internal Plastering, Electrical Works -Slab Conduiting, Electrical Works -Wall Conduiting for all towers completed.
2. Electrical Works -Switch Plate
3. Plumbing Works -PVC
4. External Plastering

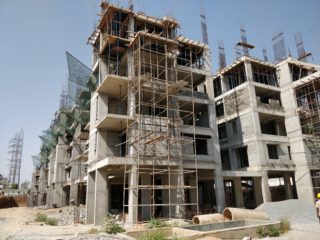

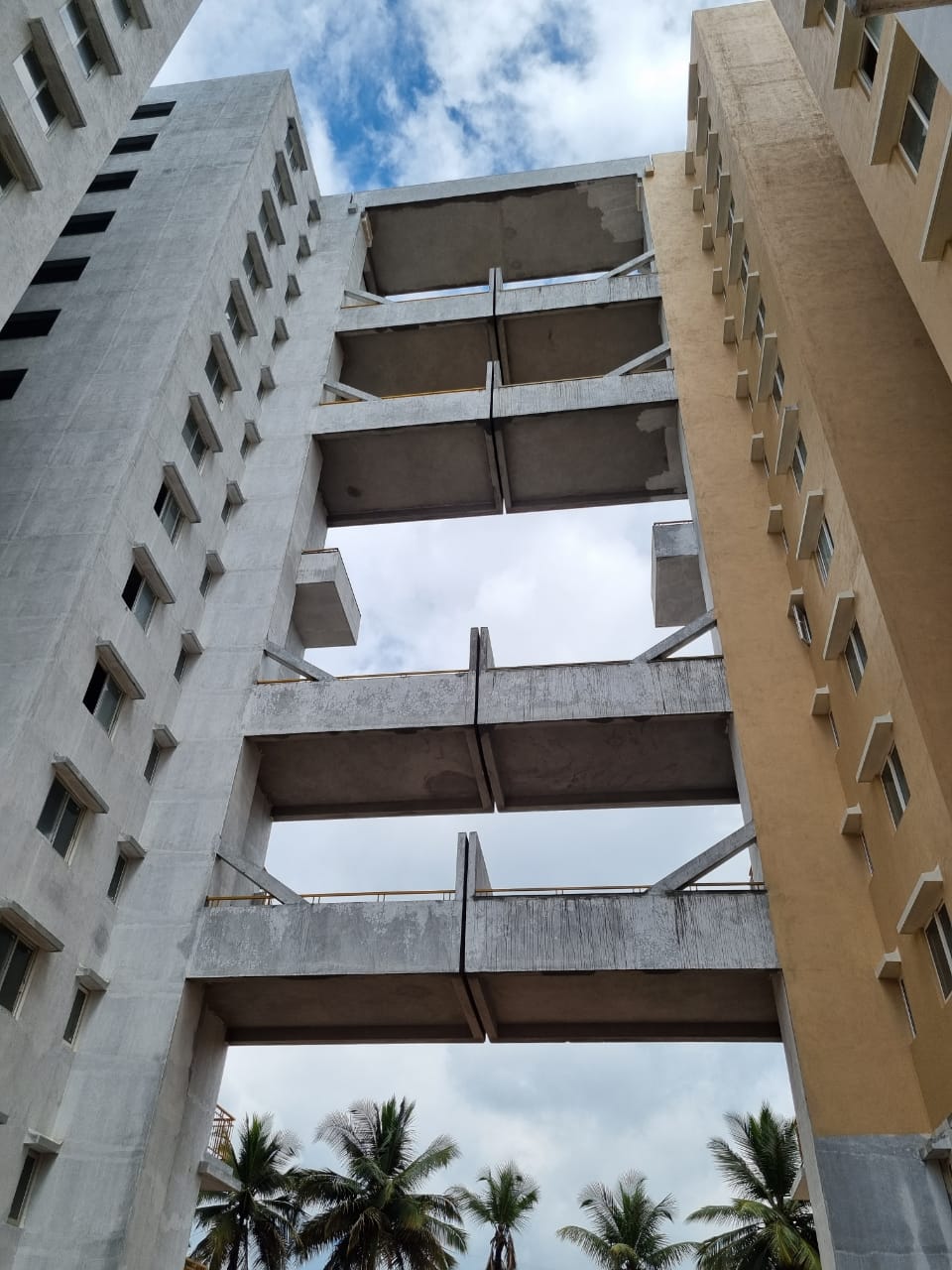

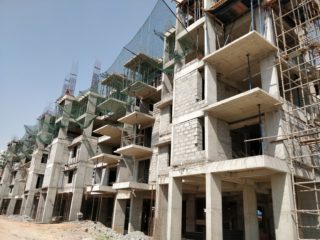

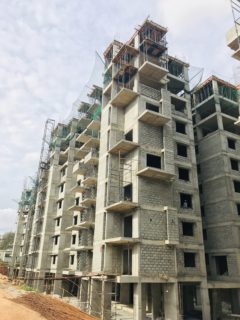

PROJECT PROGRESS REPORT AS ON 10th OCTOBER 2021
External
Podium:
Structure works on Eastern and Western Side Completed
Clubhouse:
A. Structural Works
First & Second floor: Completed
B. Block Works:
Ground to the Second floor: Completed
C. Internal Plastering
Ground to the First floor: Completed
D. External Plastering
Ground Floor Completed
First & Second Floor: In Progress

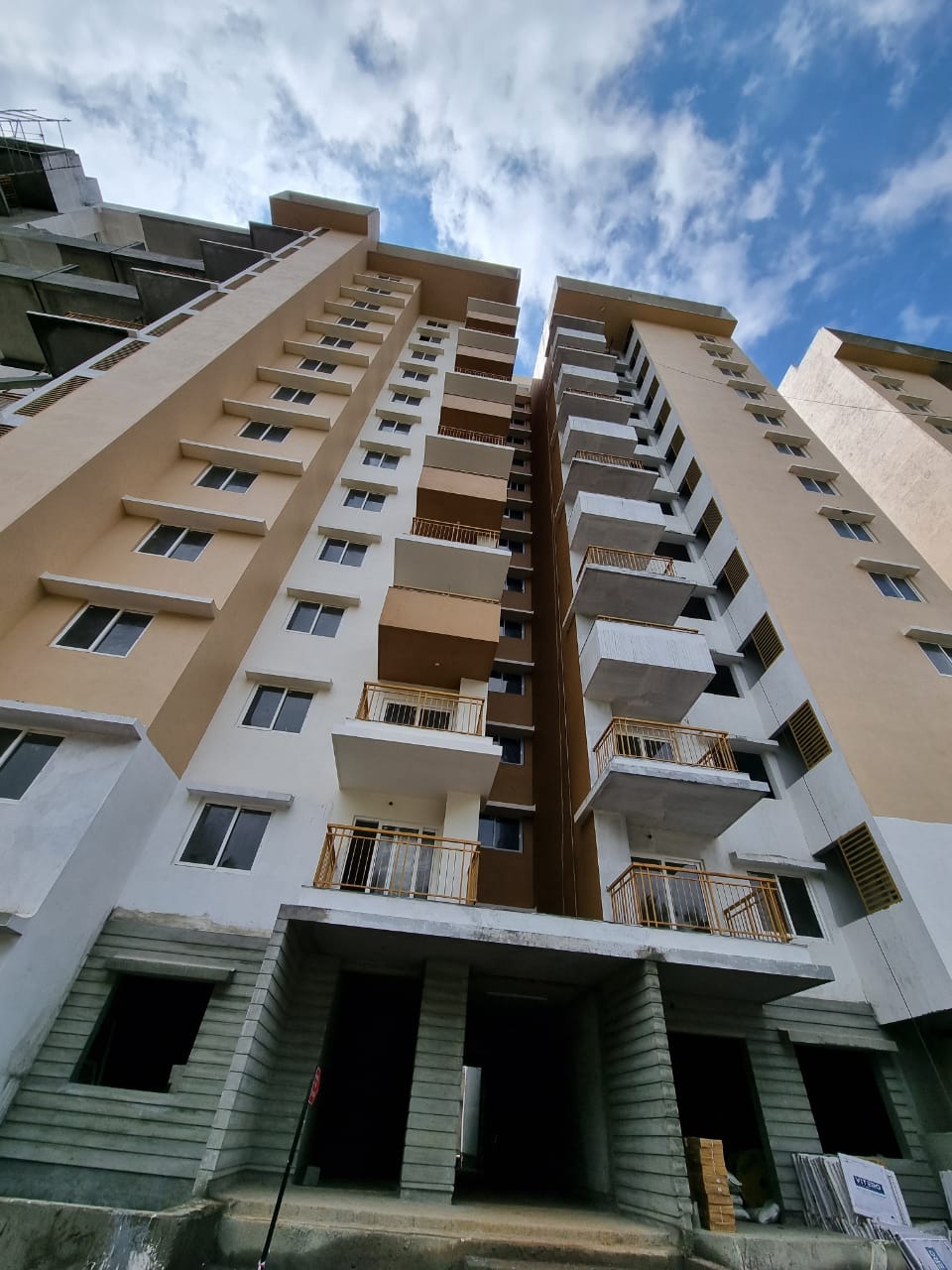

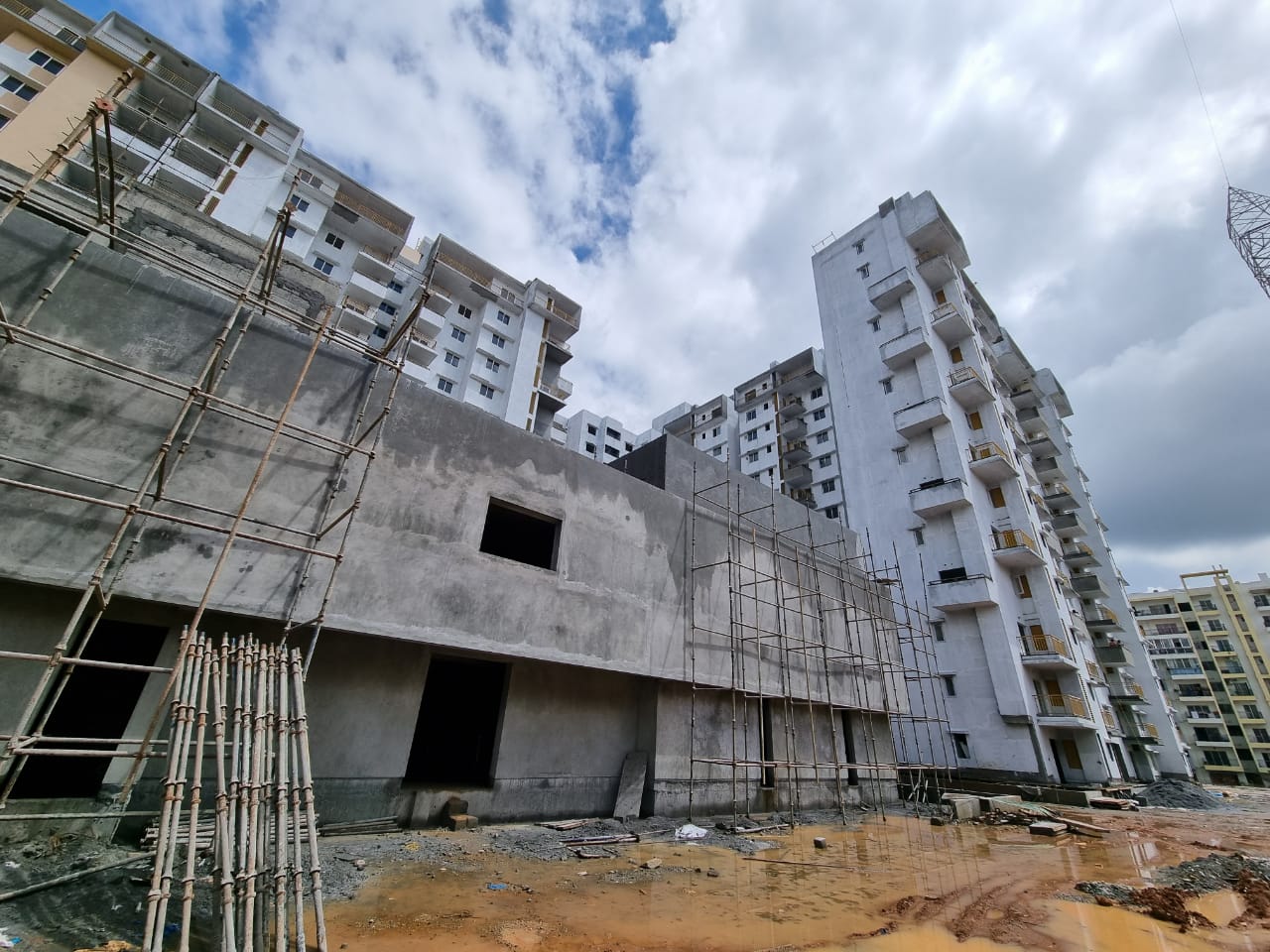

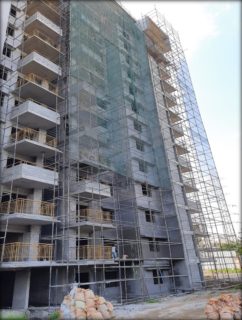

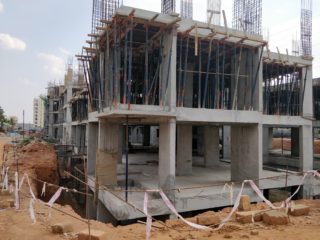

PROJECT PROGRESS REPORT AS ON 10th JULY 2021
Tower A – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. External Plastering: Completed. External Painting: Primer Completed. Plumbing Work: Completed. Flooring: 12th Floor Completed.
Tower B – Slab Work: Completed . Block Work : Completed . Internal Plastering: Completed. External Plastering: Completed. External Painting: Primer Completed. Plumbing Work: 93% Completed. Flooring: 12th Floor Completed.
Tower C – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. External Plastering: Completed. External Painting: Primer Completed. Plumbing Work: 93% Completed. Flooring: 13th Floor Completed.
Tower D – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. External Plastering: Completed. External Painting: Primer Completed. Plumbing Work: 93% Completed. Flooring: 12th Floor Completed.
Tower E – Slab Work: Completed. Block Work : Completed. Internal Plastering : Completed. External Plastering: 55% Completed. External Painting: Yet to Start. Plumbing Work: 86% Completed. Flooring: 4th Floor in Progress.
Tower F – Slab Work: Completed. Block Work : Completed. Internal Plastering: Completed. External Plastering: 93% Completed. External Painting: Yet to Start. Plumbing Work: 93% Completed. Flooring: 1st Floor in Progress.
PROJECT PROGRESS REPORT AS ON 10th JUNE 2021
Tower A – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. External Plastering: Completed. External Painting: Primer Completed. Plumbing Work: 93% Completed.
Tower B – Slab Work: Completed . Block Work : Completed . Internal Plastering: Completed. External Plastering: Completed. External Painting: Primer Completed. Plumbing Work: 93% Completed.
Tower C – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. External Plastering: Completed. External Painting: Primer Completed. Plumbing Work: 93% Completed.
Tower D – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. External Plastering: Completed. External Painting: Primer Completed. Plumbing Work: 93% Completed.
Tower E – Slab Work: Completed. Block Work : Completed. Internal Plastering : Completed. External Plastering: 55% Completed. External Painting: Yet to Start. Plumbing Work: 86% Completed.
Tower F – Slab Work: Completed. Block Work : Completed. Internal Plastering: Completed. External Plastering: 93% Completed. External Painting: Yet to Start. Plumbing Work: 93% Completed.
PROJECT PROGRESS REPORT AS ON 10th MAY 2021
Tower A – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. External Plastering: Completed. External Painting: Primer Completed.
Tower B – Slab Work: Completed . Block Work : Completed . Internal Plastering: Completed. External Plastering: Completed. External Painting: Primer Completed.
Tower C – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. External Plastering: Completed. External Painting: Primer Completed.
Tower D – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. External Plastering: Completed. External Painting: Primer Completed.
Tower E – Slab Work: Completed. Block Work : Completed. Internal Plastering : Completed. External Plastering: 50% Completed. External Painting: Yet to Start.
Tower F – Slab Work: Completed. Block Work : Completed. Internal Plastering: Completed. External Plastering: 80% Completed. External Painting: Yet to Start.
PROJECT PROGRESS REPORT AS ON 10th APRIL 2021
Tower A – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : Completed. Tilling & Dado : 30% Completed.
Tower B – Slab Work: Completed . Block Work : Completed . Internal Plastering: Completed. MEP Work : Completed. Tilling & Dado : 5th Floor Completed.
Tower C – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : Completed. Tilling & Dado : 50% Completed.
Tower D – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : Completed. Tilling & Dado : 85% Completed.
Tower E – Slab Work: Completed. Block Work : Completed. Internal Plastering : 13th Floor in progress.
Tower F – Slab Work: Completed. Block Work : Completed. Internal Plastering: Completed.

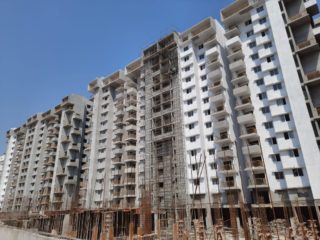

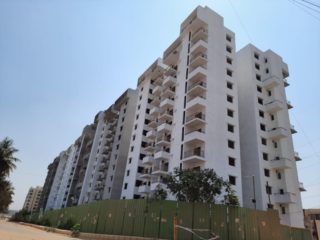

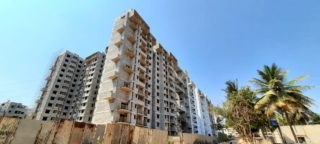

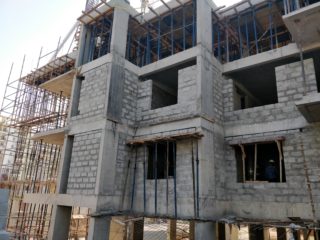

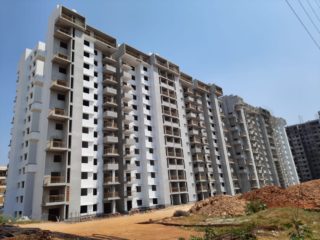

PROJECT PROGRESS REPORT AS ON 10th MARCH 2021
Tower A – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : Completed. Tilling & Dado : Work in Progress.
Tower B – Slab Work: Completed . Block Work : Completed . Internal Plastering: Completed. MEP Work : 13th Floor in Progress. Tilling & Dado : Work in Progress.
Tower C – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : Completed. Tilling & Dado : 50% Completed.
Tower D – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : Completed. Tilling & Dado : 75% Completed.
Tower E – Slab Work: Completed. Block Work : Completed. Internal Plastering : 13th Floor in progress.
Tower F – Slab Work: Completed. Block Work : Completed. Internal Plastering : Completed.
PROJECT PROGRESS REPORT AS ON 10th FEBRUARY 2021
Tower A – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : 12th Floor in Progress.
Tower B – Slab Work: Completed . Block Work : Completed . Internal Plastering: Completed. MEP Work : 12th Floor in Progress.
Tower C – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : Completed.
Tower D – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : Completed.
Tower E – Slab Work: Completed. Block Work : 13th Floor in Progress. Internal Plastering : 11th Floor in progress.
Tower F – Slab Work: Completed. Block Work : Completed. Internal Plastering : 13th Floor in progress.

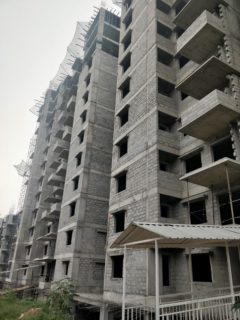

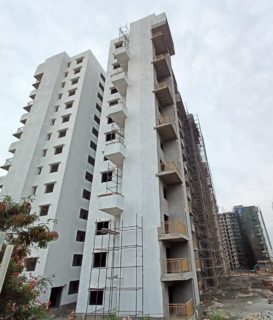

PROJECT PROGRESS REPORT AS ON 10th JANUARY 2021
Tower A – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : 12th Floor in Progress.
Tower B – Slab Work: Completed . Block Work : Completed . Internal Plastering: Completed. MEP Work : 10th Floor in Progress.
Tower C – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : Completed.
Tower D – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : Completed.
Tower E – Slab Work: Completed. Block Work : 13th Floor in Progress. Internal Plastering : 10th Floor in progress.
Tower F – Slab Work: Completed. Block Work : Completed. Internal Plastering : 12th Floor in progress.
PROJECT PROGRESS REPORT AS ON 10th DECEMBER 2020
Tower A – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed.
Tower B – Slab Work: Completed . Block Work : Completed . Internal Plastering: Completed.
Tower C – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed.
Tower D – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed.
Tower E – Slab Work: Completed. Block Work : 12th Floor in Progress. Internal Plastering : 9th Floor in progress.
Tower F – Slab Work: Completed. Block Work : 13th Floor in progress. Internal Plastering : 11th Floor in progress.
PROJECT PROGRESS REPORT AS ON 10th NOVEMBER 2020
Tower A – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed.
Tower B – Slab Work: Completed . Block Work : Completed . Internal Plastering: Completed.
Tower C – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed.
Tower D – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed.
Tower E – Slab Work: 13th Floor Slab Completed. Block Work : 10th Floor in Progress. Internal Plastering : 9th Floor in progress.
Tower F – Slab Work: Completed. Block Work : 11th Floor in progress. Internal Plastering : 9th Floor in progress.
PROJECT PROGRESS REPORT AS ON 10th OCTOBER 2020
Tower A – Slab Work : Completed. Block Work : Completed. Internal Plastering : 13th Floor in Floor in Progress.
Tower B – Slab Work: Completed . Block Work : Completed . Internal Plastering: 13th Floor in progress.
Tower C – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed.
Tower D – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed.
Tower E – Slab Work: 13th Floor Slab in progress. Block Work : 9th Floor Completed. Internal Plastering : 8th Floor in progress.
Tower F – Slab Work: Completed. Block Work : 11th Floor in progress. Internal Plastering : 8th Floor in progress.
PROJECT PROGRESS REPORT AS ON 10th SEPTEMBER 2020

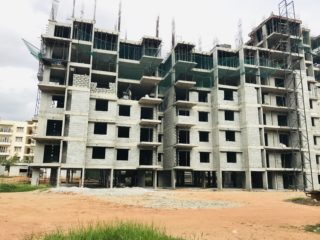

Tower A – Slab Work : Completed. Block Work : Completed. Internal Plastering : 11th Floor Completed.
Tower B – Slab Work: Completed . Block Work : Completed . Internal Plastering: 12th Floor in progress.
Tower C – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed.
Tower D – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed.
Tower E – Slab Work: 12th Floor ready to cast. Block Work : 8th Floor Completed. Internal Plastering : 6th Floor in progress.
Tower F – Slab Work: 13th Floor Completed. Block Work : 10th Floor in progress. Internal Plastering : 7th Floor in progress.
PROJECT PROGRESS REPORT AS ON 10th AUGUST 2020
Tower A – Slab Work : Completed. Block Work : 13th Floor in Progress. Internal Plastering : 10th Floor Completed.
Tower B – Slab Work: Completed . Block Work : 13th Floor in progress. Internal Plastering: 11th Floor in progress.
Tower C – Slab Work : Completed. Block Work : Completed. Internal Plastering : 13th Floor in Progress.
Tower D – Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed.
Tower E – Slab Work: 11th Floor in Progress. Block Work : 7th Floor Completed. Internal Plastering : 5th Floor in progress.
Tower F – Slab Work: 12th Floor Completed. Block Work : 9th Floor in progress. Internal Plastering : 6th Floor in progress.
PROJECT PROGRESS REPORT AS ON 10th JULY 2020
Tower A – Slab Work : Completed. Block Work : 12th Floor in Progress. Internal Plastering : 10th Floor Completed.
Tower B – Slab Work: Completed . Block Work : 12th Floor in progress. Internal Plastering: 10th Floor Completed.
Tower C – Slab Work : Completed. Block Work : Completed. Internal Plastering : 13th Floor in Progress.
Tower D – Slab Work : Completed. Block Work : Completed. Internal Plastering : 12th Floor completed.
Tower E – Slab Work: 10th Floor Slab Completed. Block Work : 7th Floor in Progress. Internal Plastering : 4th Floor in progress.
Tower F – Slab Work: 11th Floor Slab Completed. Block Work : 8th Floor in progress. Internal Plastering : 5th Floor in progress.
PROJECT PROGRESS REPORT AS ON 10th JUNE 2020
Tower A – Slab Work : Completed. Block Work : 11th Floor in Progress. Internal Plastering : 8th Floor Completed.
Tower B – Slab Work: Completed . Block Work : 11th Floor in progress. Internal Plastering: 9th Floor Completed.
Tower C – Slab Work : Completed. Block Work : Completed. Internal Plastering : 11th Floor Completed.
Tower D – Slab Work : Completed. Block Work : Completed. Internal Plastering : 11th Floor completed.
Tower E – Slab Work: 9th Floor Slab Completed. Block Work : 6th Floor in Progress. Internal Plastering : 3rd Floor in progress.
Tower F – Slab Work: 10th Floor Slab Completed. Block Work : 7th Floor in progress. Internal Plastering : 5th Floor in progress.
We are happy to share that we are back to work and our construction sites are active as well (since April 27th). As there are nearly 250 workers on site, we are leaving no stone unturned for safety within the premises. As responsible citizens, wearing a mask, regular hand sanitization, thermal screening, maintaining physical distance, etc. are the stringent protocols that are being followed across our sites and offices.

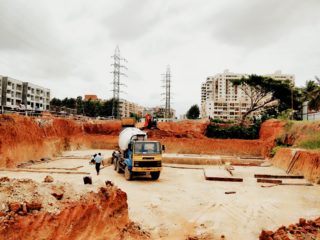

PROJECT PROGRESS REPORT AS ON 10th MAY 2020
Tower A – Slab Work : 13th Floor Slab Completed. Block Work : 10th Floor in Progress. Internal Plastering : 8th Floor Completed.
Tower B – Slab Work: Terrace Floor Slab Ready to be casted. Block Work : 11th Floor in progress. Internal Plastering: 9th Floor Completed.
Tower C – Slab Work : Terrace Slab Completed. Block Work : 12th Floor in progress. Internal Plastering : 10th Floor Completed.
Tower D – Slab Work : Terrace Slab Completed. Block Work : 13th Floor in progress. Internal Plastering : 10th Floor completed.

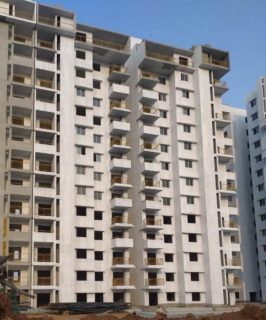

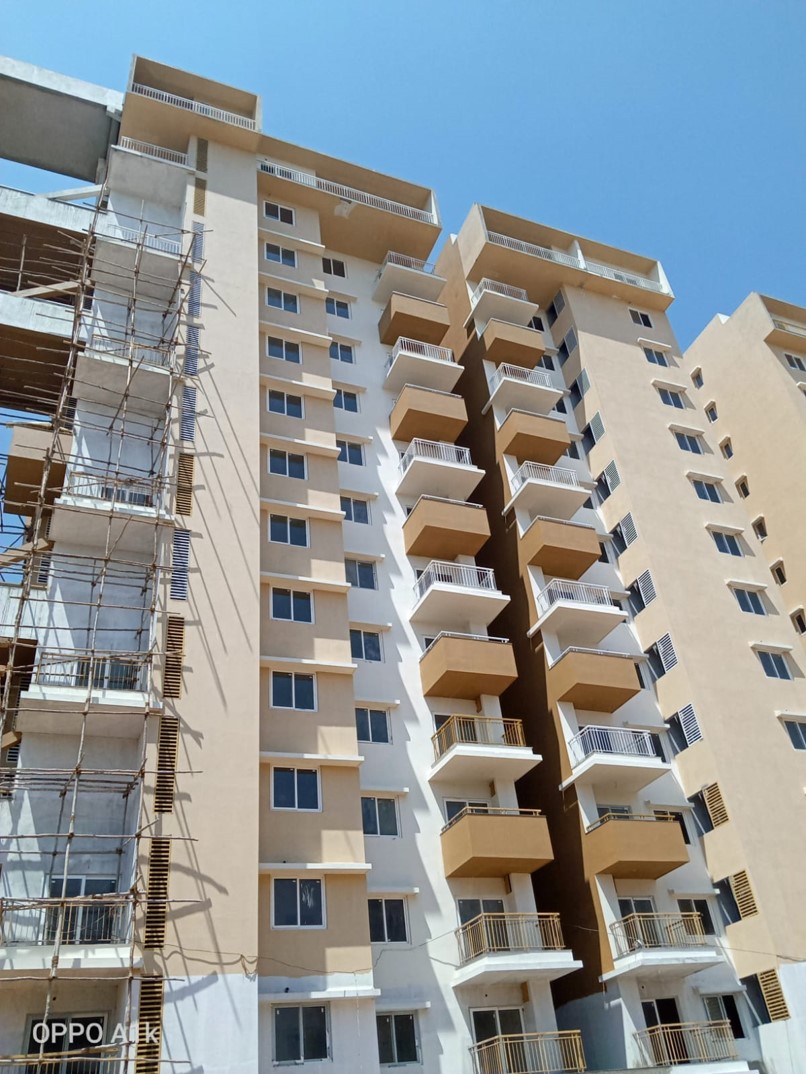

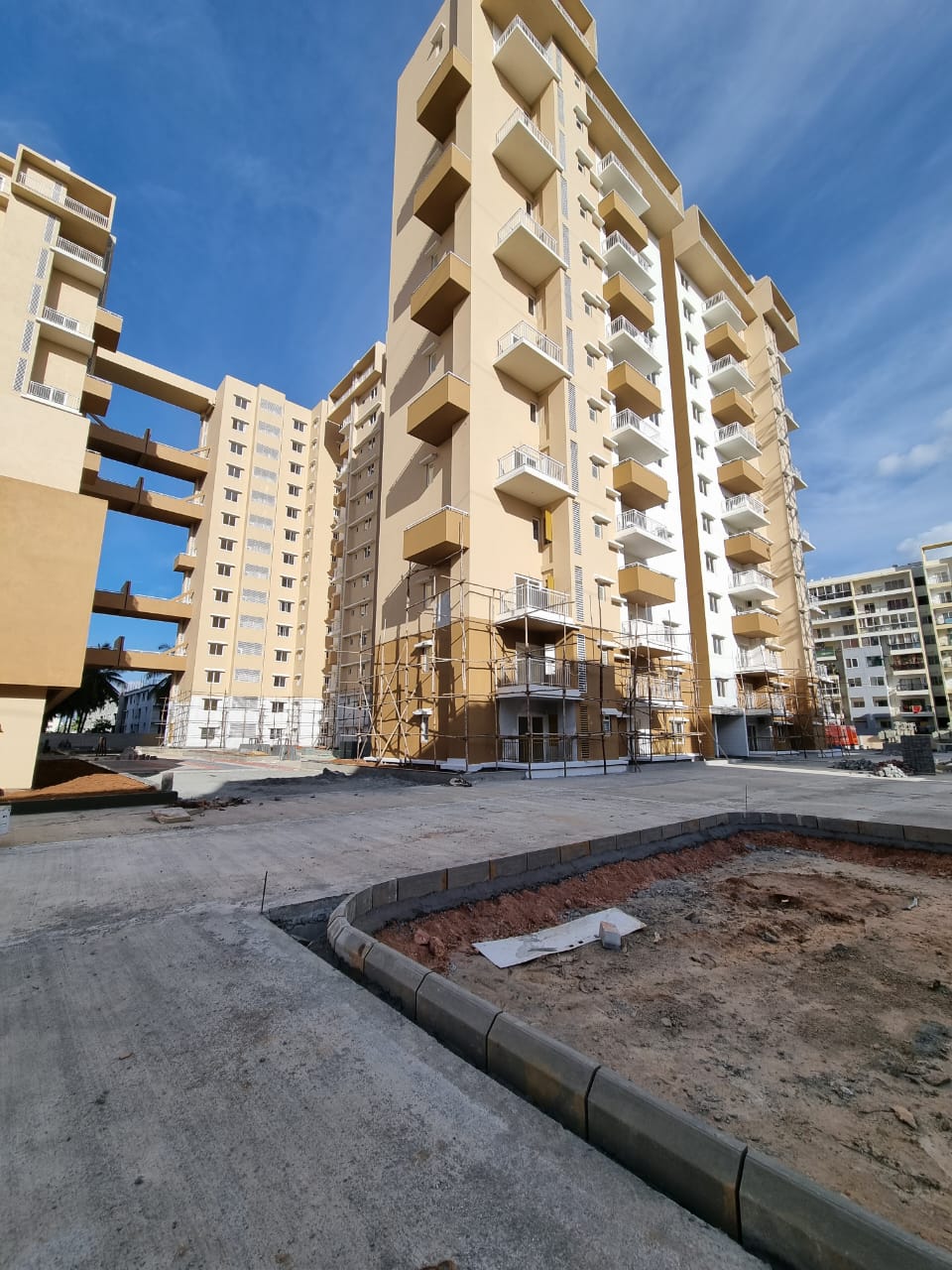

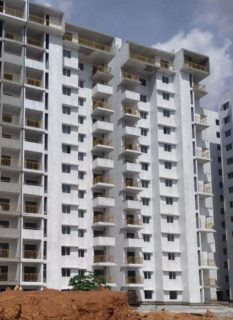

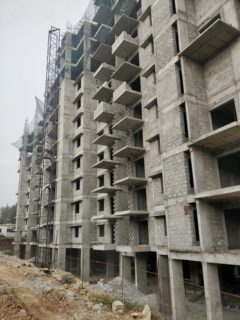

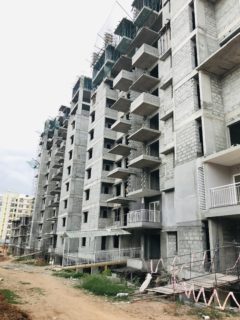

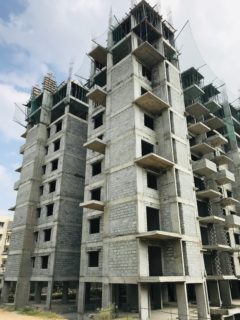

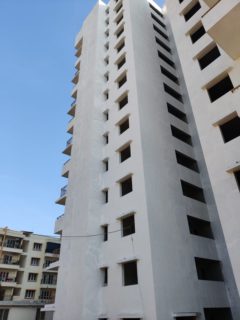

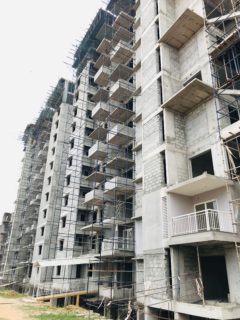

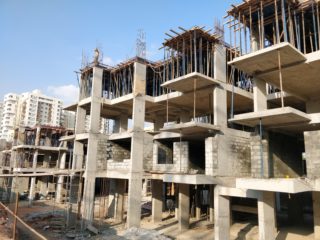

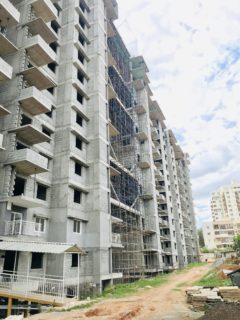

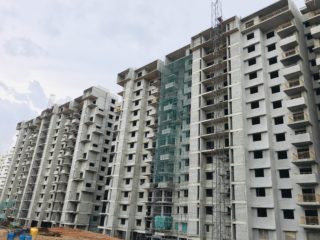

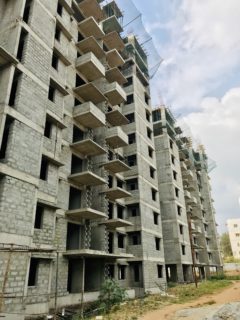

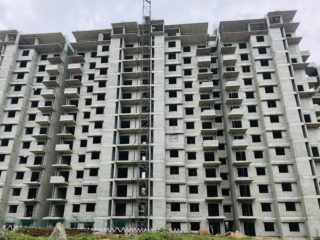

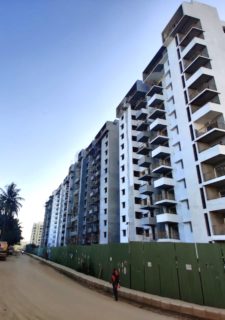

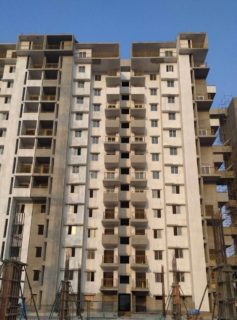

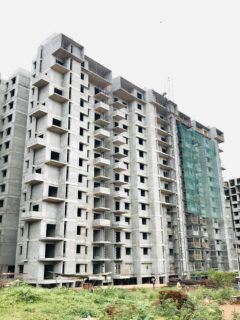

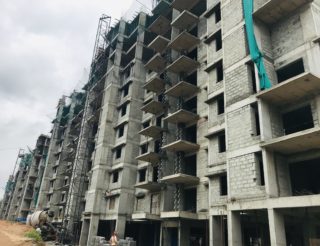

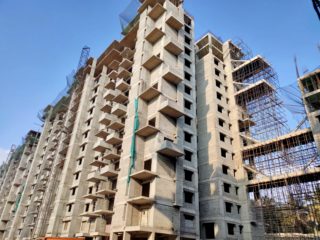

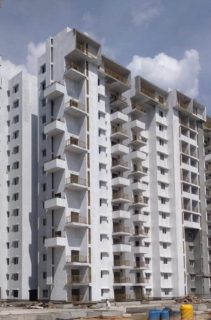

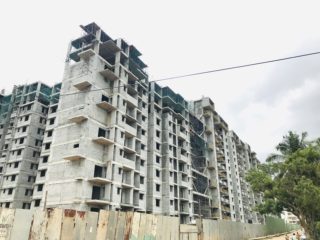

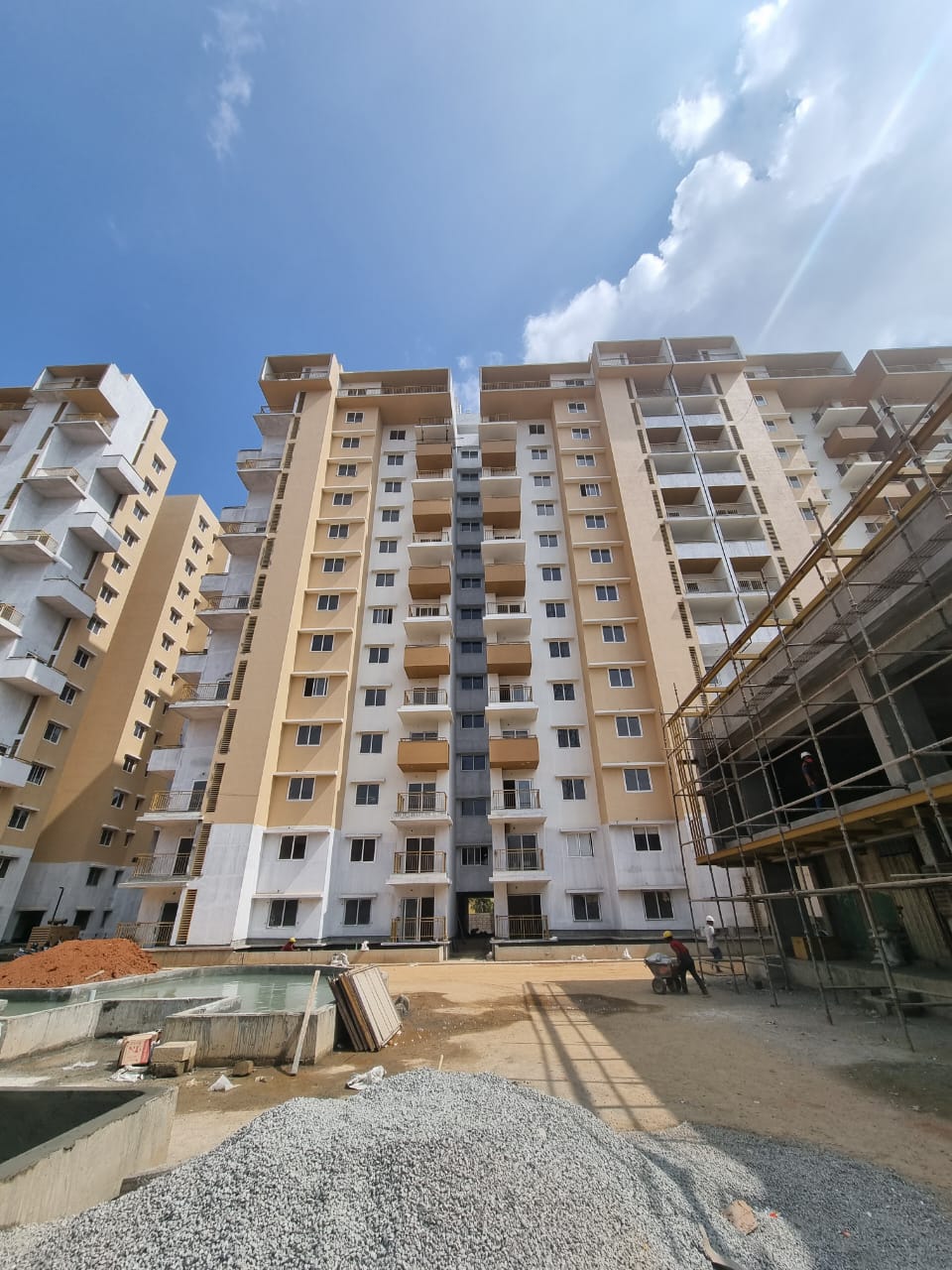

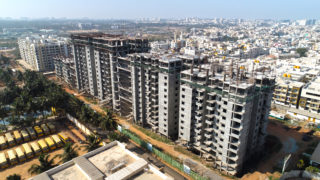

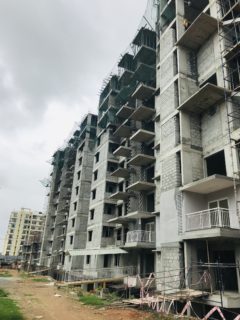

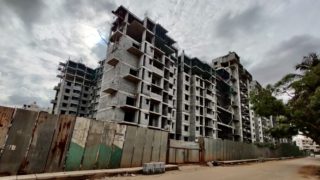

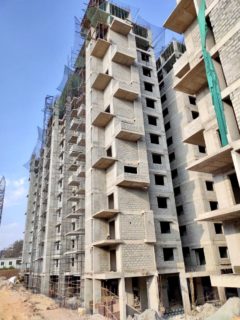

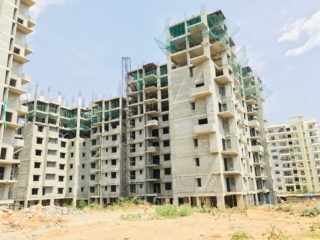

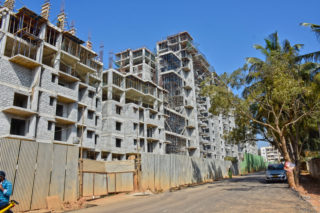

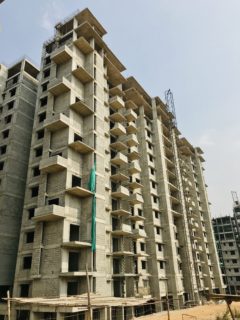

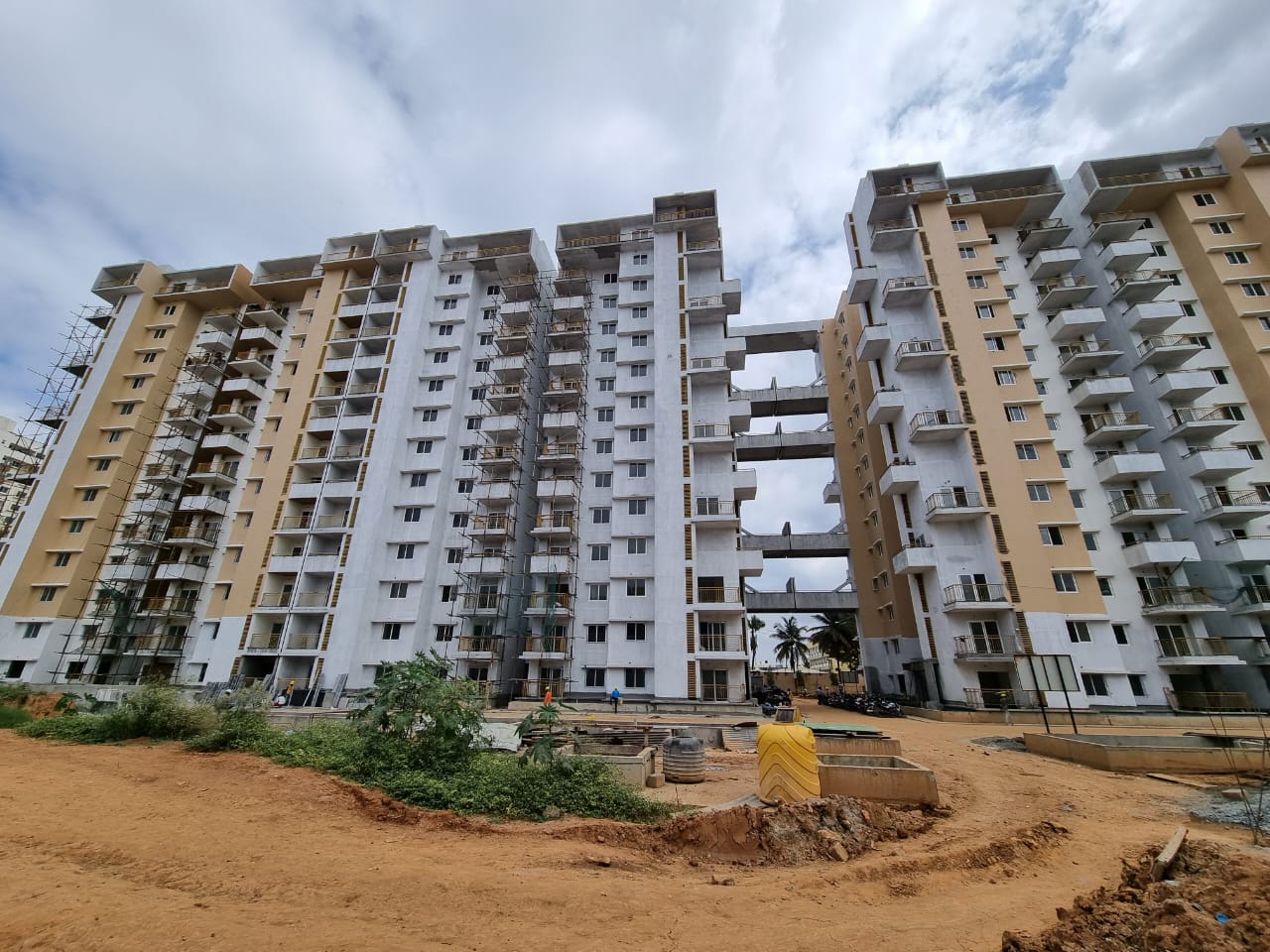

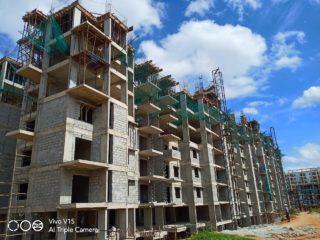

Tower E – Slab Work: 8th Floor Slab Completed. Block Work : 5th Floor in Progress. Internal Plastering : 3rd Floor in progress.
Tower F – Slab Work: 10th Floor Slab Ready to be casted. Block Work : 6th Floor in progress. Internal Plastering : 4th Floor Completed .

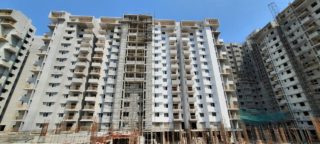

PROJECT PROGRESS REPORT AS ON 10th MARCH 2020

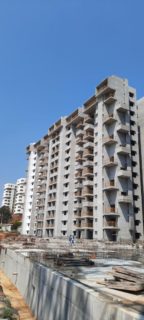

Tower A – Slab Work : 13th Floor Slab Completed. Block Work : 9th Floor Completed. Internal Plastering : 6th Floor Completed.
Tower B – Slab Work: 13th Floor Slab Completed. Block Work : 10th Floor Completed. Internal Plastering: 8th Floor Completed.
Tower C – Slab Work : Terrace Slab Completed. Block Work : 11th Floor Completed. Internal Plastering : 8th Floor Completed.
Tower D – Slab Work : Terrace Slab Completed. Block Work : 12th Floor Completed. Internal Plastering : 9th Floor completed.
Tower E – Slab Work: 8th Floor Slab Completed. Block Work : 4th Floor Completed. Internal Plastering : 1st Floor in progress.
Tower F – Slab Work: 9th Floor Slab Completed. Block Work : 5th Floor Completed. Internal Plastering : 2nd Floor Completed .
PROJECT PROGRESS REPORT AS ON 10th FEBRUARY 2020
Tower A – Slab Work : 12th Floor Slab Completed. Block Work : 8th Floor Completed. Internal Plastering : 6th Floor Completed.
Tower B – Slab Work: 12th Floor Slab Completed. Block Work : 9th Floor Completed. Internal Plastering: 8th Floor Completed.
Tower C – Slab Work : Terrace Slab Completed. Block Work : 10th Floor Completed. Internal Plastering : 8th Floor Completed.
Tower D – Slab Work : Terrace Slab Completed. Block Work : 11th Floor Completed. Internal Plastering : 9th Floor completed.
Tower E – Slab Work: 6th Floor Slab Completed. Block Work : 3rd Floor Completed. Internal Plastering : 1st Floor in progress.
Tower F – Slab Work: 8th Floor Slab Completed. Block Work : 4th Floor Completed. Internal Plastering : 2nd Floor Completed .

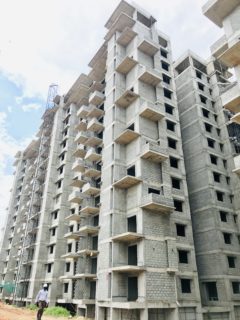

PROJECT PROGRESS REPORT AS ON 10th JANUARY 2020
Tower A – Slab Work : 11th Floor Slab Completed. Block Work : 7th Floor Completed. Internal Plastering : 5th Floor Completed.
Tower B – Slab Work: 12th Floor Slab Completed. Block Work : 9th Floor Completed. Internal Plastering: 7th Floor Completed.
Tower C – Slab Work : 14th Floor Slab Completed. Block Work : 10th Floor Completed. Internal Plastering : 7th Floor Completed.
Tower D – Slab Work : 14th Floor Slab Completed. Block Work : 10th Floor Completed. Internal Plastering : 8th Floor completed.
Tower E – Slab Work: 6th Floor Slab Completed. Block Work : 3rd Floor Completed. Internal Plastering : 1st Floor in progress.
Tower F – Slab Work: 7th Floor Slab Completed. Block Work : 3rd Floor Completed. Internal Plastering : 1st Floor Completed .

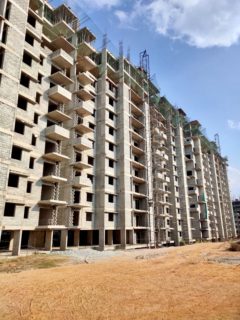

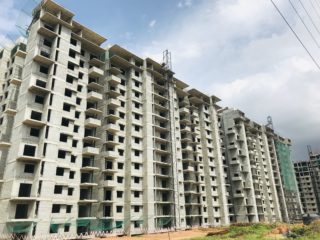

PROJECT PROGRESS REPORT AS ON 10th DECEMBER 2019
Tower A – Slab Work : 10th Floor Slab Completed. Block Work : 6th Floor Completed. Internal Plastering : 4th Floor Completed.
Tower B – Slab Work: 11th Floor Slab Completed. Block Work : 8th Floor Completed. Internal Plastering: 5th Floor Completed.
Tower C – Slab Work : 13th Floor Slab Completed. Block Work : 10th Floor Completed. Internal Plastering : 6th Floor Completed.
Tower D – Slab Work : 13th Floor Slab Completed. Block Work : 9th Floor Completed. Internal Plastering : 8th Floor completed.
Tower E – Slab Work: 5th Floor Slab Completed. Block Work : 2nd Floor Completed.
Tower F – Slab Work: 6th Floor Slab Completed. Block Work : 3rd Floor Completed. Internal Plastering : 1st Floor in Progress.

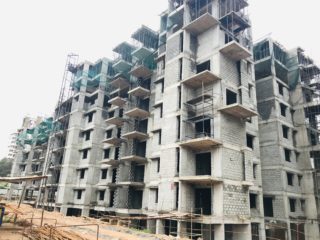

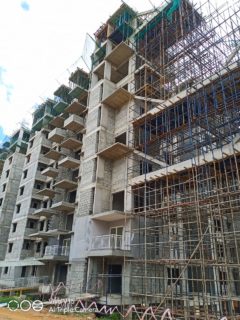

PROJECT PROGRESS REPORT AS ON 10th NOVEMBER 2019

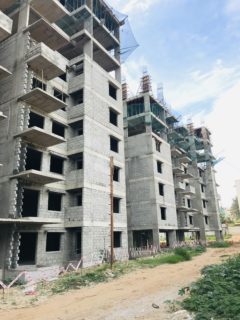

Tower A – Slab Work : 9th Floor Slab Completed. Block Work : 5th Floor Completed. Internal Plastering : 2nd Floor Completed.
Tower B – Slab Work: 10th Floor Slab Completed. Block Work : 7th Floor Completed. Internal Plastering: 3rd Floor Completed.
Tower C – Slab Work : 12th Floor Slab Completed. Block Work : 8th Floor Completed. Internal Plastering : 4th Floor Completed.
Tower D – Slab Work : 12th Floor Slab Completed. Block Work : 8th Floor Completed. Internal Plastering : 7th Floor completed.
Tower E – Slab Work: 4th Floor Slab Completed.
Tower F – Slab Work: 6th Floor Slab Completed. Block Work : 2nd Floor in progress.

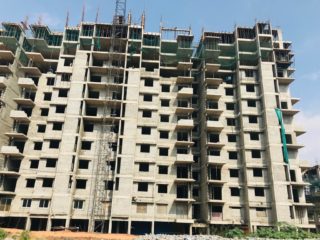

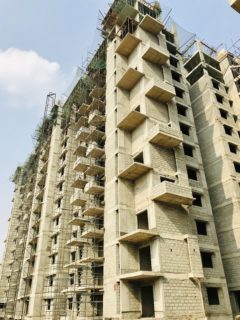

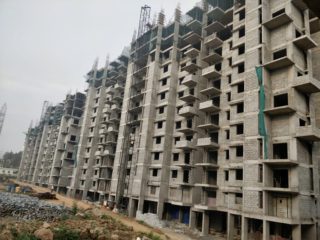

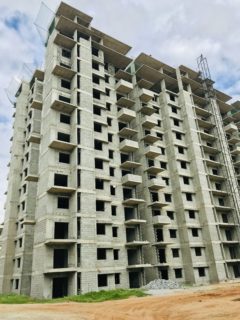

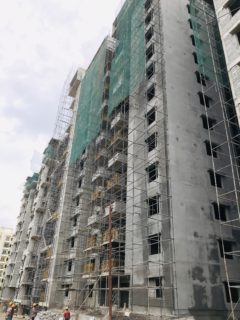

PROJECT PROGRESS REPORT AS ON 10th OCTOBER 2019

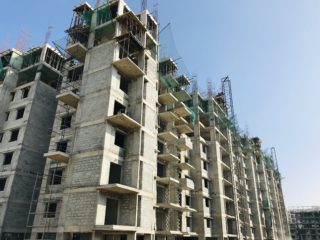

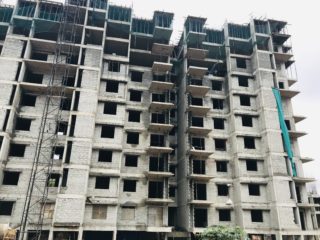

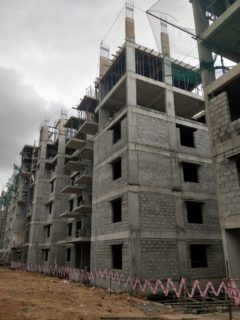

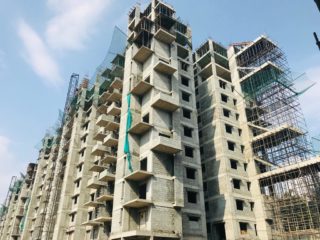

Tower A – Slab Work : 8th Floor Slab Completed. Block Work : 4th Floor Completed. Internal Plastering : 1st Floor Completed.
Tower B – Slab Work: 9th Floor Slab Completed. Block Work : 6th Floor Completed. Internal Plastering: 2nd Floor Completed.
Tower C – Slab Work : 11th Floor Slab Completed. Block Work : 6th Floor Completed. Internal Plastering : 3rd Floor Completed.
Tower D – Slab Work : 11th Floor Slab Completed. Block Work : 7th Floor Completed. Internal Plastering : 6th Floor completed.
Tower E – Slab Work: 4th Floor Slab Completed.
Tower F – Slab Work: 5th Floor Slab Completed. Block Work : 1st Floor in progress.

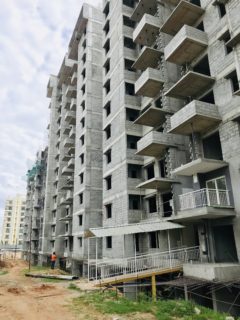

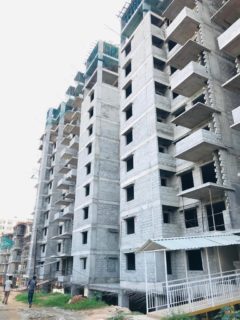

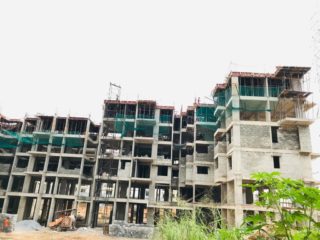

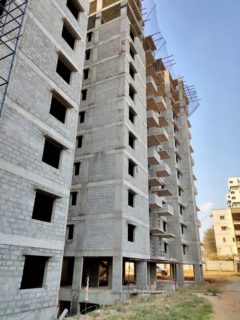

PROJECT PROGRESS REPORT AS ON 10th SEPTEMBER 2019
Tower A – Slab Work : 7th Floor Slab Completed. Block Work : 3rd Floor Completed. Internal Plastering : 1st Floor in Progress
Tower B – Slab Work: 8th Floor Slab Completed. Block Work: 5th Floor Completed. Internal Plastering: 1st Floor In Progress.
Tower C – Slab Work : 10th Floor Slab Completed. Block Work : 5th Floor Completed. Internal Plastering : 3rd Floor in progress.
Tower D – Slab Work : 10th Floor Slab Completed. Block Work : 6th Floor Completed. Internal Plastering : 3rd Floor completed.
Tower E – Slab Work: 2nd Floor Slab Completed.
Tower F- Slab Work: 4th Floor Slab Completed. Block Work : 1st Floor in progress.

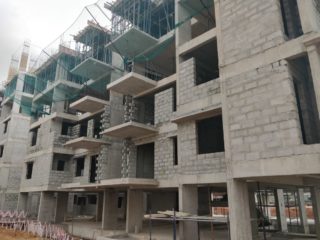

PROJECT PROGRESS REPORT AS ON 10th AUGUST 2019
Tower A – Slab Work : 6th Floor Slab Completed. Block Work : 2nd Floor Completed.
Tower B – Slab Work: 7th Floor Slab Completed. Block Work: 3rd Floor Completed. Internal Plastering: Ground Floor In Progress.
Tower C – Slab Work : 8th Floor Slab Completed. Block Work : 4th Floor Completed. Internal Plastering : Ground Floor Completed & 1st & 2nd Floor in progress.
Tower D – Slab Work : 9th Floor Slab Completed. Block Work : 5th Floor Completed. Internal Plastering : 1st Floor completed, 2nd & 3rd Floor in Progress.
Tower E – Slab Work: 1st Floor Slab Completed.
Tower F- Slab Work: 3rd Floor Slab Completed.

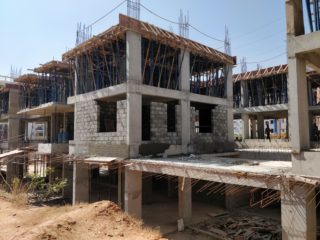

PROJECT PROGRESS REPORT AS ON 10th JULY 2019

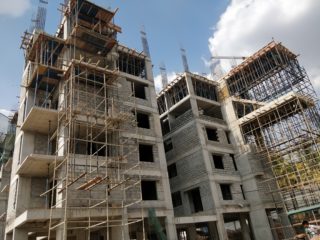

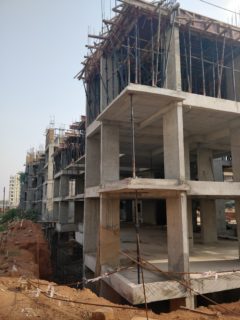

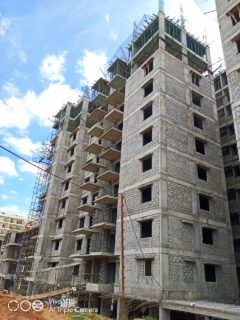

Tower A – Slab Work : 4th Floor Completed. Block Work : 1st Floor Completed.
Tower B – Slab Work : 6th Floor Slab Completed. Block Work : 2nd Floor Completed.
Tower C – Slab Work : 7th Floor Slab Completed. Block Work : 2nd Floor Completed. Internal Plastering : Ground & First Floor in progress.

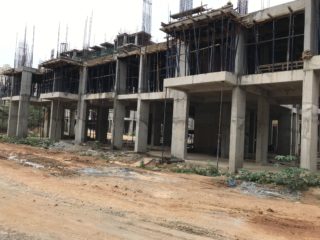

Tower D – Slab Work : 8th Floor Slab Completed. Block Work : 3rd Floor Completed. Internal Plastering : Ground & First Floor in progress.
Tower E – Slab Work : Ground Floor Slab Completed.
Tower F – Slab Work : 2nd Floor Slab Completed.

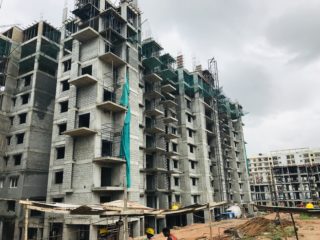

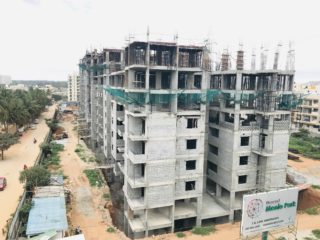

PROJECT PROGRESS REPORT AS ON 10th JUNE 2019

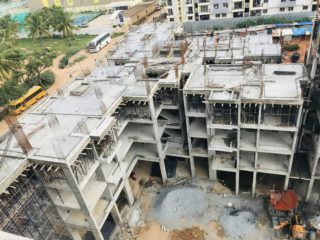

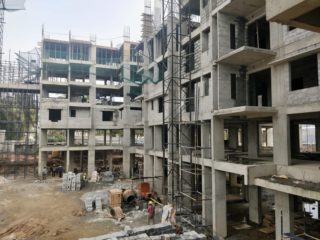

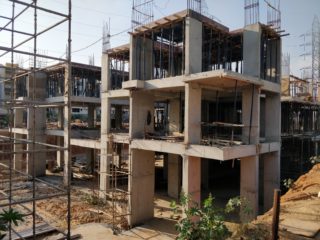

Tower A – Fourth Floor Slab Work in Progress, First Floor Block Work in Progress.
Tower B – Fifth Floor Slab Completed, First & Second Floor Block Work in Progress.
Tower C – Sixth Floor Slab Completed, Second & Third Floor Block Work in Progress.
Tower D – Seventh Floor Slab Work in Progress, Third & Fourth Floor Block Work in Progress.
Tower E – Ground Floor Slab Work in Progress.
Tower F – First Floor Slab Completed.

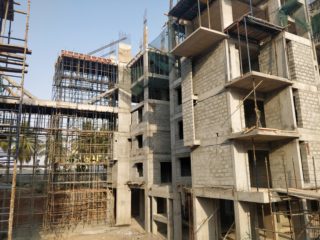

PROJECT PROGRESS REPORT AS ON 10th MAY 2019
Tower A –Third Floor Slab Completed
Tower B – Fourth Floor Slab Completed, Ground & First Floor Block Work in Progress
Tower C – Fifth Floor Slab Completed; Ground to Third Floor Block Work in Progress

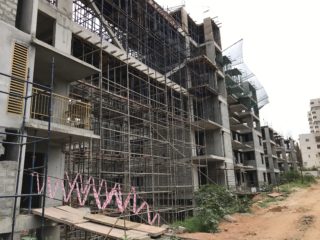

Tower D – Sixth Floor Slab Work in Progress; Ground to Third Floor Block Work in Progress
Tower F – Ground Floor Slab Completed

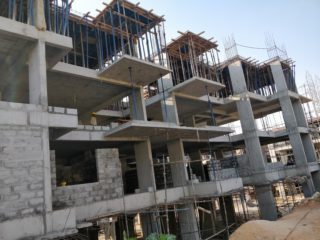

PROJECT PROGRESS REPORT AS ON 10th APRIL 2019
Tower A –Second Floor Slab Completed

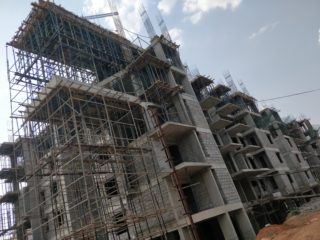

Tower B – Fourth Floor Column Work in Progress, Ground Floor Block Work in Progress
Tower C – Fifth Floor Column Work in Progress; Ground, First & Second Floor Block Work in Progress
Tower D – Fifth Floor Slab Completed; Ground, First & Second Floor Block Work in Progress
Tower F – Ground Floor Slab Work in Progress

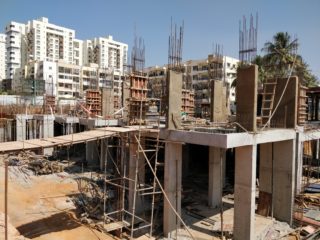

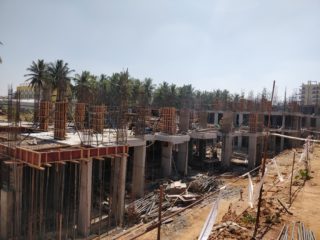

PROJECT PROGRESS REPORT AS ON 10th MARCH 2019
Tower A – First Floor Slab works in Progress
Tower B – Second Floor Slab Completed
Tower C – Third Floor Slab Completed; Ground & First floor Block Work in Progress
Tower D – Fourth Floor Slab Completed; Ground & First floor Block Work in Progress

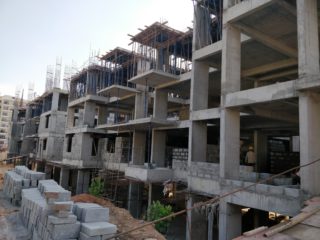

Tower F – Basement Column 2nd lift work in progress
PROJECT PROGRESS REPORT AS ON 10th FEBRUARY 2019
Tower A – Ground Floor Slab Completed
Tower B – First Floor Slab Completed
Tower C – Third Floor Slab work in progress
Tower D – Third Floor Slab work in progress & Ground Floor Block Work in Progress

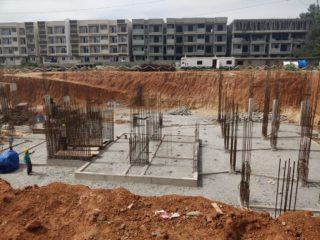

Tower E – Footing work in progress

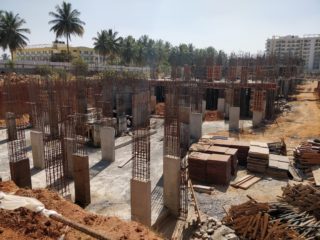

PROJECT PROGRESS REPORT AS ON 10th JANUARY 2019

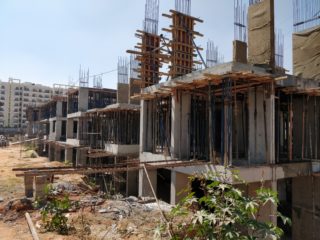

Tower A – Basement Floor Column work in progress
Tower B – Ground Floor Column work in progress
Tower C – First Floor Column work in progress
Tower D – Second Floor slab work in progress
Tower E – Footing work in progress.

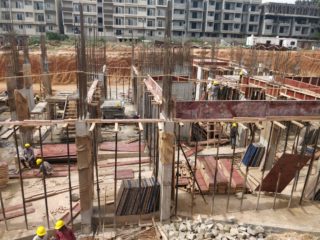

PROJECT PROGRESS REPORT AS ON 10th DECEMBER 2018
Tower A – Basement Soling work in progress
Tower B – Basement Column Concrete work in progress
Tower C – Ground floor Slab Completed
Tower D – First Floor slab Shuttering work in progress
PROJECT PROGRESS REPORT AS ON 10th NOVEMBER 2018
Tower A – Footing Concrete and Earth Refilling work completed.
Tower B – Footings completed, Plinth beam work in Progress

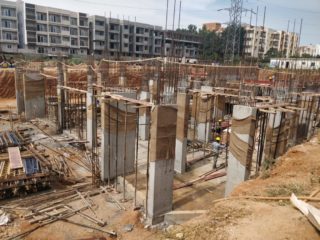

Tower C – Basement Column concrete work in progress
Tower D – Ground Floor slab work in progress

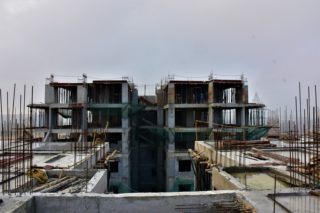

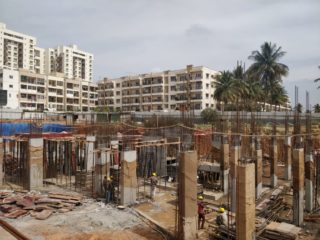

PROJECT PROGRESS REPORT AS ON 10th OCTOBER 2018
Tower A – Footings in Progress
Tower B – Footings Completed
Tower C – Footings, Tie beam Completed & Soling is in progress
Tower D – Basement Column Casting is in progress

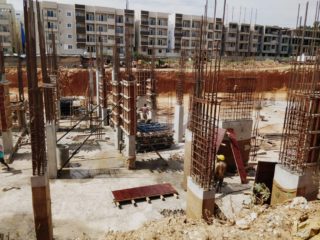

PROJECT PROGRESS REPORT AS ON 7th SEPTEMBER 2018
Tower D – Footings & Tie Beam Completed
Tower C – Footings Completed & Tie Beam is in progress
Tower B – Excavation Completed & PCC is in progress
Tower A – Excavation is in progress

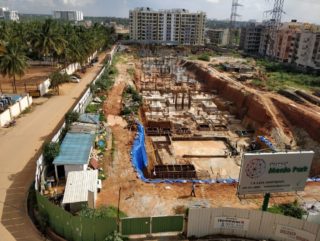

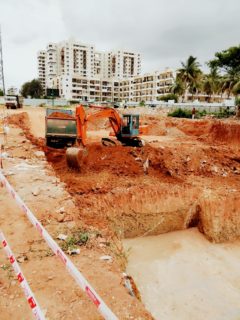

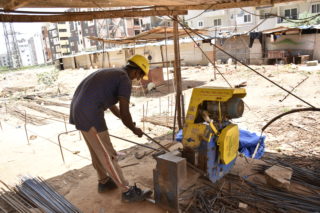

PROJECT PROGRESS REPORT AS ON 7th July 2018
Tower D: Excavation has been completed and footing work is under progress.
Tower C: Excavation works in progress
