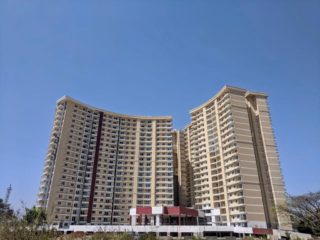

Vaswani Exquisite – A piece of sky, in the palm of your hand
This is what life at the top looks like. The morning sun streams into your bedroom. Brunch by the lake, right on your balcony. Swathes of green, as far as the eye can see. Clouds in your coffee. You got to the top by sheer dint of your hard work. Now, set your standards sky-high for the home you deserve.
Vaswani Exquisite is your place in the sky. It’s your answer to living right in the middle of the city’s action but elevated above it all. It’s Zen in an apartment!
Vaswani Exquisite: Live life sky high

With elegant 4 towers rising into the sky in a graceful arc, living in Vaswani Exquisite is like being in seventh heaven.
Thoughtfully designed 3 & 4-bedroom homes ranging from 1815 to 2860 square feet. Come take a look at the finer details, the spectacular views from the apartments, the airy interiors, the extra high ceilings, imported marble, and much more.
When you live in Vaswani Exquisite, unmatched luxury meets uncompromising connectivity. Located on ITPL Main Road in Whitefield, these spectacular apartments offer world-class amenities for an ultra-fine living experience with proximity to the best schools, hospitals, metro stations, shopping malls and offices all within a 5-minute walking distance

Vaswani HomeworX – The New Age Clubhouse.
Quiet spaces in your apartment complex clubhouse that are conducive to work. Away from the clatter of cutlery or the screams of squabbling siblings. You can choose to work all day from home, or just take the odd conference call, without any of the familiar interruptions that technology or people can bring!
And who says only adults need quiet time? If your children want some peace and quiet to get their homework done or to get some tuition, they can pop into our learning pods
Vaswani HomeworX will make your life better in so many ways, but here are the top three:
Enjoy the luxury of uninterrupted modern workspaces from the convenience of your very own community with Vaswani HomeworX
Private Corner Office At Home
Homes with a private workspace that perfectly suit the new trend of ‘Work from Home’. Our spacious 3.5 & 4 Bedroom Apartments with a dedicated workspace provide just that.
Quiet space in your very home that is conducive to work without any familiar interruptions that technology or people can bring! Our standards are sky-high. To match your expectations.

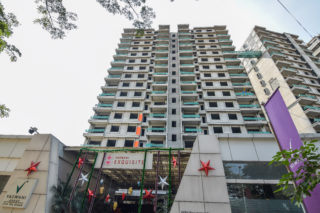

Location – Next to Hotel Zuri, ITPL Main Road, Whitefield- Bangalore.
RERA Registration No. PRM/KA/RERA/1251/446/PR/171015/000784
Limited units are available.
*conditions apply

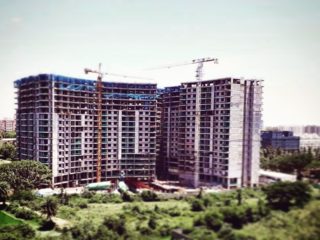

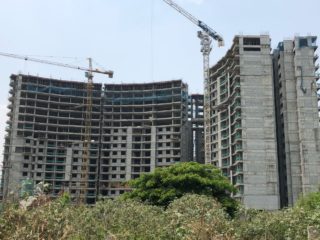

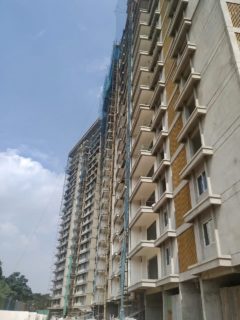

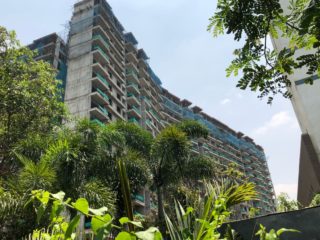

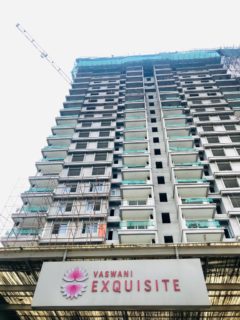

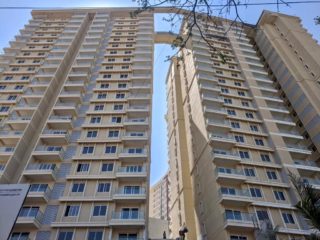

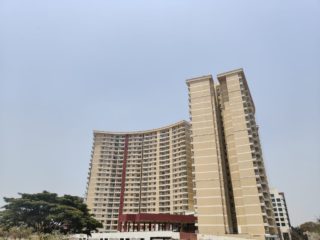

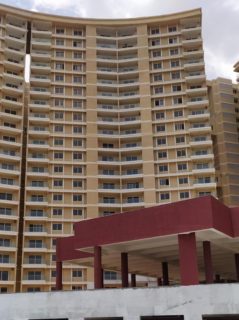

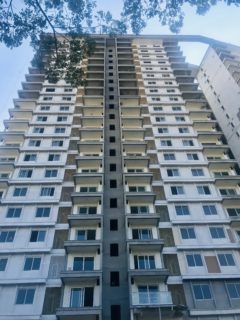

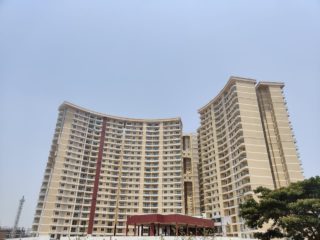

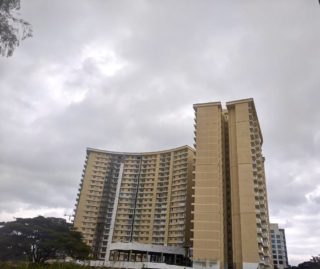

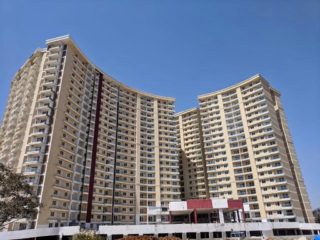

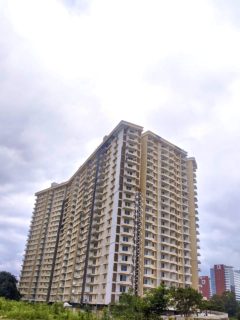

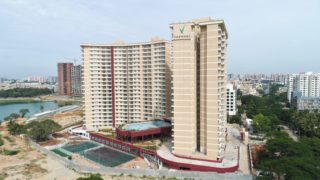

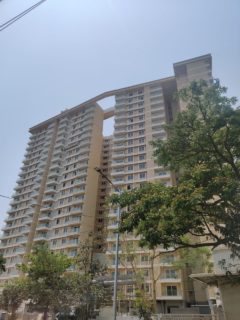

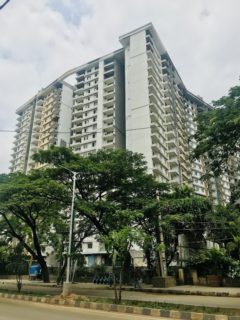

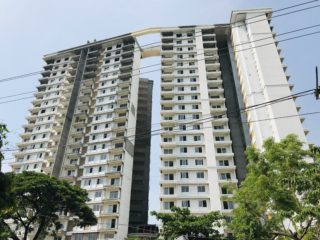

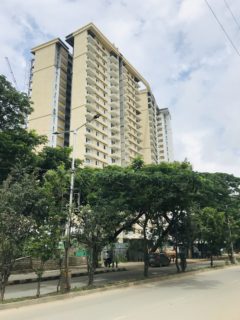

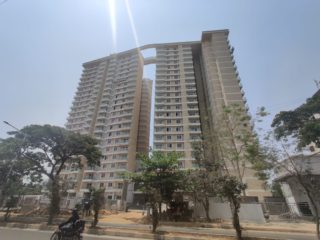

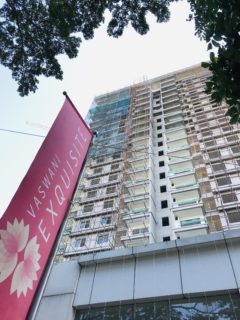

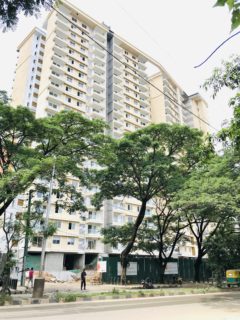

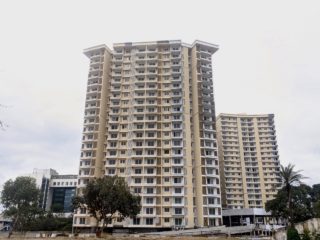

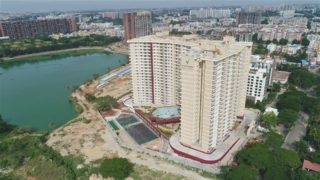

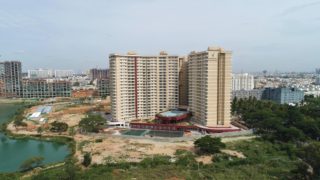

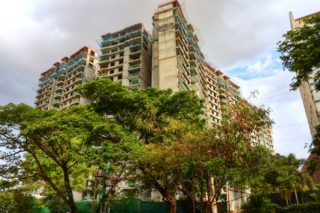

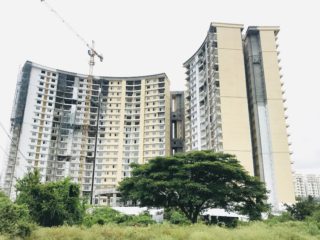

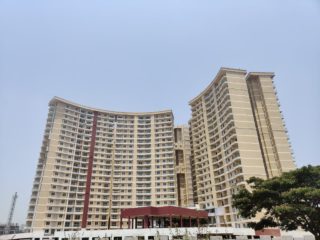

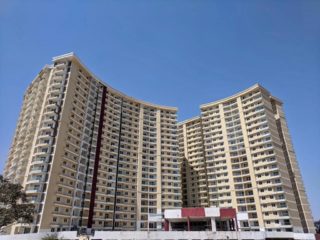

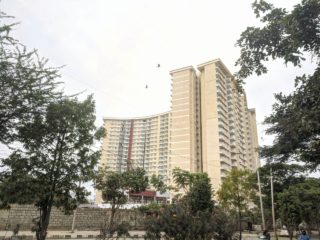

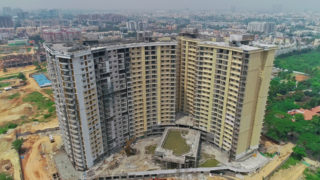

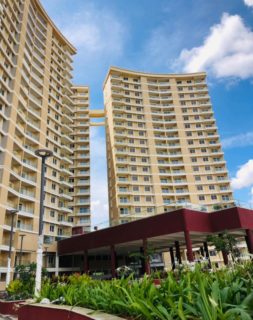

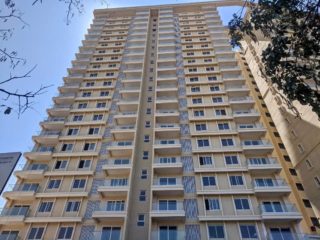

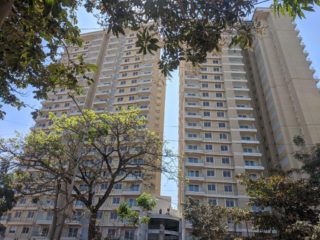

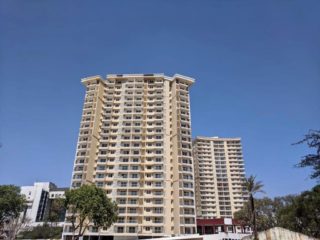

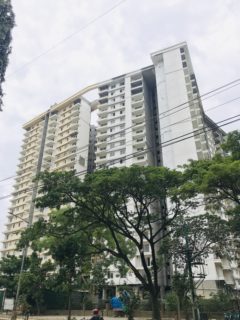

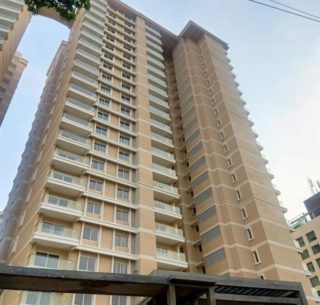

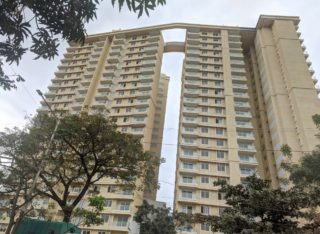

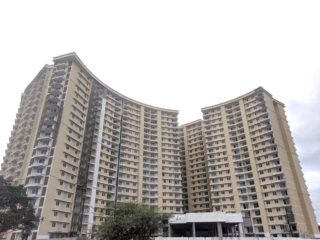

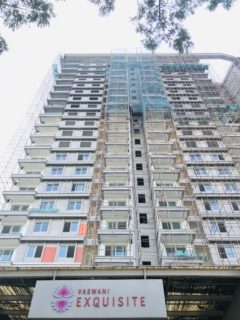

The Project is nearing completion.
You can watch the project video you YouTube Link below

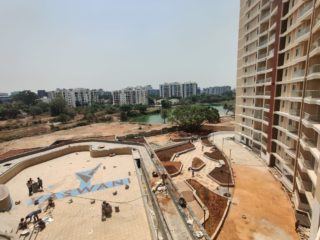

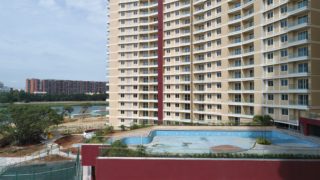

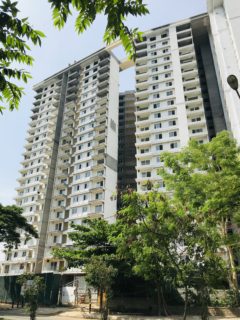

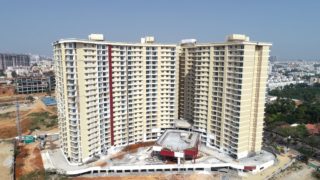

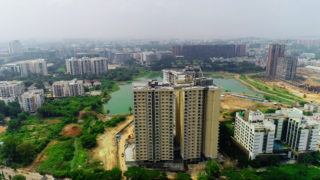

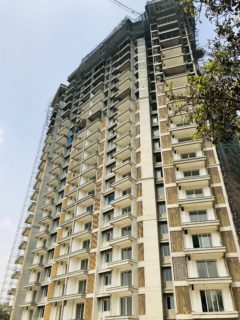

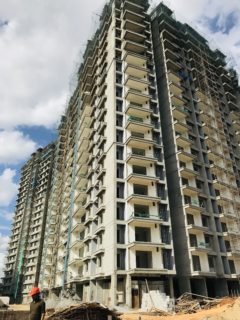

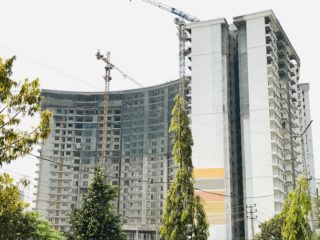

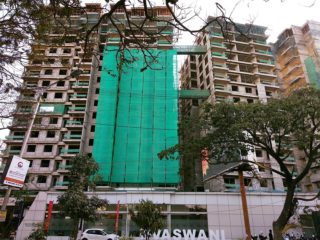

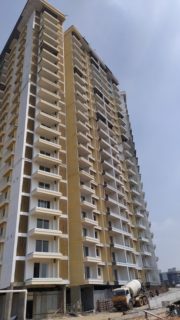

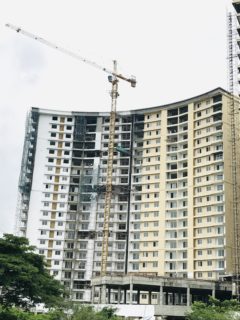

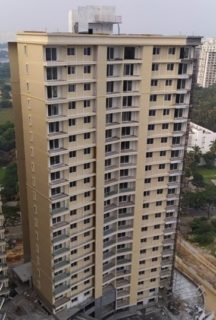

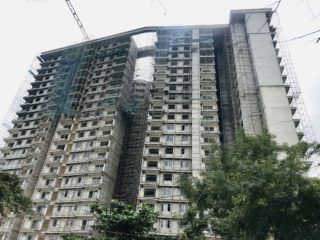

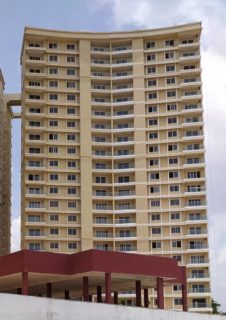

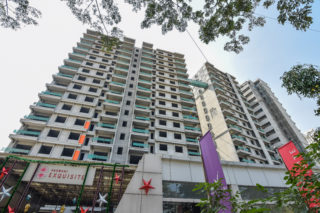

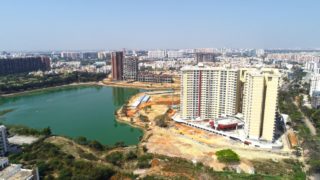

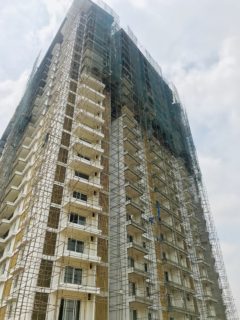

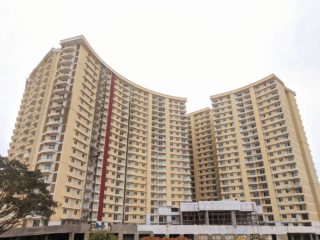

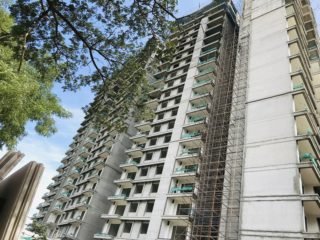

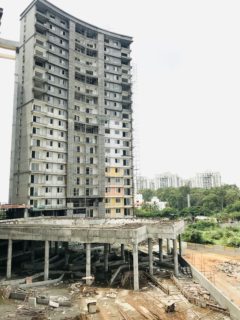

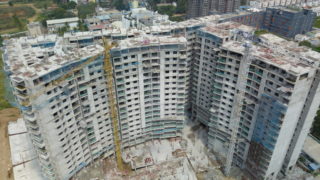

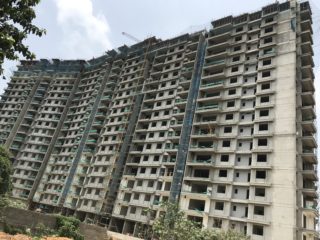

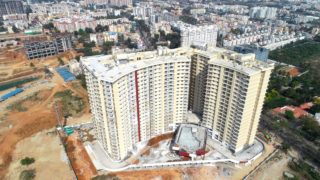

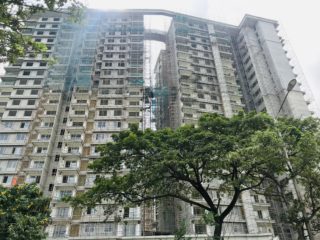

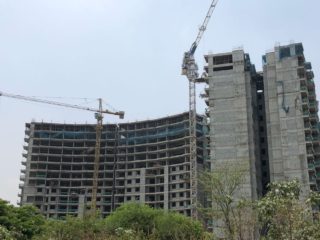

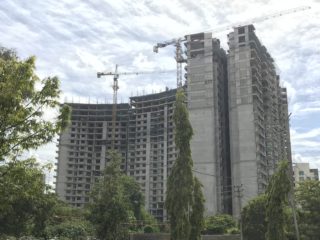

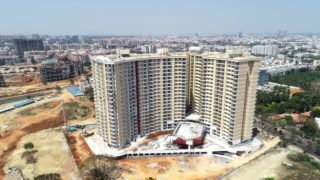

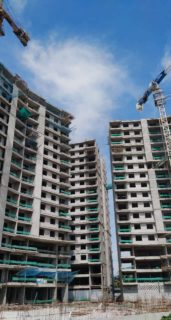

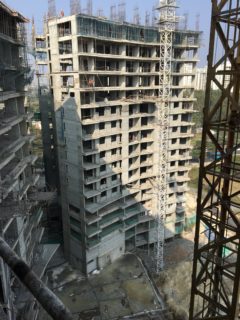

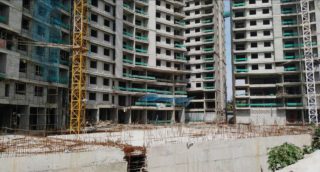

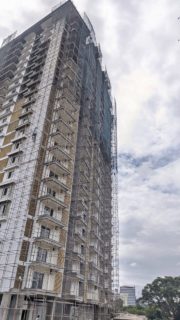

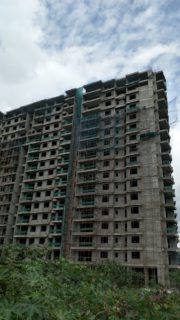

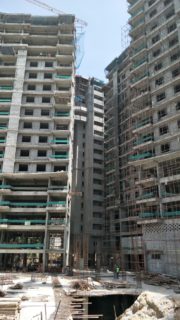

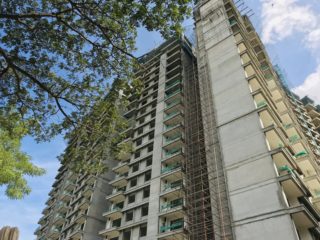

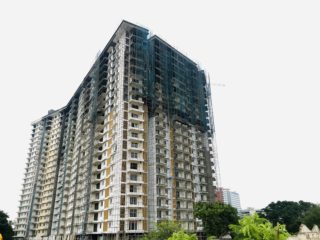

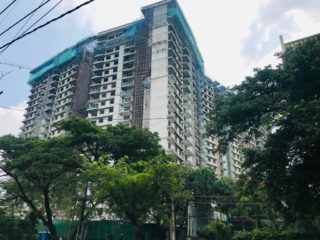

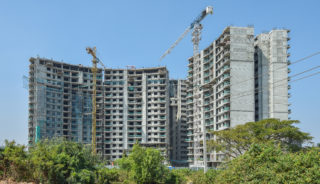

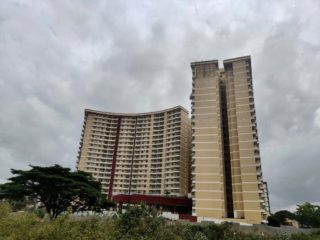

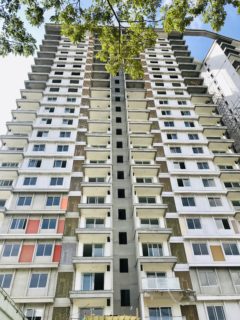

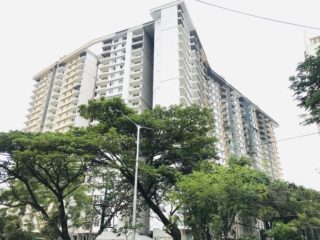

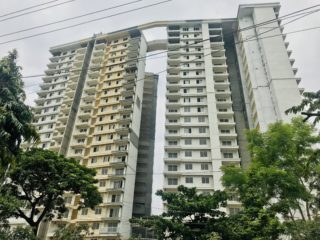

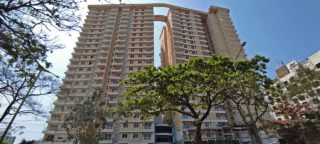

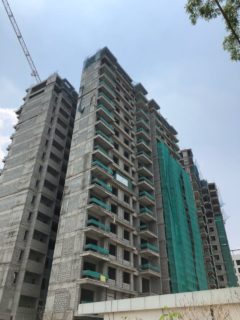

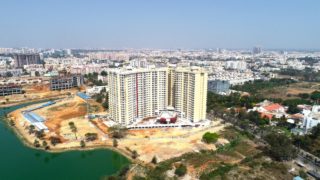

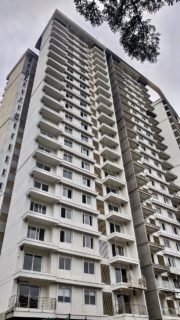

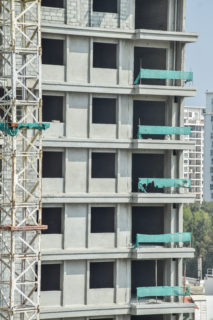

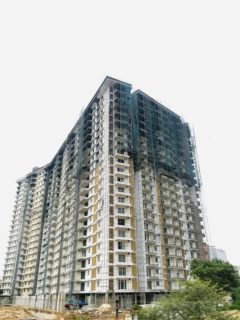

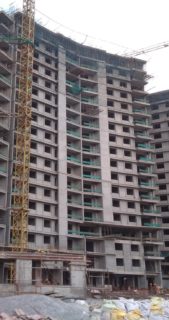

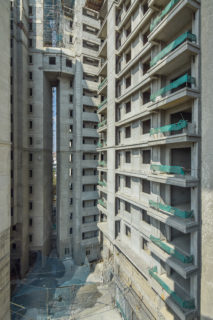

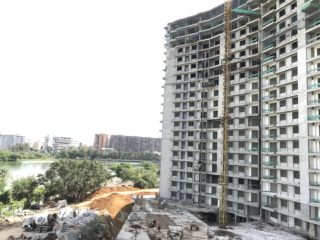

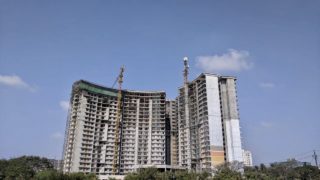

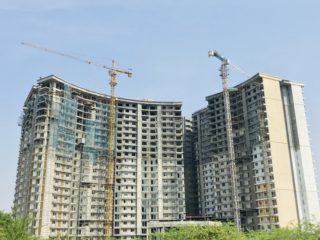

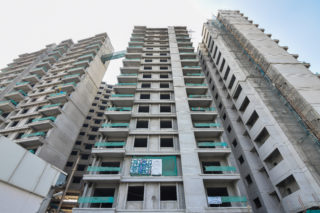

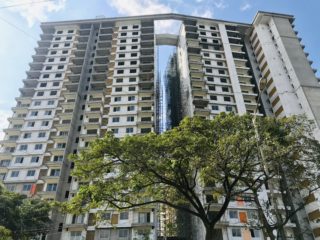

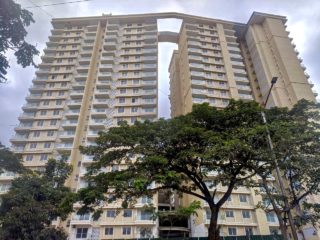

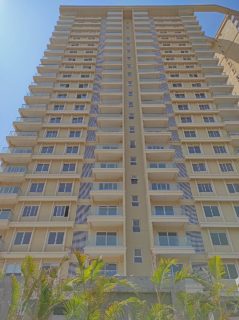

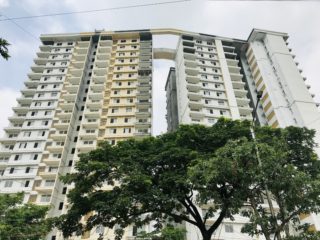

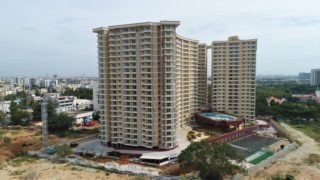

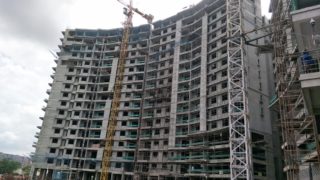

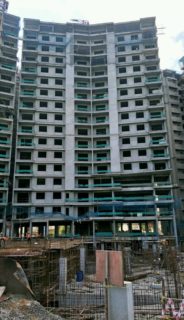

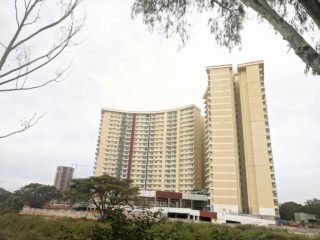

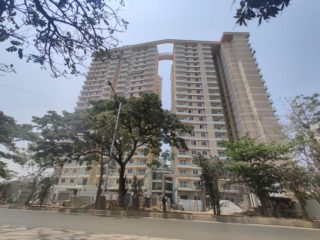

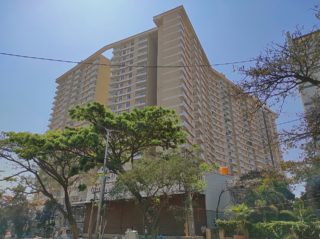

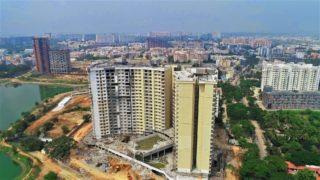

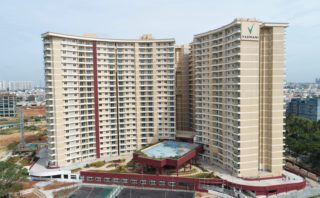

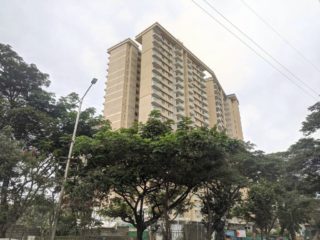

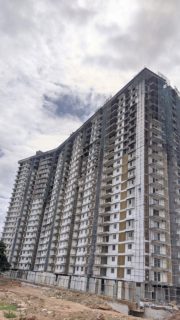

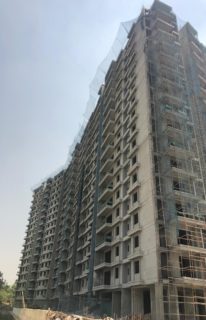

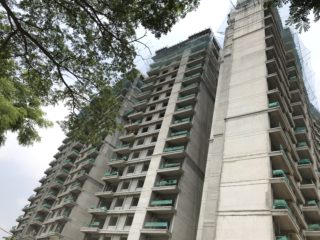

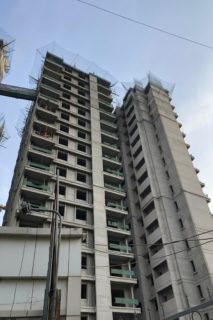

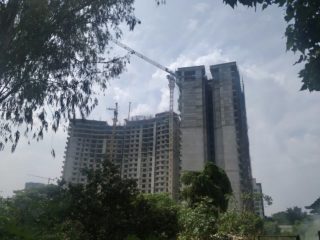

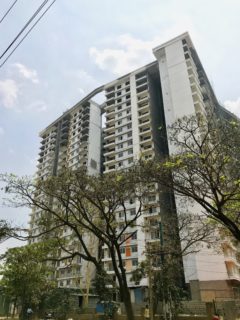

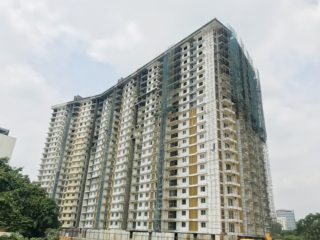

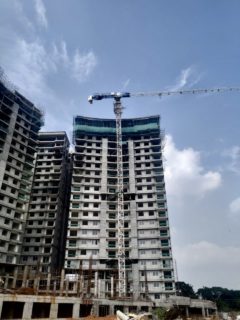

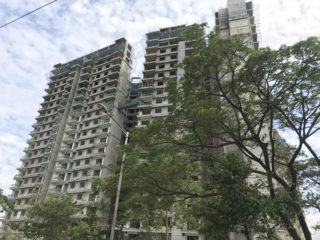

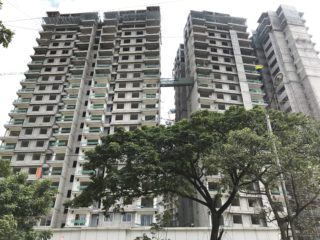

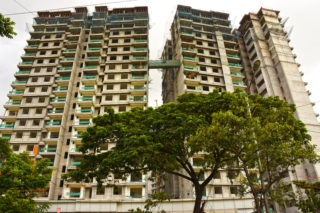

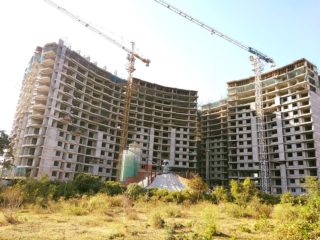

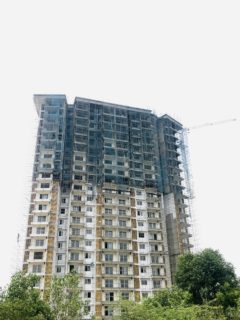

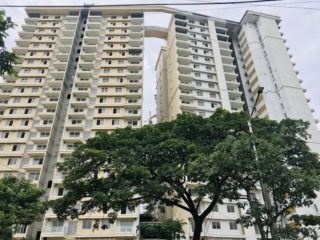

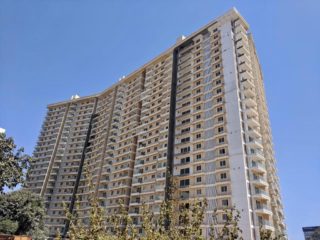

PROJECT PROGRESS REPORT AS ON 10th JULY 2021
What has been completed and is currently in Progress:

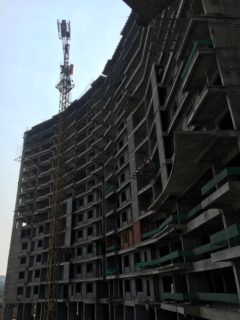

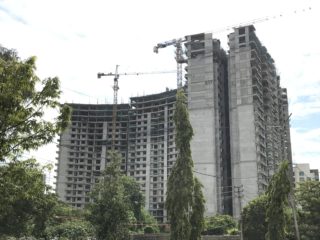

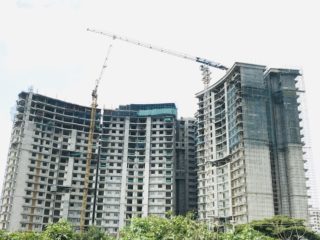

Tower A: All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing: Completed. Sanitary & CP Fixtures : 95% Completed. External Painting: Completed. Wooden Flooring : 95% Completed.

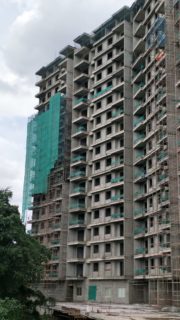

Tower B : All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing : Completed. Sanitary & CP Fixtures : Completed. External Painting: Completed. Wooden Flooring : Completed.

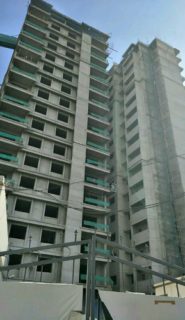

Tower C : All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing : Completed. Sanitary & CP Fixtures : Completed. External Painting: Completed. Wooden Flooring : 50% Completed.

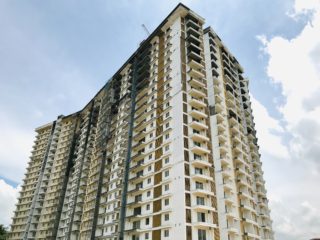

Tower D: All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing : Completed. Sanitary & CP Fixtures :65% Completed. External Painting: Completed. Wooden Flooring : 35% Completed.
Club House: Slab Work : completed. Block Work : completed. Internal Plastering work : Completed. MEP Work : completed. Tiling Work: Completed. Painting: Final Coat 90% completed.
Swimming Pool: Slab Work : completed. External Plastering work : Completed. Waterproofing Works: completed. MEP Work : Completed. Tiling Work: completed. Deck Flooring: Completed.

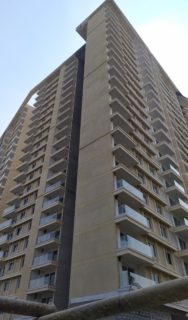

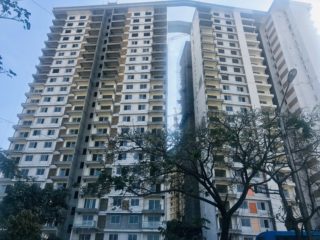

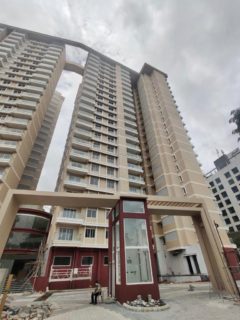

PROJECT PROGRESS REPORT AS ON 10th JUNE 2021
What has been completed and is currently in Progress:
Tower A: All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing: Completed. Sanitary & CP Fixtures : 95% Completed. External Painting: 95% Completed. Wooden Flooring : 80% Completed.
Tower B : All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing : Completed. Sanitary & CP Fixtures : Completed. External Painting: 95% Completed. Wooden Flooring : 70% Completed.
Tower C : All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing : Completed. Sanitary & CP Fixtures : 15% Completed. External Painting: 95% Completed. Wooden Flooring : Yet to Start.
Tower D: All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing : 90% Completed. Sanitary & CP Fixtures : Yet to Start. External Painting: 75% Completed. Wooden Flooring : Yet to Start.
Club House: Slab Work : completed. Block Work : completed. Internal Plastering work : Completed. MEP Work : completed. Tiling Work: Completed.
Swimming Pool: Slab Work : completed. External Plastering work : Completed. Waterproofing Works: completed. MEP Work : Completed. Tiling Work: completed.

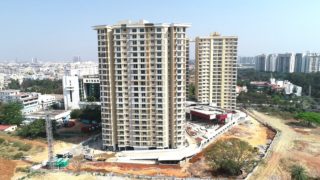

PROJECT PROGRESS REPORT AS ON 10th MAY 2021
What has been completed and is currently in Progress:
Tower A: All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing: Completed. Sanitary & CP Fixtures : 95% Completed. External Painting: 95% Completed.
Tower B : All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing : Completed. Sanitary & CP Fixtures : Completed. External Painting: 95% Completed.
Tower C : All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing : Completed. Sanitary & CP Fixtures : 15% Completed. External Painting: 95% Completed.
Tower D: All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing : 90% Completed. Sanitary & CP Fixtures : Yet to Start. External Painting: 75% Completed.
Club House: Slab Work : completed. Block Work : completed. Internal Plastering work : Completed. MEP Work : completed. Tiling Work: 97% Completed.
Swimming Pool: Slab Work : completed. External Plastering work : Completed. Waterproofing Works: completed. MEP Work : Completed. Tiling Work: completed.

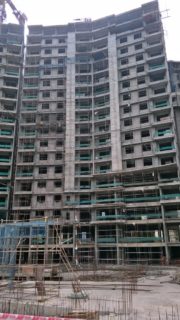

PROJECT PROGRESS REPORT AS ON 10th APRIL 2021
What has been completed and is currently in Progress:
Tower A: All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing: Completed. Sanitary & CP Fixtures : 95% Completed.
Tower B : All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing : Completed. Sanitary & CP Fixtures : Completed.
Tower C : All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing : Completed. Sanitary & CP Fixtures : 15% Completed.
Tower D: All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing : 90% Completed. Sanitary & CP Fixtures : Yet to Start.
Club House: Slab Work : completed. Block Work : completed. Internal Plastering work : Completed. MEP Work : completed. Tiling Work: 97% Completed.
Swimming Pool: Slab Work : completed. External Plastering work : Completed. Waterproofing Works: completed. MEP Work : Completed. Tiling Work: in Progress.
PROJECT PROGRESS REPORT AS ON 10th MARCH 2021
What has been completed and is currently in Progress:
Tower A: All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing : 95% Completed. Sanitary & CP Fixtures : 60% Completed.
Tower B : All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing : 95% Completed. Sanitary & CP Fixtures : 60% Completed.
Tower C : All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing : 95% Completed. Sanitary & CP Fixtures : Yet to Start.
Tower D: All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed. Marble Polishing : 65% Completed. Sanitary & CP Fixtures : Yet to Start.
Club House: Slab Work : completed. Block Work : completed. Internal Plastering work : Completed. MEP Work : completed.
Swimming Pool: Slab Work : completed. External Plastering work : Completed. Waterproofing Works: completed. MEP Work : Completed.
PROJECT PROGRESS REPORT AS ON 10th FEBRUARY 2021
What has been completed and is currently in Progress:
Tower A: All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed.
Tower B : All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed.
Tower C : All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed.
Tower D: All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed.
Club House: Slab Work : completed. Block Work : completed. Internal Plastering work : Completed. MEP Work : completed.
Swimming Pool: Slab Work : completed. External Plastering work : Completed. Waterproofing Works: completed. MEP Work : in Progress.

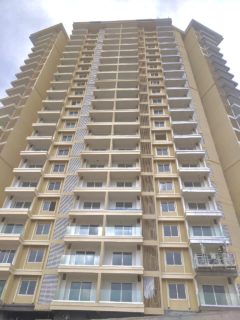

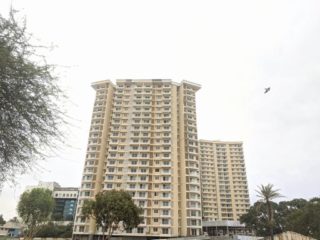

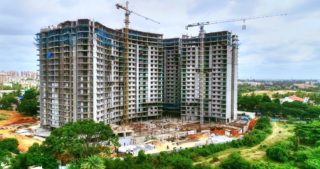

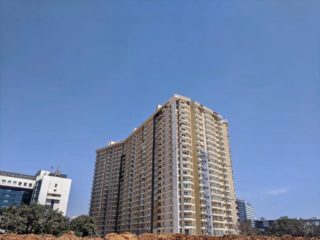

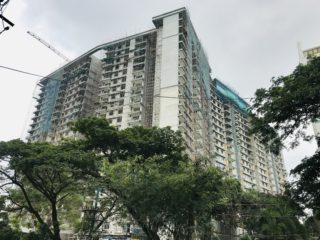

PROJECT PROGRESS REPORT AS ON 10th JANUARY 2021
What has been completed and is currently in Progress:
Tower A: All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed.
Tower B : All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed.
Tower C : All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed.
Tower D: All Civil Works : Completed. MEP Work : Completed. Tiling & Dado : Completed. Marble Work: Completed. Elevators : Installation Completed.
Club House: Slab Work : completed. Block Work : completed. Internal Plastering work : Completed. MEP Work : completed.

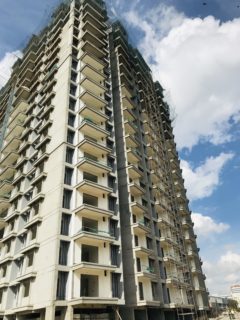

PROJECT PROGRESS REPORT AS ON 10th DECEMBER 2020
What has been completed and is currently in Progress:
Tower A: Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : Completed. Tiling & Dado : Completed.
Tower B : Slab Work : Completed. Block Work : Completed. Internal Plastering work : Completed. MEP Work : Completed. Tiling & Dado : Completed.
Tower C : Slab Work : Completed. Block Work : Completed. Internal Plastering work : Completed. MEP Work : Completed. Tiling & Dado : Completed.
Tower D: Slab Work : completed. Block Work : completed. Internal Plastering work : Completed. MEP Work : completed. Tiling & Dado : Completed.
Club House: Slab Work : completed. Block Work : completed. Internal Plastering work : 90% Completed. MEP Work : completed.
PROJECT PROGRESS REPORT AS ON 10th NOVEMBER 2020
What has been completed and is currently in Progress:
Tower A: Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : Completed. Tiling & Dado : Completed.
Tower B : Slab Work : Completed. Block Work : Completed. Internal Plastering work : Completed. MEP Work : Completed. Tiling & Dado : Completed.
Tower C : Slab Work : Completed. Block Work : Completed. Internal Plastering work : Completed. MEP Work : Completed. Tiling & Dado : Completed.
Tower D: Slab Work : completed. Block Work : completed. Internal Plastering work : Completed. MEP Work : completed. Tiling & Dado : Completed.

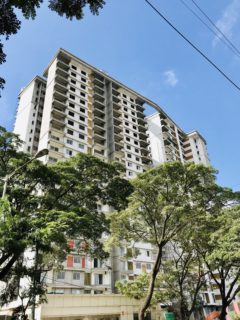

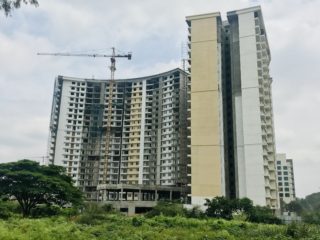

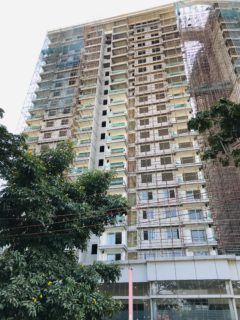

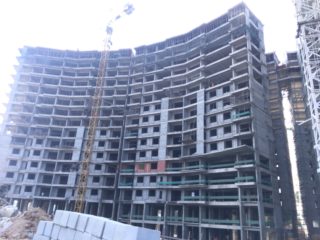

PROJECT PROGRESS REPORT AS ON 10th OCTOBER 2020
What has been completed and is currently in Progress:
Tower A: Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : Completed. Tiling & Dado : Completed.
Tower B : Slab Work : Completed. Block Work : Completed. Internal Plastering work : Completed. MEP Work : Completed. Tiling & Dado : Completed.
Tower C : Slab Work : Completed. Block Work : Completed. Internal Plastering work : Completed. MEP Work : Completed. Tiling & Dado : 21st Floor in progress.
Tower D: Slab Work : completed. Block Work : completed. Internal Plastering work : Completed. MEP Work : 20th Floor completed. Tiling & Dado : 19th Floor completed.

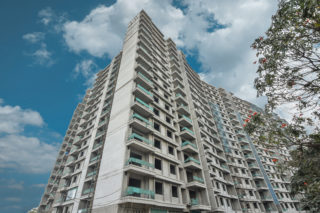

PROJECT PROGRESS REPORT AS ON 10th SEPTEMBER 2020
What has been completed and is currently in Progress:
Tower A: Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : Completed. Tiling & Dado : Completed.
Tower B : Slab Work : Completed. Block Work : Completed. Internal Plastering work : Completed. MEP Work : Completed. Tiling & Dado : Completed.
Tower C : Slab Work : Completed. Block Work : Completed. Internal Plastering work : Completed. MEP Work : Completed. Tiling & Dado : 20th Floor in progress.
Tower D: Slab Work : completed. Block Work : completed. Internal Plastering work : Completed. MEP Work : 20th Floor completed. Tiling & Dado : 17th Floor completed.

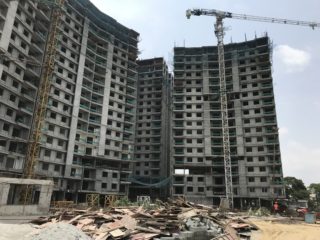

PROJECT PROGRESS REPORT AS ON 10th AUGUST 2020
What has been completed and is currently in Progress:
Tower A: Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : Completed. Tiling & Dado : Completed.
Tower B : Slab Work : Completed. Block Work : Completed. Internal Plastering work : Completed. MEP Work : Completed. Tiling & Dado : Completed.
Tower C : Slab Work : Completed. Block Work : Completed. Internal Plastering work : Completed. MEP Work : Completed. Tiling & Dado : 20th Floor in progress.
Tower D: Slab Work : completed. Block Work : completed. Internal Plastering work : Completed. MEP Work : 20th Floor completed. Tiling & Dado : 16th Floor completed.

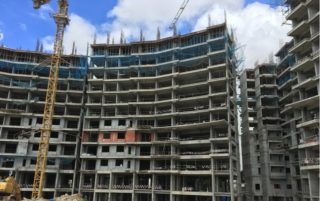

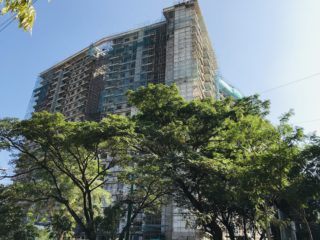

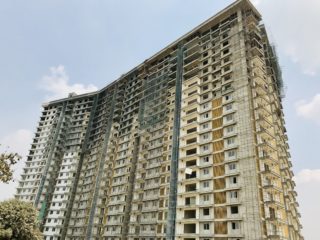

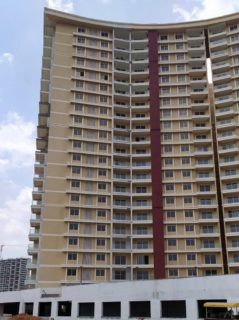

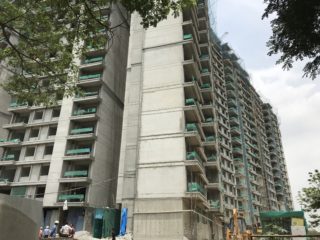

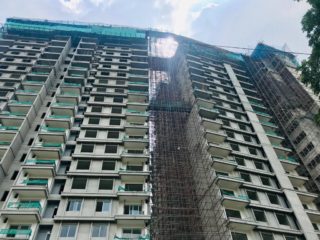

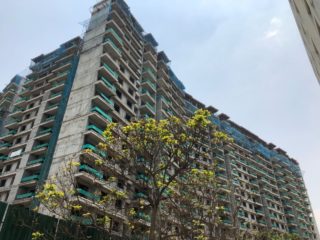

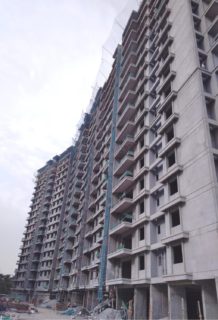

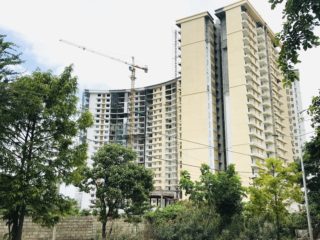

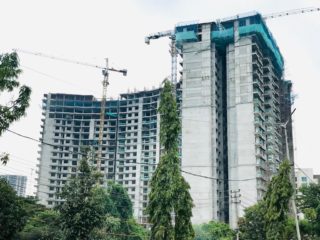

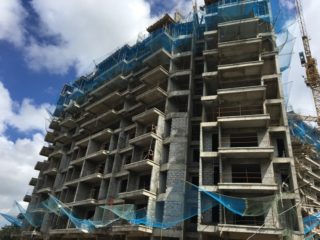

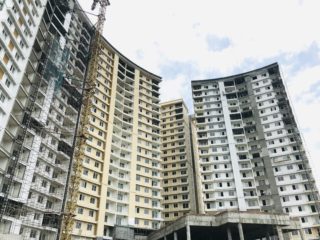

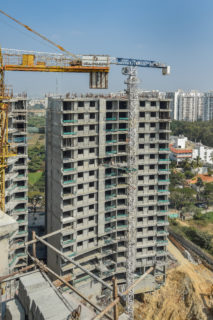

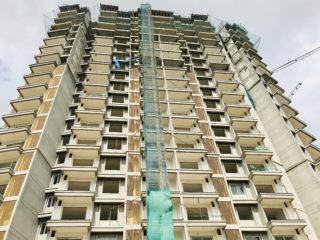

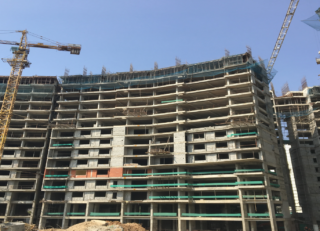

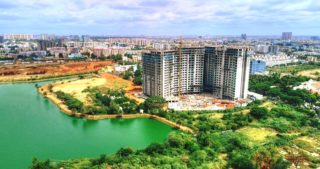

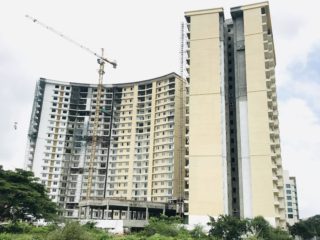

PROJECT PROGRESS REPORT AS ON 10th JULY 2020
What has been completed and is currently in Progress:
Tower A: Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : Completed. Tiling & Dado : Completed.
Tower B : Slab Work : Completed. Block Work : Completed. Internal Plastering work : Completed. MEP Work : Completed. Tiling & Dado : 20th Floor Completed.
Tower C : Slab Work : Completed. Block Work : Completed. Internal Plastering work : Completed. MEP Work : Completed. Tiling & Dado : 20th Floor in progress.
Tower D: Slab Work : completed. Block Work : completed. Internal Plastering work : Completed. MEP Work : 20th Floor completed. Tiling & Dado : 16th Floor completed.

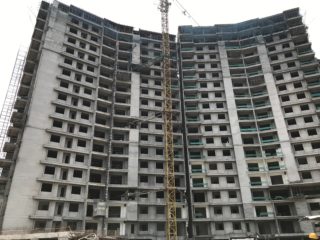

PROJECT PROGRESS REPORT AS ON 10th JUNE 2020
What has been completed and is currently in Progress:
Tower A: Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : Completed. Tiling & Dado : Completed.
Tower B : Slab Work : Completed. Block Work : Completed. Internal Plastering work : Completed. MEP Work : Completed. Tiling & Dado : 19th Floor Completed.
Tower C : Slab Work : Completed. Block Work : Completed. Internal Plastering work : Completed. MEP Work : Completed. Tiling & Dado : 19th Floor completed.
Tower D: Slab Work : completed. Block Work : completed. Internal Plastering work : 20th Floor Completed. MEP Work : 20th Floor completed. Tiling & Dado : 15th Floor completed.

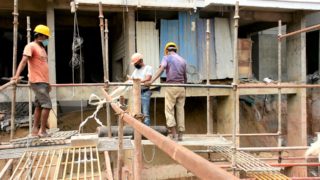

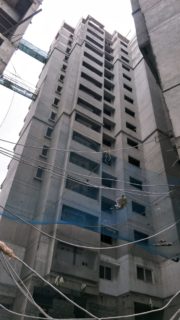

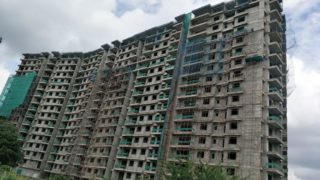

We are happy to share that we are back to work and our construction sites are active as well (since April 27th). As there are nearly 450 workers on site, we are leaving no stone unturned for safety within the premises. As responsible citizens, wearing a mask, regular hand sanitization, thermal screening, maintaining physical distance, etc. are the stringent protocols that are being followed across our sites and offices

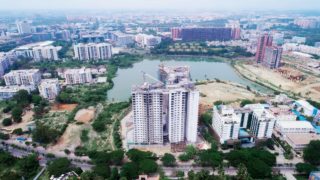

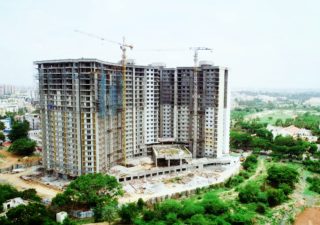

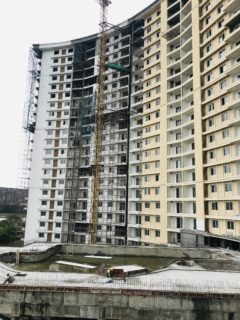

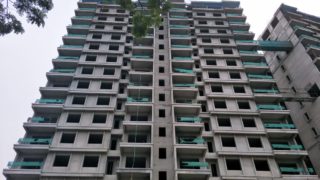

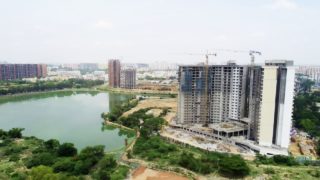

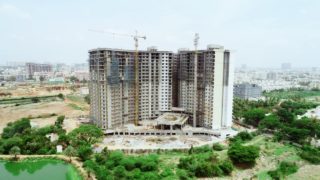

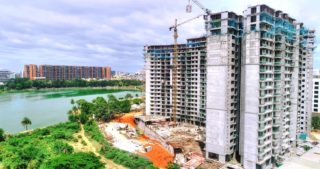

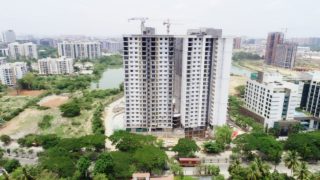

PROJECT PROGRESS REPORT AS ON 10th MAY 2020
What has been completed and is currently in Progress:
Tower A: Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : Completed. Tiling & Dado : Completed.
Tower B : Slab Work : Completed. Block Work : Completed. Internal Plastering work : Completed. MEP Work : Completed. Tiling & Dado : 19th Floor Completed.
Tower C : Slab Work : Completed. Block Work : Completed. Internal Plastering work : Completed. MEP Work : Completed. Tiling & Dado : 19th Floor completed.
Tower D: Slab Work : completed. Block Work : 19th Floor completed. Internal Plastering work : 18th Floor Completed. MEP Work : 19th Floor completed. Tiling & Dado : 15th Floor completed.

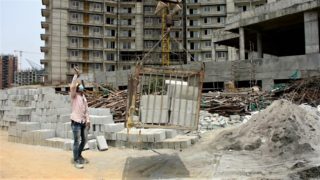

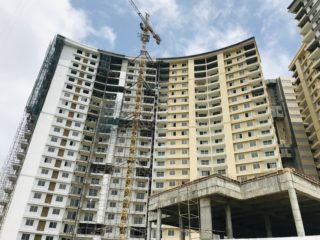

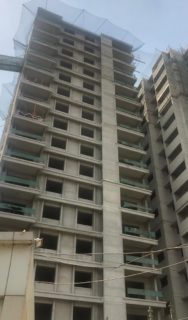

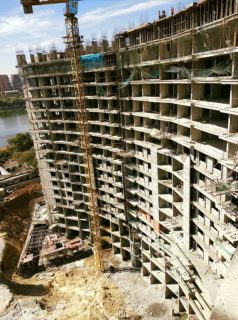

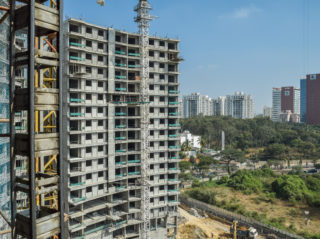

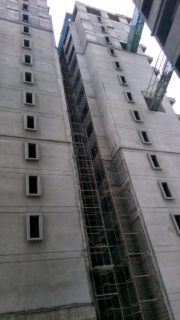

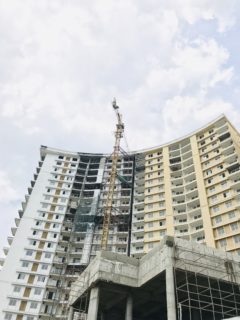

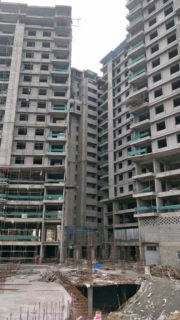

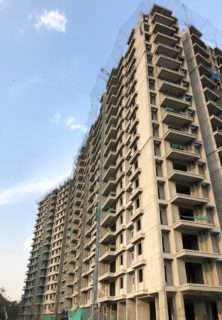

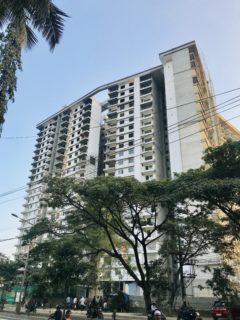

PROJECT PROGRESS REPORT AS ON 10th MARCH 2020
What has been completed and is currently in Progress:
Tower A: Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : Completed. Tiling & Dado : 20th Floor Completed.
Tower B : Slab Work : Completed. Block Work : Completed. Internal Plastering work : Completed. MEP Work : Completed. Tiling & Dado : 19th Floor Completed.
Tower C : Slab Work : Completed. Block Work : Completed. Internal Plastering work : Completed. MEP Work : 19th Floor Completed. Tiling & Dado : 19th Floor completed.
Tower D: Slab Work : completed. Block Work : 19th Floor completed. Internal Plastering work : 17th Floor Completed. MEP Work : 16th Floor completed. Tiling & Dado : 15th Floor completed.

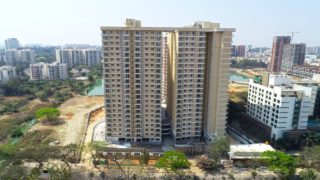

PROJECT PROGRESS REPORT AS ON 10th FEBRUARY 2020
What has been completed and is currently in Progress:
Tower A: Slab Work : Completed. Block Work : Completed. Internal Plastering : Completed. MEP Work : 18th Floor Completed. Tiling & Dado : 18th Floor Completed.
Tower B : Slab Work : Completed. Block Work : Completed. Internal Plastering work : Completed. MEP Work : 18th Floor Completed. Tiling & Dado : 17th Floor Completed.
Tower C : Slab Work : Terrace Slab Completed. Block Work : 19th Floor Completed. Internal Plastering work : 19th Floor Completed. MEP Work : 18th Floor Completed. Tiling & Dado : 18th Floor completed.
Tower D: Slab Work : Terrace Slab completed. Block Work : 18th Floor completed. Internal Plastering work : 16th Floor Completed. MEP Work : 16th Floor completed. Tiling & Dado : 14th Floor completed.

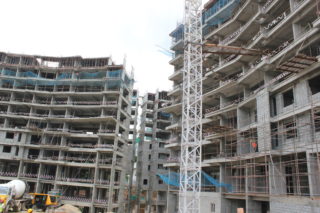

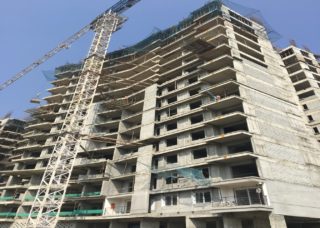

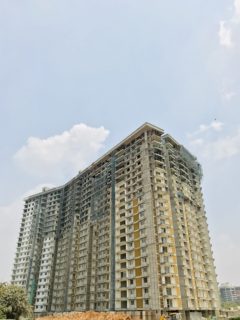

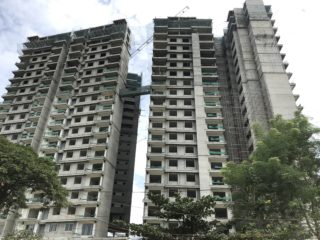

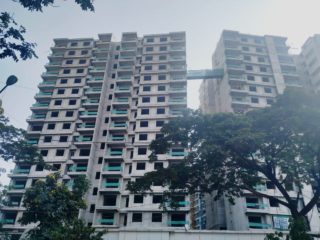

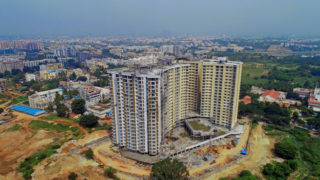

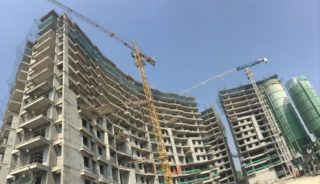

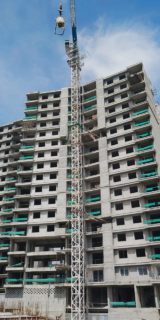

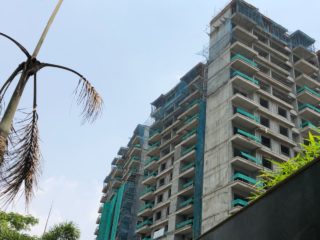

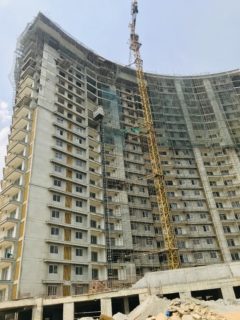

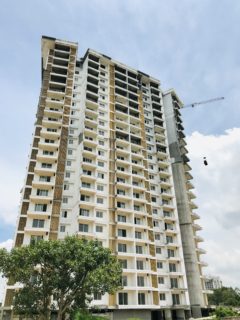

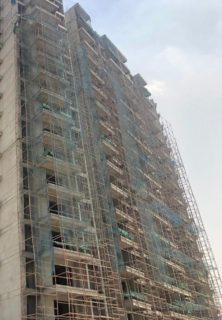

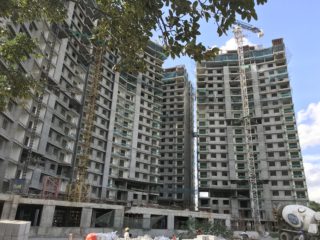

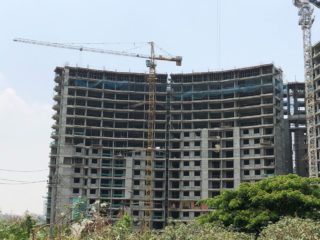

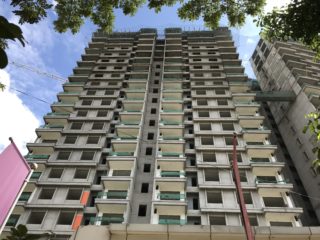

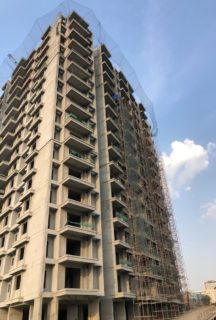

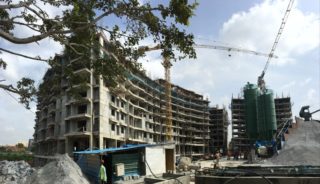

PROJECT PROGRESS REPORT AS ON 10th JANUARY 2020
What has been completed and is currently in Progress:
Tower A: Slab Work : Parapet work Completed. Block Work : 21st Floor Completed. Internal Plastering : 19th Floor Completed. MEP Work : 17th Floor Completed. Tiling & Dado : 16th Floor Completed.
Tower B : Slab Work : Parapet work Completed. Block Work : 21st Floor Completed. Internal Plastering work : 19th Floor Completed. MEP Work : 17th Floor Completed. Tiling & Dado : 15th Floor Completed.
Tower C : Slab Work : Terrace Slab Completed. Block Work : 19th Floor Completed. Internal Plastering work : 19th Floor Completed. MEP Work : 17th Floor Completed. Tiling & Dado : 15th Floor completed.
Tower D: Slab Work : Terrace Slab in Progress. Block Work : 17th Floor completed. Internal Plastering work : 16th Floor Completed. MEP Work : 15th Floor completed. Tiling & Dado : 13th Floor completed.

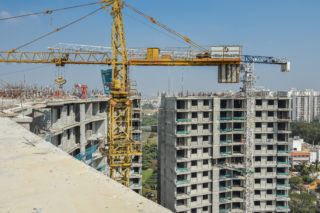

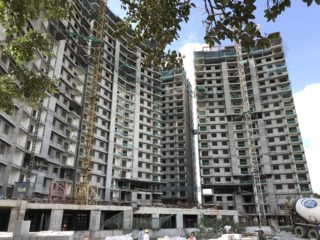

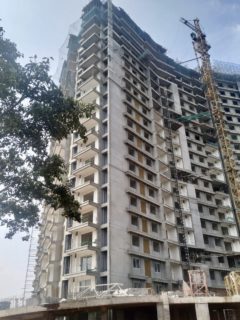

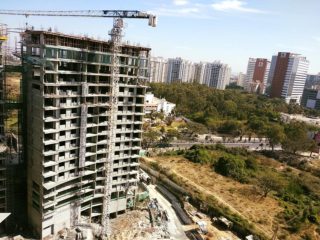

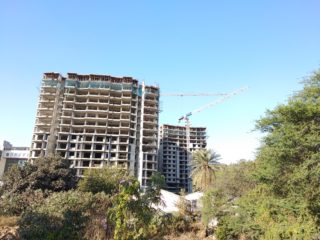

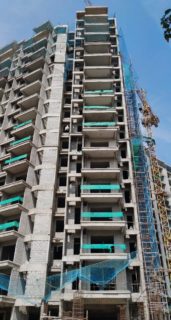

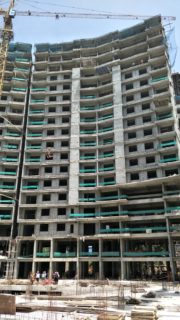

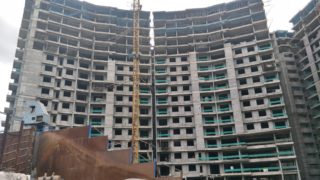

PROJECT PROGRESS REPORT AS ON 10th DECEMBER 2019
What has been completed and is currently in Progress:
Tower A: Slab Work : Parapet work Completed. Block Work : 20th Floor Completed. Internal Plastering : 18th Floor Completed. MEP Work : 16th Floor Completed. Tiling & Dado : 15th Floor Completed.
Tower B : Slab Work : Parapet work Completed. Block Work : 20th Floor Completed. Internal Plastering work : 18th Floor Completed. MEP Work : 15th Floor Completed. Tiling & Dado : 15th Floor Completed.
Tower C : Slab Work : 21st Floor Completed. Block Work : 19th Floor Completed. Internal Plastering work : 18th Floor Completed. MEP Work : 16th Floor Completed. Tiling & Dado : 15th Floor completed.

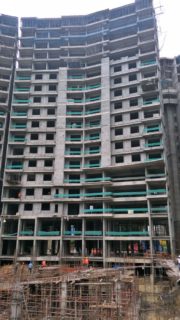

Tower D: Slab Work : 21st Floor Completed. Block Work : 16th Floor completed. Internal Plastering work : 16th Floor Completed. MEP Work : 15th Floor completed. Tiling & Dado : 12th Floor completed.

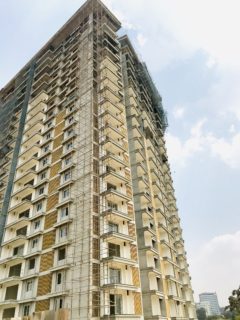

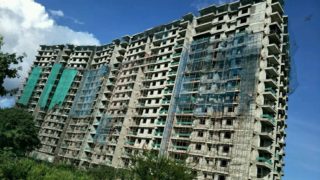

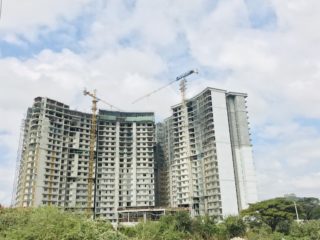

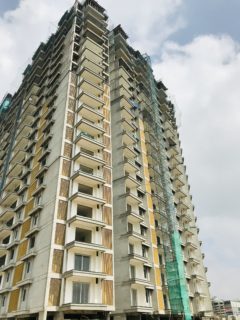

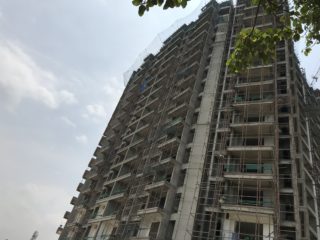

PROJECT PROGRESS REPORT AS ON 10th NOVEMBER 2019
What has been completed and is currently in Progress:
Tower A: Slab Work : Parapet work Completed. Block Work : 19th Floor Completed. Internal Plastering : 18th Floor Completed. MEP Work : 15th Floor Completed. Tiling & Dado : 14th Floor Completed.
Tower B : Slab Work : Parapet work Completed. Block Work : 19th Floor Completed. Internal Plastering work : 18th Floor Completed. MEP Work : 15th Floor Completed. Tiling & Dado : 13th Floor Completed.
Tower C : Slab Work : 21st Floor Completed. Block Work : 19th Floor Completed. Internal Plastering work : 18th Floor Completed. MEP Work : 15th Floor Completed. Tiling & Dado : 14th Floor completed.
Tower D: Slab Work : 21st Floor Completed. Block Work : 16th Floor completed. Internal Plastering work : 16th Floor Completed. MEP Work : 14th Floor completed. Tiling & Dado : 11th Floor completed.

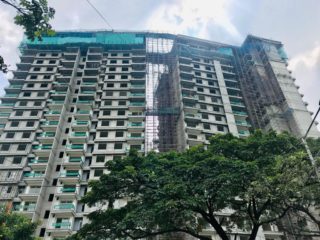

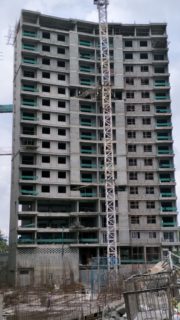

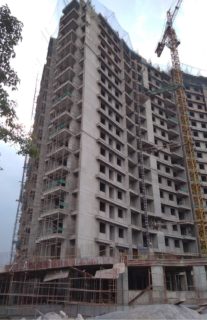

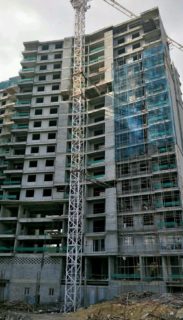

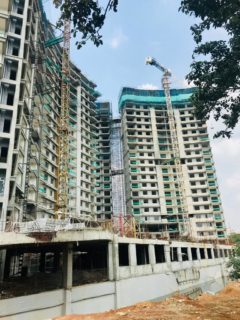

PROJECT PROGRESS REPORT AS ON 10th OCTOBER 2019

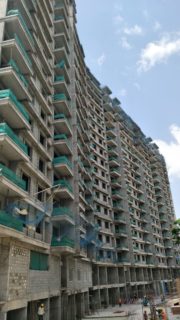

What has been completed and is currently in Progress:
Tower A: Slab Work : Terrace Floor Slab Completed. Block Work : 18th Floor Completed. Internal Plastering : 16th Floor Completed. MEP Work : 14th Floor Completed. Tiling & Dado : 12th Floor Completed.
Tower B : Slab Work : Terrace Floor Slab Completed. Block Work : 18th Floor Completed. Internal Plastering work : 17th Floor Completed. MEP Work : 14th Floor Completed. Tiling & Dado : 12th Floor Completed.
Tower C : Slab Work : 21st Floor Completed. Block Work : 18th Floor Completed. Internal Plastering work : 17th Floor Completed. MEP Work : 14th Floor Completed. Tiling & Dado : 13th Floor completed.

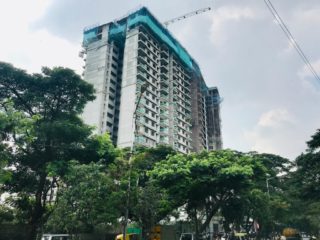

Tower D: Slab Work : 20th Floor Completed. Block Work : 16th Floor completed. Internal Plastering work : 16th Floor Completed. MEP Work : 14th Floor completed. Tiling & Dado : 9th Floor completed.

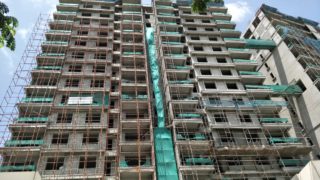

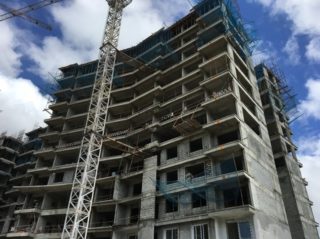

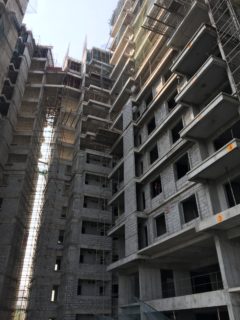

PROJECT PROGRESS REPORT AS ON 10th SEPTEMBER 2019
What has been completed and is currently in Progress:
Tower A: Slab Work: Terrace Floor Slab in Progress. Block Work: 18th Floor Completed. Internal Plastering: 16th Floor Completed. MEP Work : 14th Floor Completed. Tiling & Dado : 10th Floor Completed.
Tower B : Slab Work : Terrace Floor Slab in Progress. Block Work : 18th Floor Completed. Internal Plastering work : 16th Floor Completed. MEP Work : 14th Floor Completed. Tiling & Dado : 11th Floor Completed.
Tower C : Slab Work : 21st Floor Completed. Block Work : 17th Floor Completed. Internal Plastering work : 16th Floor Completed. MEP Work : 14th Floor Completed. Tiling & Dado : 11th Floor completed.
Tower D: Slab Work : 20th Floor Completed. Block Work : 16th Floor completed. Internal Plastering work : 16th Floor Completed. MEP Work : 14th Floor completed.

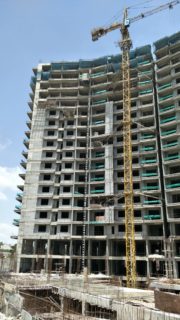

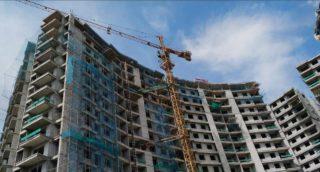

PROJECT PROGRESS REPORT AS ON 10th AUGUST 2019
What has been completed and is currently in Progress:
Tower A: Slab Work: 20th Floor Completed. Block Work: 17th Floor Completed. Internal Plastering: 15th Floor work Completed. MEP Work : 14th Floor Completed. Tiling & Dado : 9th floor work in progress.
Tower B : Slab Work : 21st Floor Completed. Block Work : 17th Floor Completed. Internal Plastering work : 15th Floor Completed. MEP Work : 14th Floor Work in Progress. Tiling & Dado : 9th floor work in progress.
Tower C : Slab Work : 21st Floor Completed. Block Work : 16th Floor Completed. Internal Plastering work : 15th Floor Completed. MEP Work : 14th Floor Work in Progress. Tiling & Dado : 1st to 8th Floor completed.
Tower D: Slab Work : 19th Floor Completed. Block Work : 16th Floor completed. Internal Plastering work : 15th Floor Completed. MEP Work : 14th Floor Work in Progress.

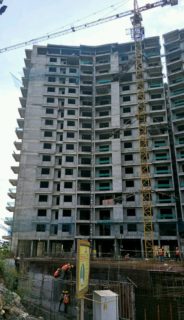

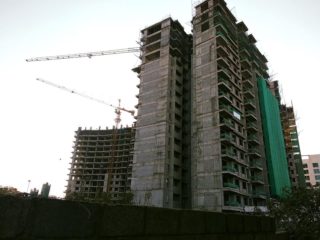

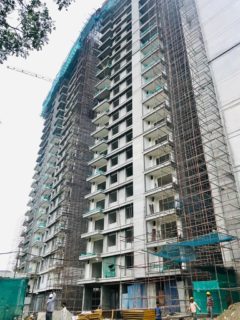

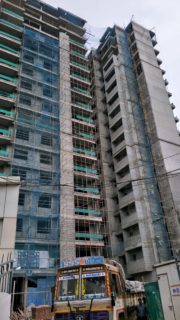

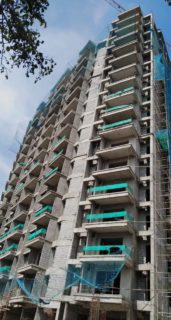

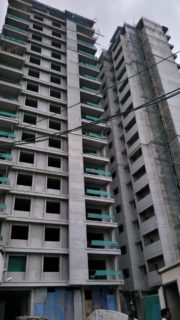

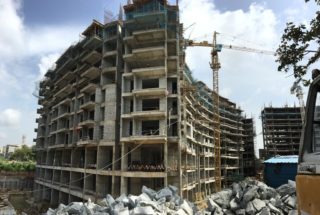

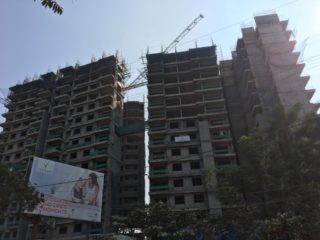

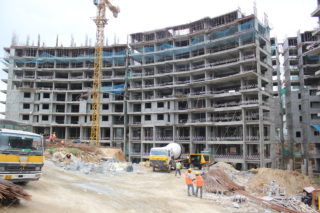

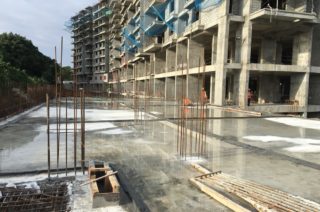

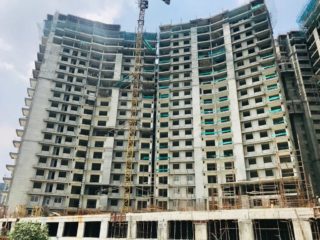

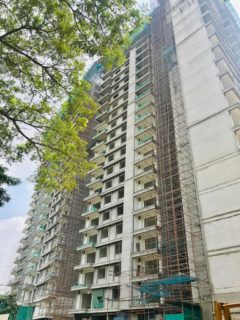

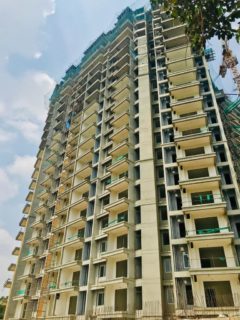

PROJECT PROGRESS REPORT AS ON 10th JULY 2019
What has been Completed and is currently in Progress:
Tower A: Slab Work: 19th Floor Completed. Block Work: 16th Floor Completed. Internal Plastering work: 15th Floor work Completed. MEP Work : 14th Floor Work in Progress. Tiling & Dado : 9th floor work in progress. Putty Work : 5th & 6th Floor Completed, 1st, 2nd & 7th Floor Work in Progress.
Tower B : Slab Work : 20th Floor Completed. Block Work : 16th Floor Completed. Internal Plastering work : 15th Floor Completed. MEP Work : 14th Floor Work in Progress. Tiling & Dado : 2nd to 8th floor completed, 9th floor work in progress. Marble Work : 2nd Floor Work in Progress. Putty Work : 2nd to 8th Floor Completed.
Tower C : Slab Work : 20th Floor Completed. Block Work : 16th Floor Completed. Internal Plastering work : 15th Floor work Completed. MEP Work : 14th Floor Work in Progress.Tiling & Dado : 1st to 8th Floor completed. Marble Work : 1st Floor Work in Progress. Putty Work : 1st to 7th Floor Completed.

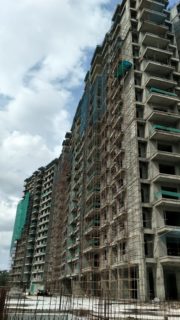

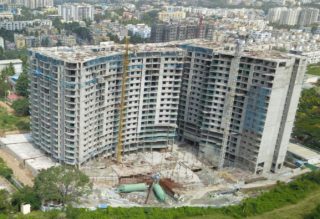

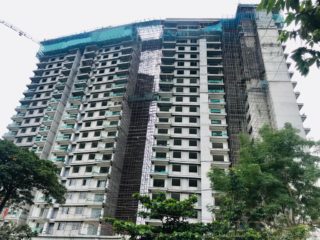

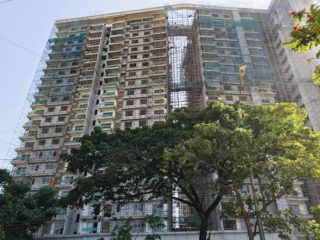

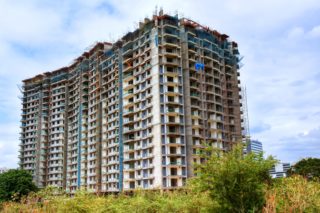

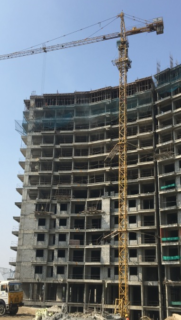

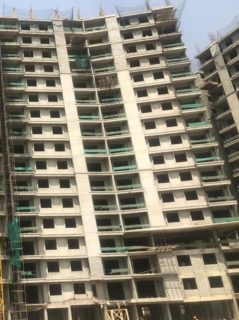

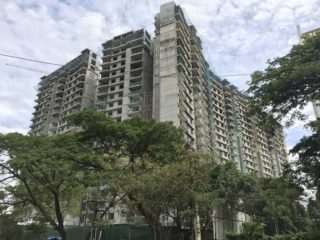

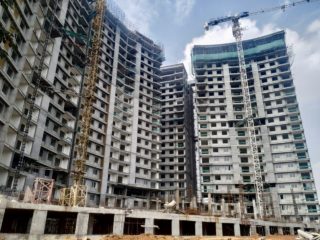

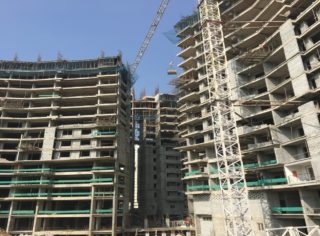

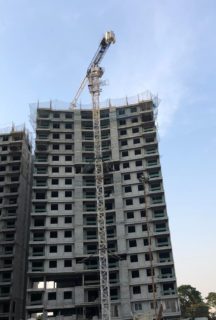

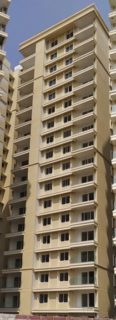

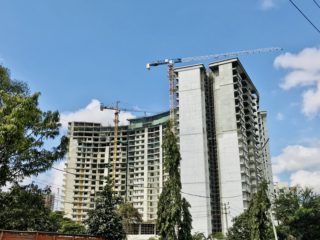

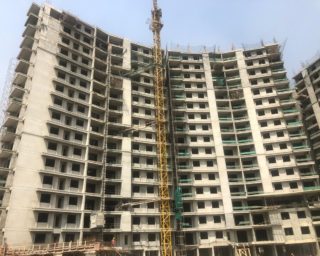

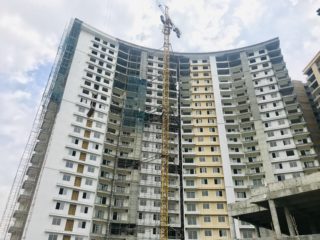

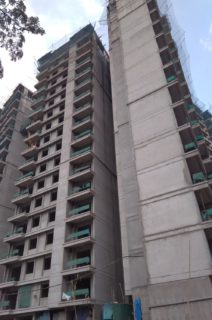

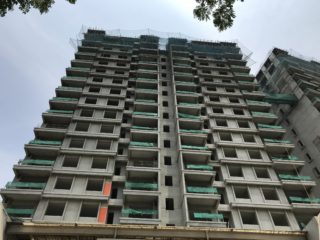

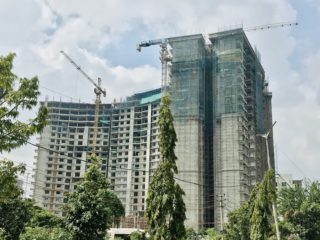

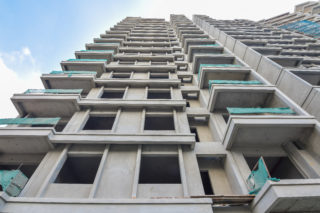

Tower D: Slab Work : 18th Floor Completed. Block Work : 16th Floor completed. Internal Plastering work : 15th Floor Completed. MEP Work : 1st to 7th Floor Work in Progress. Tiling & Dado : 1st to 4th Floor Work in Progress. Putty Work : 3rd to 5th Floor Completed.
PROJECT PROGRESS REPORT AS ON 10th June 2019
What has been Completed and is currently in Progress:
Tower A:
Slab Works: 18th Floor Slab Completed. Block Work: 16th Floor Completed. Internal Plastering work: 15th Floor work in progress. MEP Works: 14th Floor Work in Progress.Tiling & Dado: 1st to 8th floor completed, 9th floor work in progress. Marble Work : 2nd & 4th Floor Work in Progress, 3rd Floor Completed.Putty Works: 5th & 6th Floor Completed, 1st, 2nd & 7th Floor Work in Progress.
Tower B :
Slab Works: 18th Floor Completed. Block Work: 16th Floor Completed. Internal Plastering work: 15th Floor Completed. MEP Works: 14th Floor Work in Progress. Tiling & Dado: 2nd to 8th floor completed, 9th floor work in progress. Putty Works: 1st to 7th Floor Completed.
Tower C :
Slab Works: 19th Floor Completed. Block Work: 16th Floor Completed. Internal Plastering work : 15th Floor work in progress. MEP Works: 14th Floor Work in Progress. Tiling & Dado: 1st to 8th Floor completed. Putty Works: 1st to 5th Floor Completed.
Tower D:
Slab Works: 18th Floor Slab in Progress. Block Work: 16th Floor completed. Internal Plastering work: 15th Floor Completed. MEP Works: 14th Floor Work in Progress. Tiling & Dado: 1st to 4th Floor Work in Progress. Putty Works: 1st & 2nd Floor Completed.
PROJECT PROGRESS REPORT AS ON 10th MAY 2019
What has been Completed and is currently in Progress:
Tower A: Block Work: 16th Floor Completed. Internal Plastering work: 15th Floor work in progress. External Plastering work (Up to 13th Floor Level): Completed. MEP Works: 14th Floor Work in Progress. Tiling & Dado: 1st to 7th floor completed, 8th floor work in progress.
TOWER B : Block Work: 16th Floor Completed. Internal Plastering work: 14th Floor Completed. External Plastering work(Up to 13th Floor Level): Completed. MEP Works: 14th Floor Work in Progress. Tiling & Dado: 2nd to 8th Floor Completed. Slab Works: 18th Floor Completed.
TOWER C : Block Work: 16th Floor Completed. Internal Plastering work : 14th Floor Completed. External Plastering work: Completed. MEP Works: 14th Floor Work in Progress. Tiling & Dado:1st to 5th floor completed, 6th Floor Work in Progress. Slab Works: 18th Floor Completed.
Tower D: Block Work: 16th Floor completed. Internal Plastering work: 15th Floor Completed. External Plastering work: East, West & North Side Completed, South Side Work in Progress. MEP Works: 14th Floor Work in Progress. Tiling & Dado: 1st Floor Work in progress.

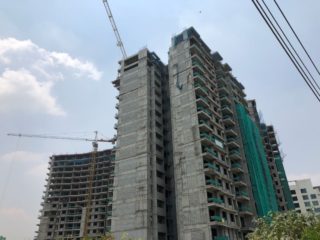

PROJECT PROGRESS REPORT AS ON 10th APRIL 2019
What has been Completed and is currently in Progress:
Tower A:
Block Work: 16th Floor Completed. Internal Plastering work: 15th Floor work in progress. MEP Works: 14th Floor Work in Progress.Tiling & Dado: 1st to 5th floor completed, 6th floor started.
TOWER B :
Block Work: 16th Floor Completed. Internal Plastering work: 14th Floor Completed. MEP Works: 14th Floor Work in Progress. Tiling & Dado: 2nd to 6th Floor Completed,7th Floor Work in Progress.
TOWER C :
Block Work: 16th Floor Completed. Internal Plastering work : 14th Floor Completed. MEP Works: 14th Floor Work in Progress. Tiling & Dado:1st to 3rd floor completed, 4th Floor Work in Progress.
Tower D:
Block Work: 16th Floor completed. Internal Plastering work: 15th Floor Completed. MEP Works: 14th Floor Work in Progress. Tiling & Dado: Yet to start.
PROJECT PROGRESS REPORT AS ON 10 MARCH 2019
What has been Completed and is currently in Progress:
Tower A:
Block Work: 16th Floor Completed. Internal Plastering work: 15th Floor work in progress. External Plastering work (Up to 13th Floor Level: East, West, North & South Elevation Completed. MEP Works: 14th Floor Work in Progress. Tiling & Dado: 1st, 2nd & 3rd Floor Work in Progress
TOWER B:
Block Work: 16th Floor Completed. Internal Plastering work: 14th Floor Completed. External Plastering work(Up to 13th Floor Level): East, West, North & South Elevation Completed. MEP Works: 14th Floor Work in Progress. Tiling & Dado: 1st, 2nd & 3rd Floor Work in Progress
TOWER C:
Block Work: 16th Floor Completed. Internal Plastering work : 13th Floor Completed, 14th Floor 95% Completed. External Plastering work: East, West, North & South Elevation Completed. MEP Works: 14th Floor Work in Progress. Tiling & Dado: 1st, 2nd & 3rd Floor Work in Progress
Tower D:
Block Work: 15th Floor completed, 16th Floor Work in Progress. Internal Plastering work 14th Floor Completed, 15th Floor Work in Progress. External Plastering work: East, West & North Side Completed, South Side Work in Progress. MEP Works: 13th Floor Work in Progress. Tiling & Dado: Yet to start
PROJECT PROGRESS REPORT AS ON 10 JANUARY 2019
What has been Completed and is currently in Progress:

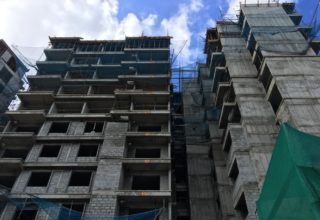

Tower A: Block Work – 16th Floor Completed. Internal Plastering work : 15th Floor work in progress. External Plastering work (Up to 13th Floor Level) East, West, North & South Elevation Completed.
Tower B: Block Work – 16th Floor Completed. Internal Plastering work – 14th Floor Completed. External Plastering work (Up to 13th Floor Level) – East, West, North & South Elevation Completed.
Tower C: Block Work – 16th Floor Completed. Internal Plastering work – 13th Floor Completed, 14th Floor 95% Completed. External Plastering work- East, West & North Elevation – Completed, South Elevation in progress.
Tower D Block Work- 15th Floor completed, 16th Floor Work in Progress. Internal Plastering work – 14th Floor Completed, 15th Floor Work in Progress. External Plastering work – West side Completed & East & North Side Work in Progress.

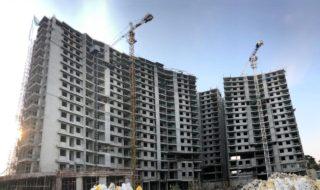

PROJECT PROGRESS REPORT AS ON 10th November 2018
What has been Completed and is currently in Progress:
Tower A: Block Work – 16th Floor 90% completed. Internal Plastering work: 14th Floor Completed. External Plastering work (Up to 13th Floor Level) – East, West & North Elevation – Completed, South Elevation 90% Completed.
Tower B: Block Work- 16th floor 80% completed. Internal Plastering work – 14th Floor Completed. External Plastering work(Up to 13th Floor Level) South & North Elevation 90% Completed, East & West Side Elevation completed.
Tower C: Block Work – 16th Floor – 80% completed. Internal Plastering work – 13th Floor Completed, 14th Floor 75% Completed. External Plastering work – North & East Elevation – Completed, West & South Elevation is in progress.
Tower D: Block Work – 15th Floor Completed. Internal Plastering work – 12th Floor Completed, 13th Floor 65% Completed. External Plastering work – West Elevation 50% Completed, East-Staging Erection in Progress

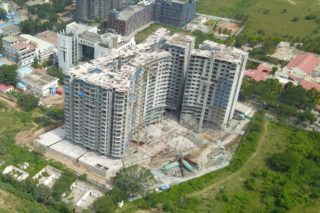

PROJECT PROGRESS REPORT AS ON 10th October 2018
What has been Completed and is currently in Progress:
Tower A:
Block Work – 15th Floor Completed, 16th Floor is in progress. Internal Plastering work: 14th Floor Completed External Plastering work (Up to 13th Floor Level) – East, West & North Elevation Completed, South Elevation is in progress.
Tower B:
Block Work- 15th Floor Completed. Internal Plastering work – 14th Floor Completed. External Plastering work(Up to 13th Floor Level) South & North Elevation 85% Completed, East Elevation completed & West Elevation is in progress.
Tower C:

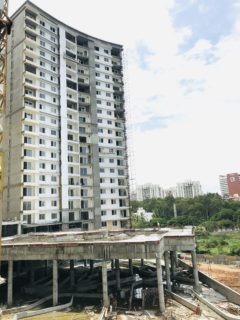

Block Work – 15th Floor Completed. Internal Plastering work – 11th Floor Completed, 12th Floor is in progress. External Plastering work – North & East Elevation – Completed, West Elevation is in progress.
Tower D:
Block Work – 15th Floor Completed. Internal Plastering work – 11th Floor Completed, 12th Floor is in progress. External Plastering work – West Elevation is in progress
PROJECT PROGRESS REPORT AS ON 7th SEPTEMBER 2018
1. Block work :
Tower A & B: 15th Floor Completed
Tower C & D: 14th Floor Completed, 15th Floor is in progress
2. Internal Plastering :
Tower A: 14th Floor Completed
Tower B: 12th Floor Completed
Tower C: 10th Floor Completed
Tower D: 10th Floor Completed
3. External Plastering
Tower A: East, West & North Elevation has been completed upto 13th Floor, South Elevation is in progress
Tower B: South & North Elevation 85% Completed, East & West Elevation is in progress
Tower C: North Elevation is completed up to the 13th Floor, East & West Elevation is in progress

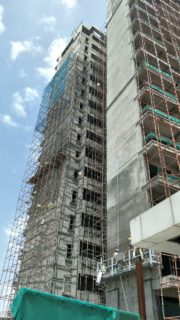

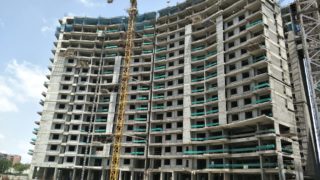

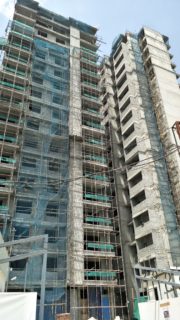

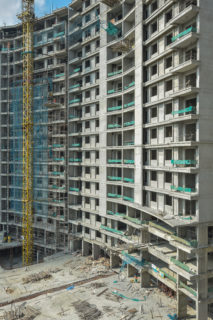

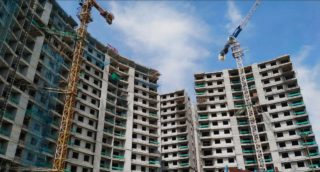

PROJECT PROGRESS REPORT AS ON 10th July 2018
What has been Completed and is currently in Progress:

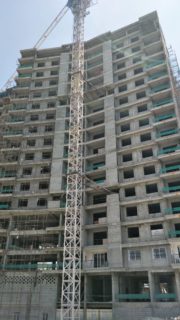

Tower A: 17th Floor slab work is completed, 15th Floor Masonry work is completed, 13th & 14th Floor plastering work is in progress.
Tower B: 17th Floor slab work is completed, 15th Floor Masonry work is completed, 11th Floor plastering work is in progress.
Tower C: 17th Floor slab work is completed, 13th Floor Masonry work is in progress, 8th Floor plastering work is in progress.
Tower D: 17th Floor slab work is completed, 12th Floor Masonry work is in progress, 8th & 9th Floor plastering work is in progress.

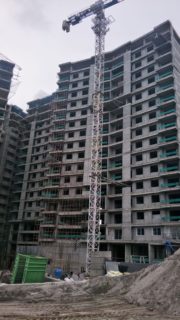

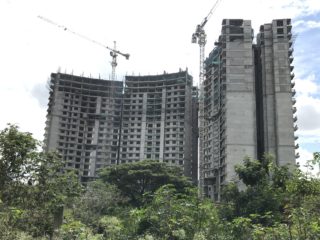

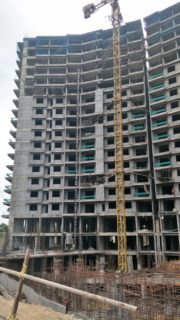

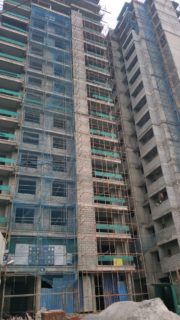

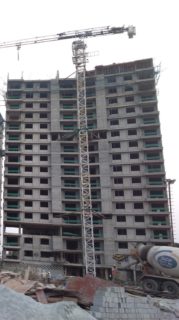

PROJECT PROGRESS REPORT AS ON 11th June 2018
Tower A: 17th Floor slab work is completed, 15th Floor Masonry work is completed, 12th Floor plastering work is in progress.
Tower B: 17th Floor slab work is completed, 14th Floor Masonry work is in progress, 9th Floor plastering work is in progress.
Tower C: 17th Floor slab work is completed, 12th Floor Masonry work is in progress, 7th Floor plastering work is in progress.
Tower D: 17th Floor slab work is completed, 11th Floor Masonry work is in progress, 7th & 8th Floor plastering work is in progress.
Podium 11 & 12 – Casting is in progress for 2 Ramps.
Podium 3: 1st Floor (Level3) Shuttering work is in progress.
PROJECT PROGRESS REPORT AS ON 11th APRIL 2018
Tower A: 17th Floor slab work is completed, 15th Floor Masonry work is in progress, 12th Floor plastering work is in progress.
Tower B: 17th Floor slab work is completed, 11th Floor Masonry work is in progress, 9th Floor plastering work is in progress.
Tower C: 17th Floor slab work is completed, 11th Floor Masonry work is in progress, 7th Floor plastering work is in progress.
Tower D: 17th Floor slab work is completed, 9th Floor Masonry work is in progress, 6th Floor plastering work is in progress.

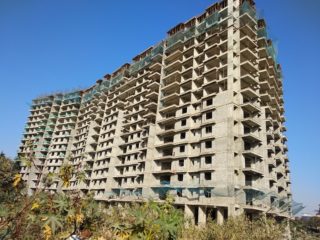

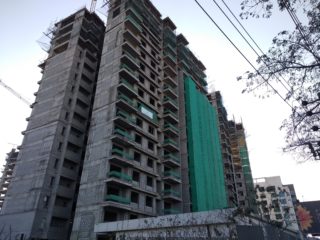

PROJECT PROGRESS REPORT AS ON 6th FEBRUARY 2018

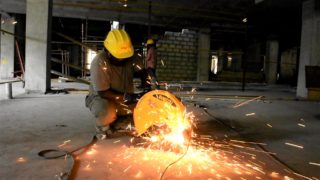

Tower A: 17th Floor slab completed. 13th Floor masonry work is in progress. 9th Floor internal plastering work is in progress. The external painting has commenced.
Tower B: 16th Floor slab is casted & column casting is in progress. 8th Floor masonry work is in progress. 7th Floor Internal plastering work is in progress
Tower C: 16th Floor slab is casted & column casting is in progress. 9th Floor masonry work is in progress. 5th Floor internal plastering is in progress.
Tower D: 16th Floor slab casting is in progress, 6th Floor masonry work is in progress, 5th Floor internal plastering is in progress.
Podium 3: 2nd Level completed
Podium 1, 2, 4, 5, 8, 14 & 15 is on 1st Level
PROJECT PROGRESS REPORT AS ON 10TH JANUARY 2018
Tower A: 17th Floor shuttering & rebar work is in progress. 11th Floor masonry work is in progress. 6th, 7th & 8th Floor internal plastering work is in progress.
Tower B: 15th Floor slab is casted & column casting is in progress. 7th & 8th Floor masonry work is in progress. 4th, 5th & 6th Floor Internal plastering work is in progress
Tower C: 15th Floor slab is casted & column casting is in progress. 7th,8th & 9th Floor masonry work is in progress. 4th & 5th Floor internal plastering is in progress.
Tower D: 15th Floor slab casting is in progress, 6th Floor masonry work is in progress, 3rd & 4th Floor internal plastering is in progress.

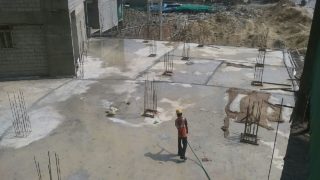

Podium 8: Slab is casted

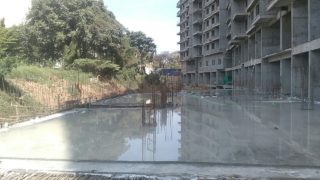

Podium 5: 1st Level Slab is casted
What has been completed and is in progress:
Tower A: 15th Floor slab work is completed, 8th Floor masonry work is in progress. Internal plastering is on the 4th Floor
Tower B: 14th Floor slab work is completed, 6th/7th Floor masonry work is in progress. Internal plastering is on 2nd Floor
Tower C: 14th Floor slab is casted, 6th-floor masonry work is in progress. Internal plastering is on 3rd Floor
Tower D: 14th Floor slab is in progress, as is the 5th Floor masonry work. Internal plastering is on 3rd Floor.
Tower A: 12th Floor slab casted, 5th Floor Masonry work is in progress, 3rd Floor Plastering work is in progress.
Tower B: 11th Floor slab casted, 5th Floor Masonry work is in progress, 2nd Floor Plastering work is in progress.
Tower C: 11th Floor slab casted, 4th Floor Masonry work is in progress, 3rd Floor Plastering work is in progress.
Tower D: 11th Floor slab work is in progress, 5th Floor Masonry work is in progress, 3rd Floor Plastering work is in progress.
Podium West (Zuri side): Casted one pour of slab of the upper basement floor slab
What has been Completed and is currently in Progress:
Completed :
Tower A – 9th-floor slab completed
Tower B, C & D – 8th Floor slab completed.
In Progress:
Tower A – Shuttering for the 10th Floor
Tower B, C& D – Shuttering for the 9th floor
Podium –
Western Side – 1st Slab completed
Southern Side – Foundation work in progress
